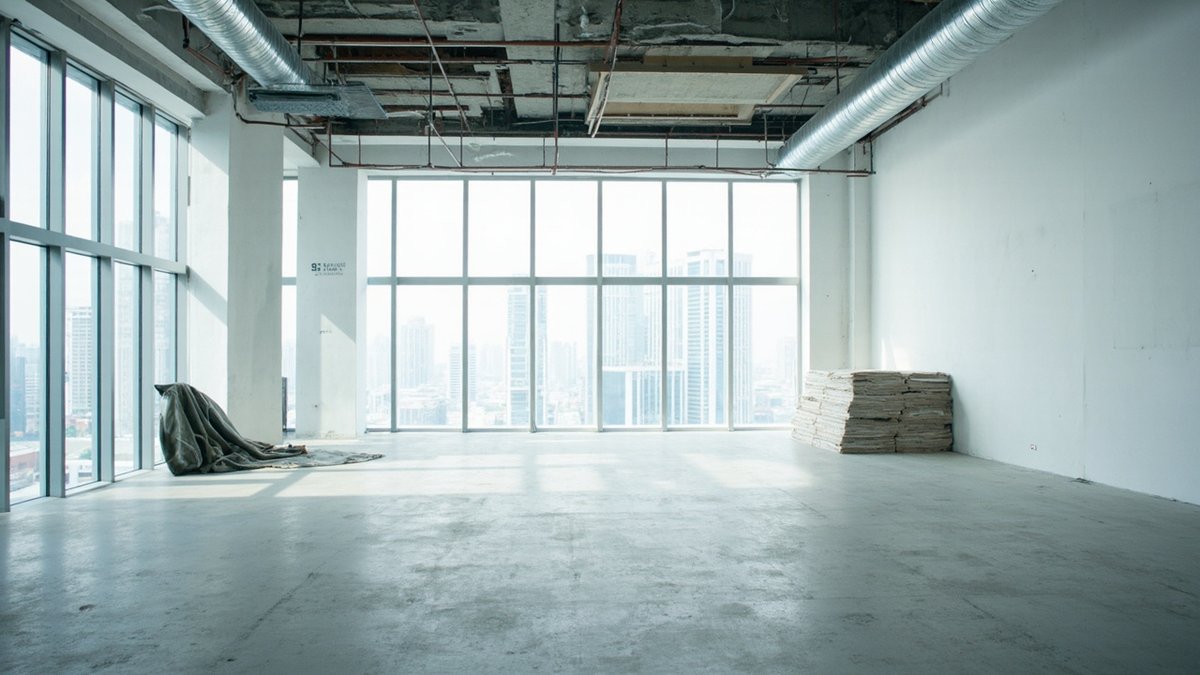

Handing back an office at lease end? We strip out, make good and clean the unit back to its original handover condition — done inside your notice period so you protect your deposit, not lose it.
📍 We serve KL, Selangor & Putrajaya.

When a company’s office lease ends, the tenant almost always has to hand the unit back in the condition it was received — a bare, empty shell stripped of everything the tenant added. That obligation is called reinstatement, or “make good,” and it is the exact reverse of the fit-out you did on the way in. Everything the fit-out created — the partitions, the carpet, the suspended ceiling, the signage, the extra power and data points, the pantry plumbing — comes back out, and the walls, floor and ceiling are made good to their original state. It is not the same as cleaning up and moving out; a “broom-clean” office with the partitions still standing has not been reinstated. Understanding that early matters, because reinstatement is real construction work with a real cost, and it is due at the worst possible time — when you are also paying to move.
Reinstatement exists to protect the landlord’s asset. A landlord wants to hand the next tenant a clean, neutral shell they can fit out to their own design — not a space carrying your logo, your partition layout and your worn carpet. So the tenancy agreement carries a make-good clause requiring you to remove your alterations and restore the original condition before the term ends. If you do not, the landlord is entitled to do it for you and deduct the cost — from your security deposit, and beyond it if the works cost more than the deposit held. The specifics vary from lease to lease, which is why the make-good obligation should be read carefully when you sign, and again well before you leave; the broader tenant-and-landlord obligations are set out in our commercial property tenancy guide. The moment to shape this liability is at signing, not at exit — that is when you can negotiate the clause: cap it to your own alterations, agree that useful improvements (extra power points, a decent ceiling) can stay, or record that certain existing conditions are not yours to restore. A make-good clause read for the first time on the way out is a clause you have already lost the leverage to soften. Treat it as a real, budgeted liability from day one, not fine print.
The fairest way to settle “what was the original condition?” is to have written it down at the start. A schedule of condition is a dated, photographed record of the unit’s state at handover — ideally taken before you fit out. At lease end, a dilapidation assessment compares the unit against that record to define exactly what has to be reinstated and what was there all along. Without a schedule of condition, disputes turn into one word against another, and the tenant usually loses, because the burden falls on you to prove the wall was already marked. If you never took one, the next best thing is a thorough condition inspection with photos before you start stripping out, plus any handover photos you can dig up. Documenting condition is the cheapest insurance in the whole process, and the step tenants most often skip.
A standard office reinstatement bundles several trades into one sequenced job. The exact list follows what your fit-out added, but it usually looks like this:
| Work item | What is involved | Notes |
|---|---|---|
| Partition strip-out | Remove glass, gypsum or brick partitions | Back toward the original open plan |
| Ceiling removal | Take down suspended ceiling & tiles | Expose services / base ceiling |
| Flooring | Lift carpet, vinyl or raised floor; remove adhesive | Back to bare screed |
| M&E disconnection | Isolate & cap power, data, aircon & plumbing points | Licensed trades — not DIY |
| Making good | Patch walls, floors & ceiling to handover state | Fill, skim, level |
| Repaint | Walls & ceiling to the original colour | As the lease specifies |
| Signage & branding removal | Strip logos, lightboxes & decals | Make good the fixings |
| Final cleaning & disposal | Post-strip clean + cart debris to a licensed tip | Handover-ready condition |
WhatsApp us your job details — we reply within the hour with a free quote.
💬 Get Your Free QuoteThe M&E line is the one tenants underestimate: disconnecting and capping power, data and air-conditioning points is licensed work, not something to hack out over a weekend, and doing it wrong can leave live services or a failed hand-back.
Want a first budget before you ask for quotes? Our Office Reinstatement Cost Calculator multiplies your office area by the per-sq-ft range for the reinstatement scope — a planning range, not a quotation.
Reinstatement is usually priced per square foot of the leased area, banded by how much has to come out (market estimate 2026, indicative Klang Valley):
| Scope level | Indicative cost | Typical of |
|---|---|---|
| Light make-good | RM3 – RM6 per sq ft | Mostly repaint, minor patching & a clean |
| Standard reinstatement | RM6 – RM12 per sq ft | Strip partitions, ceiling & carpet; cap M&E; repaint |
| Heavy strip-out to bare shell | RM12 – RM20+ per sq ft | Extensive partitions, feature works, heavy M&E |
On a modest office the total is a few thousand ringgit; on a large, heavily built-out floor it can run well into five figures, which is exactly why it belongs in your exit budget from the day you give notice. Get the scope quoted against your actual fit-out and the schedule of condition — a number quoted blind, without a site look, is a number that grows once the ceiling comes down.
Two offices of the same size can reinstate for very different sums, and the drivers are predictable. The biggest is how much you built: a light fit-out with a few partitions strips out cheaply, while a heavy build with full-height glass, raised flooring, a fitted pantry and extensive cabling is a major demolition. M&E complexity adds cost because capping services is licensed, careful work. Building access matters — a high floor with a single service lift, strict loading-bay hours and a no-noise-in-office-hours rule forces slower, after-hours work at a premium. Debris volume drives disposal cost, charged by the lorry load to a licensed tip. And condition counts: damage beyond fair wear — a cracked slab, water-stained ceiling or holes in a structural wall — is extra making-good on top of the strip-out, and it is often where a landlord and tenant disagree, since fair wear-and-tear is not the tenant’s to restore but damage is. Working level can push the price too: an office three floors up with a service lift and after-hours-only access is slower and dearer than a ground-floor unit you can strip and load straight out. Timeline pressure is the multiplier over all of it: a rushed reinstatement crammed into the last few days always costs more than a planned one, because premium after-hours labour and last-minute disposal have no room to be negotiated.
The single most expensive mistake in reinstatement is timing. The works must be finished and the unit handed back by the lease-end date — if you run over, you are usually liable for holdover rent, effectively paying for an office you have already left while you finish stripping it. The fix is to plan the reinstatement into your notice period from the start: book the contractor early, agree the scope, and sequence the strip-out to overlap with your move rather than start after it. In a live office building, much of the noisy, dusty work has to happen after hours or at weekends to satisfy the building’s rules and avoid disturbing other tenants — and lift bookings and loading access have to be arranged with the management office in advance. Any works notification or permit the building requires should be sorted early too; our commercial renovation permit guide covers how building approvals for fit-out and strip-out work. Start late and every one of these becomes a scramble at premium rates.
“Reinstatement deposit” is the money held against your make-good obligation. In many office leases that role is played by the security deposit: if the unit is not handed back in its original condition, the landlord carries out the reinstatement and deducts the cost from it, and can claim beyond it if the works cost more than the deposit held. Some leases or building managements describe a separate sum for this purpose, so read the clause to see which deposit is at stake and what has to happen before it is released, usually a joint final inspection and sign-off.
In Malay, tenancy documents and quotes often keep the English word “reinstatement”; the meaning is returning the premises to their original handover condition (mengembalikan premis kepada keadaan asal). Whatever the wording, the deposit comes back in full when the agreed scope is finished on time, photographed, and signed off.
Reinstatement disputes are almost always about evidence and scope, not effort. Protect yourself with three habits. First, agree the scope in writing with the landlord or managing agent before you start — walk the unit together, confirm what must come out and what stays, and get it on paper so “make good” is not reinterpreted after the fact. Second, photograph everything — the original schedule of condition, the state before you strip, and the finished hand-back — so you can prove the unit was returned as agreed. Third, get the landlord’s sign-off on completion, ideally a joint final inspection, so the deposit release is not left hanging on a later complaint. This is the commercial cousin of a residential deposit fight; the same evidence-first logic that protects a residential tenant, set out in our turnover repair guide and the broader tenancy guide, is what gets a commercial deposit back in full.
For a tiny office with a couple of freestanding partitions, an in-house clear-out and repaint might genuinely be enough. For anything with built partitions, a suspended ceiling, fitted flooring or altered M&E, reinstatement is a coordinated construction job, and a single contractor is almost always the cheaper path once you account for the risk. One team sequences the strip-out, brings the licensed trades to cap M&E, makes good, repaints, cleans and disposes of the debris — on a schedule that fits your notice period — and hands you the photo record for the deposit. Trying to assemble that yourself, trade by trade, under move-out time pressure is exactly how deadlines slip into holdover rent. For larger commercial works you may also want a contractor with the right registration; our CIDB contractor guide explains when that matters. The building-maintenance hub covers how the same team can also look after the next fit-out.
If you are looking for an “office reinstatement contractor” as your lease end approaches, check these points before you appoint one. A good contractor:
The deposit losses we see are nearly all avoidable. Leaving reinstatement to the final week, so the job runs into holdover rent. Never agreeing the scope, so “make good” gets interpreted more harshly than you assumed. Skipping photos, so you cannot prove pre-existing damage was not yours. Mishandling the M&E — leaving points live or badly capped — which fails the hand-back inspection. Dumping the strip-out debris improperly instead of carting it to a licensed tip. And the classic: assuming a good final clean is enough when the lease actually required the partitions and ceiling out. Each of these turns a manageable, budgeted job into a deducted deposit and an argument. Plan it early, document it, and treat make-good as the construction project it is — and the deposit comes back.
ClickBina handles office reinstatement and make-good across Kuala Lumpur and Selangor as a single, sequenced job — strip-out of partitions, ceiling and flooring, M&E disconnection through licensed trades, making good, repaint, final cleaning and licensed debris disposal — planned inside your notice period so you avoid holdover rent, and documented with before-and-after photos so your deposit comes back. Because we also do office fit-out and ongoing building maintenance, we know both ends of the lease. Budget it with our free cost tools, then send us the unit size, the floor and a few photos on WhatsApp — we reply within the hour with an honest scope and quote.
WhatsApp us your job details for a free quote — we reply within the hour.
💬 Get a Free QuoteHow we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.
