A box gutter overflows into the building, not down the wall — here is how to tell a capacity problem from a hole, when lining is the right answer, and the ponding test that proves the repair.
📍 We serve KL, Selangor & Putrajaya.

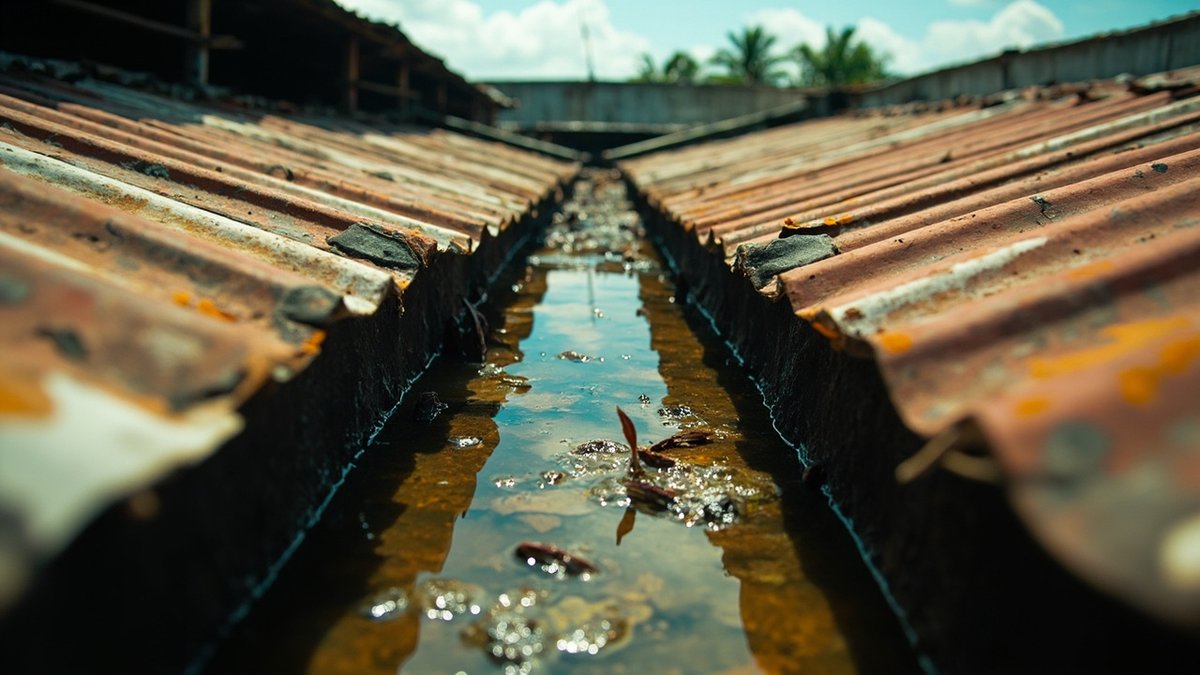

A box gutter is a rectangular channel formed within the roof rather than hung off its edge — between two roof planes that fall towards each other, along a parapet, or in the valley between two adjoining factory bays. On a warehouse or a factory it is usually a wide steel channel sitting on the purlins, with the roof sheets lapping into it on both sides and outlets dropping through to downpipes.
The critical consequence is where the water goes when things go wrong. An eaves gutter that overflows spills down the outside of the building and stains a wall. A box gutter that overflows spills inside the building — over its inner upstand, under the roof sheets, and straight onto whatever is below: production lines, racking, finished goods, electrical panels. That is why a box gutter problem in a factory is an operations problem rather than a maintenance one, and why it deserves a different level of attention from the same problem on a house. For the domestic and eaves-gutter version of this subject, our gutter and downpipe repair guide is the right starting point, and gutter types covers the profiles.
Three of the failures above are structural rather than maintenance, and they are worth separating out because they change what you should buy.
Undersizing shows itself by overflowing along the whole run, or at the far end from the outlets, during heavy rain, while draining normally afterwards. Cleaning will not help; the answer is more outlet capacity, larger outlets, or a larger gutter section. Adding tapered or sumped outlets — where the gutter sole is dished down into a wider throat at the outlet — often buys a large improvement without rebuilding the gutter, because a flat-bottomed hole in a gutter sole discharges far less than its diameter suggests.
Ponding shows itself as standing water and a tidemark of silt after the roof has dried. It is a fall and support problem: brackets, bearers or the purlin line have to be adjusted so the sole runs downhill to the outlets. Lining a ponding gutter without correcting the fall gives you a watertight pond rather than a working gutter, and the water still sits on the new membrane permanently.
The missing overflow is the cheapest thing on this page and the most valuable. An emergency overflow is a slot, scupper or spout through the outer face of the gutter, set above the normal running water level but below the inner upstand, so that if an outlet chokes the water discharges harmlessly outside the building instead of over the inside edge. On an internal box gutter over a production area it is the single detail that decides whether a blocked outlet is a mess on the ground outside or a stopped production line.
| What you see | Most likely cause | Check first |
|---|---|---|
| Water pours in along the gutter line only during heavy rain, stops within minutes | Capacity or blockage — overflow, not a hole | The outlets, in rain, from the roof |
| Slow dripping that continues for hours after rain | Perforation or a failed joint, with ponded water feeding it | Standing water in the gutter after the roof has dried |
| Overflow at the far end from the outlets | Not enough fall, or not enough outlet capacity | Where the water sits when the rain stops |
| Rust stains and drips on the underside of the gutter, visible from inside | Perforated sole | The sole from above, under the silt |
| Leak appears just inboard of the gutter, under the roof sheets | Capillary or wind-driven water back up the sheet lap | Sheet lap length into the gutter and any closure at the lap |
| Water at a single point that repeats after every patch | A joint working with thermal movement | The joint detail: lapped, riveted, welded or strapped |
| Silt tidemark and vegetation growing in the gutter | Permanent ponding | Fall, supports and sagging between purlins |
| Flooding inside after a dry spell followed by a first storm | Debris accumulated during the dry spell blocking outlets | Whether anyone cleared the gutter before the monsoon |
WhatsApp us your job details — we'll reply as soon as we can with a free quote.
RM180 for the inspection visit. If you go ahead with the repair, we'll give you a discount. To quote faster, tell us your area, property type and the size or quantity.
💬 Get Your Free QuoteThere are four honest options and they are not interchangeable.
The decision test is not a number, it is three questions. Is the gutter big enough for its catchment? Does it fall to its outlets? Is the steel still sound enough to carry a membrane — that is, is it firm underfoot with no perforation over any length? Three yeses point at a liner. Any no points at correcting that thing first, and if the answer to the first question is no, a liner is the wrong purchase entirely.
Liners are sold well and it is worth being clear about their limits. A liner does not add capacity — a gutter that overflows because it is undersized will overflow just as reliably once lined. A liner does not create fall; laid over a ponding gutter it gives you a waterproof pond, and permanent standing water is hard on every coating system. A liner does not create an overflow, so a blocked outlet still floods the building. A liner cannot bridge a hole in a sole that is no longer sound — the substrate has to carry it. And a liner does not fix water that is being drawn back up under the roof sheets by capillary action, because that water never enters the gutter channel at all. If a quote proposes a liner without mentioning outlets, falls and overflow, ask why.
Used within its limits, though, a lined gutter is an excellent outcome for a factory: it is applied without cutting the roof open, it needs no hot work if a cold-applied system is chosen, and it can usually be done bay by bay around production. Where a sheet system is preferred instead, torch-on membrane covers how that is laid and what it needs from the substrate.
Cleaning and outlet work are small; lining and replacement are priced by area and by access (market estimate 2026, indicative Klang Valley except where marked as ours):
| Work | Indicative price | What it covers |
|---|---|---|
| Leak detection & assessment | RM300 – RM800 per visit | ClickBina price for leak detection and assessment, charged separately from the repair — an industrial roof needing access equipment is surveyed at a price agreed per site |
| Tiled / metal roof repairs | RM500 – RM3,000 per job | market estimate — clearing, outlet work, local patching and joint repairs |
| Liquid PU membrane | RM10 – RM18 per sq ft | market estimate — seamless liner, the usual choice for a gutter |
| Torch-on bituminous membrane | RM8 – RM15 per sq ft | market estimate — sheet membrane liner; needs a naked flame on site |
| Flexible two-part membrane | RM8 – RM14 per sq ft | market estimate — where the gutter is concrete rather than steel |
Liner work is measured on the developed girth of the gutter, not on its plan length — that is, up one upstand, across the sole and up the other side. A 30 m run with a girth of about 1.2 m is therefore roughly 390 square feet of membrane, which at the liquid PU band is about RM3,900 – RM7,020 and at the torch-on band about RM3,120 – RM5,850 (market estimate 2026, indicative Klang Valley), before access, preparation and outlet work. Use that as a sanity check on a quote, not as a quotation: on a live factory, access, edge protection and working around production frequently cost more than the membrane. Gutter replacement and new outlet or overflow formation are quoted per project after a roof inspection, because they depend on the profile, the purlin arrangement and where the water can be taken to. For the roof either side of the gutter, see factory and warehouse roof waterproofing.
| Line item | Why it matters |
|---|---|
| Linear metres of gutter and the developed girth | Girth is what the membrane is measured on; a quote without it cannot be compared |
| Number, size and condition of outlets | The most common real cause, and the cheapest thing to get right |
| Whether outlets are re-formed or sumped | A dished, tapered throat discharges far more than a flat hole of the same diameter |
| Emergency overflows: number, size, position | The detail that decides whether a future blockage floods the building |
| Fall correction and re-support | Skipping this is why liners fail early |
| Surface preparation and rust treatment | Grinding, wire brushing, degreasing, priming — state which |
| Membrane system, number of coats and thickness | “PU coating” alone is not a specification |
| Reinforcement at laps, joints, corners and outlets | Fabric-reinforced detailing is where a liner earns its money |
| Roof sheet interface: how far the liner is taken under the sheets | Stopping at the sheet edge leaves the capillary path open |
| Access: edge protection, harness points, crawl boards, MEWP | On an operating factory roof this is a major line, not a footnote |
| Working hours: production, shutdown, night or weekend | Changes the price materially and should be agreed up front |
| Protection of stock and machinery below | Debris removal from a gutter drops material through every gap |
| Whether hot work is involved | Torch-applied systems need a naked flame; many operators restrict or prohibit it |
| Water test before handover | Name it as a line item with a stated duration |
Three constraints dominate the programme on a factory roof and all three belong in the quote rather than in a conversation on the day.
Access and safety. A box gutter is walked, not viewed, and the roof sheets either side of it will not necessarily carry a person between purlins. That means crawl boards, harness anchor points and edge protection, plus a means of getting materials up. On a tall building a mobile platform may be needed at the gable ends. None of this is optional and all of it costs money.
Production continuity. Clearing a gutter drops silt and debris through every gap in the sheeting onto whatever is below. Grinding and preparation do the same with rust and dust. Where the area below is a production line, a store of finished goods or food handling, the work has to be phased, sheeted below, or moved to a shutdown, and that is a scheduling decision to make before the quote is accepted.
Weather. Liquid membranes need a dry, clean, prepared substrate and an uninterrupted cure window, and a gutter is the last part of a roof to dry. In the monsoon the practical pattern is early starts, short bays completed and closed within the day, and temporary covering over prepared but uncoated sections. Anyone willing to coat a wet gutter is selling you a repeat visit.
Box gutter problems compound faster than most roof problems because the water never leaves. Standing water and silt corrode the sole from above while condensation works on it from below, so a gutter that has pinholes this year has perforation next year. The purlins and bearers under the gutter get wet every time it rains and start to corrode at the fixings, which is what turns a lining job into a replacement job. Meanwhile the overflow itself is doing the damage that costs real money: wet stock, corroded racking, water near electrical panels, wet floors in circulation areas, and production stopped during exactly the storms when nobody wants to be dealing with it. The cheap interventions here — clearing outlets, adding an overflow — are worth doing on their own even if the full repair has to wait for a budget cycle.
A gutter is one of the few parts of a roof that can be tested properly, because it is a channel that can be filled. Insist on it.
Box gutters should be cleared at least twice a year, and specifically before the year-end monsoon. On sites with trees nearby, heavy airborne dust, or plastic film and packaging in use, quarterly is more realistic. The visit should clear all debris and silt, flush and rod every outlet, check the overflow is clear, look for standing water once the flushing water has drained, and photograph the whole run. That last point matters: a dated photographic record of the gutter each year is what turns “it has always been like that” into an evidenced trend, and it is the cheapest asset-management tool a factory roof has. Gutter cleaning covers the routine version of that visit.
