Building Facade Waterproofing Malaysia 2026: Cost & Guide
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Building Facade Waterproofing
in Malaysia (2026)

External walls at height — why facades leak into multiple units, rope access vs gondola vs scaffolding, coating & sealant cycles and per-project quotes from a Klang Valley contractor.

📍 We serve KL, Selangor & Putrajaya.

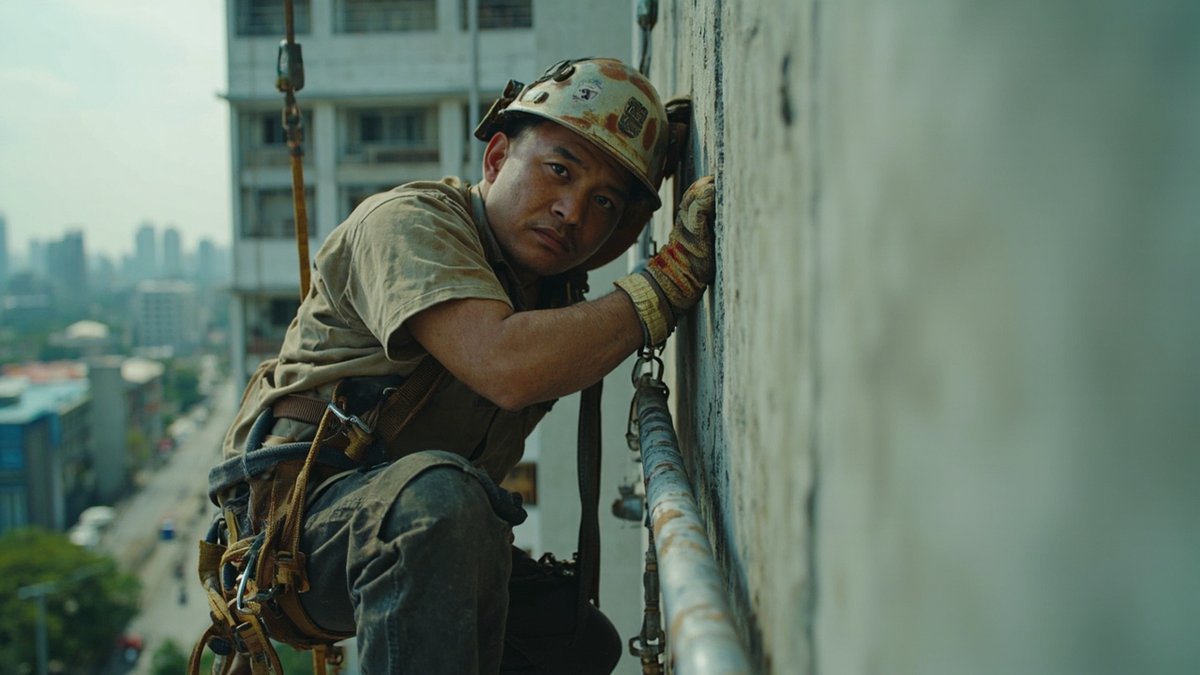

Rope-access worker inspecting and repairing a high-rise building facade wall with a city skyline behind
Building facade waterproofing in Malaysia is quoted per project — unlike rooftops at RM8–RM20 per sq ft, facade pricing is driven by the access method (rope access, gondola or scaffolding), the height, and the measured mix of crack repair, joint sealant and elastomeric coating (indicative 2026, Klang Valley). When several units on different floors report seepage after rain, the facade — not the individual units — is usually the patient, and it is a building-level programme, not a unit-by-unit repair.

How facades let water in

An external wall fails in more ways than a roof. Hairline cracks in render open and close with thermal movement; expansion-joint sealant hardens and pulls away; window perimeters lose their seal; paint film ages, chalks and stops shedding water; and poorly compacted concrete leaves porous patches that drink rain. None of these leak in a drizzle — the trigger is the Malaysian storm, where wind drives rain horizontally against a whole elevation for an hour and pressurises every defect at once. Water that enters tracks along beams and slab soffits and can surface metres from the defect, which is why chasing facade leaks from inside a unit so often fails. Our external wall seepage guide covers the diagnosis in detail, and the wall waterproofing guide the repair options at ground level.

Signs a facade programme is due

Single defects justify spot repairs from a rope crew; a pattern justifies a programme. The signals committees and building owners should watch for: the coating is 8–10+ years old and chalks on your hand; map cracking is visible across whole panels rather than one spot; paint bubbles or peels inside multiple units after rain; efflorescence — white salt streaks — runs below joints; sealant lines are cracked, hardened or missing in stretches; and, most seriously, concrete spalling with exposed rusting reinforcement, which is a structural repair as well as a waterproofing one. Two or more of these across an elevation means spot-patching has stopped being economic — each mobilisation of access equipment costs money, and a planned programme buys the whole elevation for less than years of piecemeal call-outs.

When seepage hits multiple units

The clearest facade signature is vertical: units stacked on the same elevation — say the 12th, 9th and 6th floors of the same corner — all reporting damp walls after storms. Leaks that follow the plumbing stack instead point to services, and single-unit ceiling problems to the floor above; our inter-floor leakage guide explains how to tell them apart before money is spent on the wrong repair. In a strata building the facade is common property, so the repair belongs to the JMB or MC and is funded like any common-area work — the framework is in our JMB common-area waterproofing guide. Interior damage claims from affected owners run through the building’s master policy; see the strata insurance guide for what that covers.

Rope access vs gondola vs scaffolding

On a facade, access is often a bigger cost driver than the waterproofing itself, and choosing the right method is where an experienced contractor earns their fee.

Access methodBest forTrade-offs
Rope access (abseiling)Inspections, crack & joint repair, sealant runs, spot coatingFastest to mobilise, least disruption, no heavy rigging; slower for full-elevation coating
Gondola / suspended platformFull-elevation recoating & large repair areasStable working platform and steady coverage; rigging time, roof anchorage needed
ScaffoldingHeavy structural repair, spalling concrete, long-duration worksMaximum access and safety for major repair; highest cost, longest setup, most disruption
Boom lift / MEWPLow-rise elevations up to roughly five storeysQuick and cheap where ground access and space allow

Get a free quote on WhatsApp

WhatsApp us your job details — we reply within the hour with a free quote.

A repair inspection is RM180, deducted from the repair bill if you go ahead. To quote faster, tell us your area, property type and the size or quantity.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

Most Klang Valley facade programmes mix methods — rope access for survey and joint works, a gondola for the coating passes — and the mix should be visible as line items in the quote.

Coatings, sealants & repair cycles

A facade system is layered, and each layer has its own service life — which is why facade care is a cycle, not a one-off.

LayerWhat it doesTypical cycle
Elastomeric wall coatingFlexible film that bridges hairline cracks and sheds driven rainRecoat roughly every 7–10 years
PU joint sealant (expansion & construction joints)Keeps movement joints watertightRenew every 5–10 years
Window perimeter sealantSeals the frame-to-wall junction — a top entry pointRenew every 5–8 years
Crack routing & repair / spalling repairFixes defects before coating locks them inAs found at survey

Sequence matters: cracks and spalling are repaired first, joints resealed, and only then does the elastomeric coating go on — coating over live defects is how facades get repainted twice and waterproofed never. Between major cycles, sealant lines and known trouble spots should be checked on a schedule; a scheduled maintenance arrangement can fold facade checkpoints into the same visit as the roof.

Why facade work is quoted per project

Committees sometimes ask for a per-square-foot facade rate the way roofs are priced — and any contractor who gives one sight-unseen is guessing. The honest drivers are project-specific: total elevation area and height; the access method and its rigging; how much crack, joint and spalling repair the survey finds (usually priced as unit rates against measured quantities); coating system and number of passes; working-hour limits; and protection for entrances, cars and neighbours below. A proper facade quotation states the access method, per-elevation breakdown, unit rates for repair quantities and the coating specification — so bids can be compared even though every building’s number is its own. Our waterproofing quotation guide shows how to line quotes up like-for-like.

Safety, insurance & compliance

Facade work is working at height over occupied ground, and a committee that hires cheap here is holding the liability. Before award, demand evidence in writing: trained and certified rope-access technicians or competent gondola operators; safe-work method statements and a permit-to-work system; public liability insurance that actually covers work at height, plus workers’ coverage; anchorage and equipment inspection records; weather stand-down rules; and ground-level protection — barricades, catch protection and signage over entrances and parking. A contractor who produces these documents without being chased is telling you how the site will be run. Our waterproofing contractor guide lists the wider credential checks that apply to any bidder.

What a facade project looks like

A well-run programme moves in a straight line. First a survey — visual and binocular from the ground, drone imaging where useful, and a rope-access close inspection with tap-testing for hollow render on the worst elevation. Then a scope document with measured quantities and trial repairs to prove the specification. Tender and award follow, then the works elevation by elevation: repair, reseal, coat, with wet-film thickness checks as quality control on the coating passes. Handover closes with photographic documentation of every repair location and the warranty on workmanship and materials. The building stays occupied and operational throughout — which is exactly why the sequencing and notice discipline matter.

Budgeting & phasing a programme

Facade programmes phase naturally by elevation, and the weather-facing elevations — the ones that take the driving rain — usually justify going first. Phasing spreads the sinking-fund draw across budget years and lets the committee validate workmanship before committing the balance. Two pairings save real money: combining the waterproofing programme with the scheduled repaint, since coating and repaint share the same access cost and a facade needs both on similar cycles; and aligning facade works with rooftop projects where rigging and site setup can be shared — see our condo rooftop JMB guide for how the roof side is planned. For commercial towers and offices, the same logic applies with tenant notice in place of resident notice; our office building waterproofing guide covers that setting.

Choosing a facade contractor

Shortlist contractors who can show completed facade projects at comparable height, name the access method for your building and explain why, produce the safety documentation above unprompted, and quote with per-elevation breakdowns and unit rates rather than a single mystery number. Ask who supervises the rope or gondola crew and how repair quantities will be verified — measured and photographed, not asserted. References from other JMBs or building managers are worth more than any brochure. And treat a bid dramatically below the pack as a warning about scope, safety or both: on facade work, the cost of a bad hire is not just rework, it is liability at height.

Why buildings choose ClickBina

ClickBina delivers facade waterproofing across the Klang Valley — survey and trial repairs, crack and joint works, elastomeric coating programmes, and the access plan to match the building, from rope access to gondola — with itemised per-elevation quotes, full safety documentation, and WhatsApp replies within the hour. Send us your building’s height, the affected elevations and a few photos of the staining, and we will recommend the right access method and scope, then price the programme properly — per project, as facade work honestly has to be.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we reply within the hour.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

How much does building facade waterproofing cost in Malaysia?
It is quoted per project (indicative 2026, Klang Valley) because access method, height, elevation area and the measured quantities of crack, joint and spalling repair drive the price. A proper quote breaks the number down per elevation with unit rates — insist on that rather than a sight-unseen rate.
How do I know the leak is from the facade and not inside the building?
The facade signature is vertical: units stacked on the same elevation reporting damp walls after wind-driven rain. Leaks that follow the plumbing stack point to services, and single-unit ceiling damp to the floor above — an inspection separates them before money is spent.
Rope access, gondola or scaffolding — which is right?
Rope access mobilises fastest and suits inspections, crack and sealant works; a gondola gives a stable platform for full-elevation recoating; scaffolding is for heavy structural repair; boom lifts handle low-rise. Most programmes mix methods, and the mix should appear as line items in the quote.
How long does elastomeric facade coating last?
A quality elastomeric coating typically runs 7–10 years before recoating, with PU movement-joint sealant renewed every 5–10 years and window perimeter sealant every 5–8. Facade waterproofing is a cycle, not a one-off — budget for it like one.
Who pays for facade repairs in a condo — the JMB or the owners?
The facade is common property, so the JMB or MC repairs it from the building’s funds, typically the sinking fund for a full programme. Interior damage in affected units runs through the building’s master insurance policy.
What safety documents should we demand from a facade contractor?
Certified rope-access or gondola operator credentials, safe-work method statements and permits-to-work, public liability and workers’ insurance covering work at height, equipment and anchorage inspection records, weather stand-down rules and a ground-protection plan.
Can facade waterproofing be done while the building is occupied?
Yes — that is the normal case. Works proceed elevation by elevation with notices on working hours, protected entrances and parking below, and weather stand-downs. Occupants keep using the building throughout the programme.
