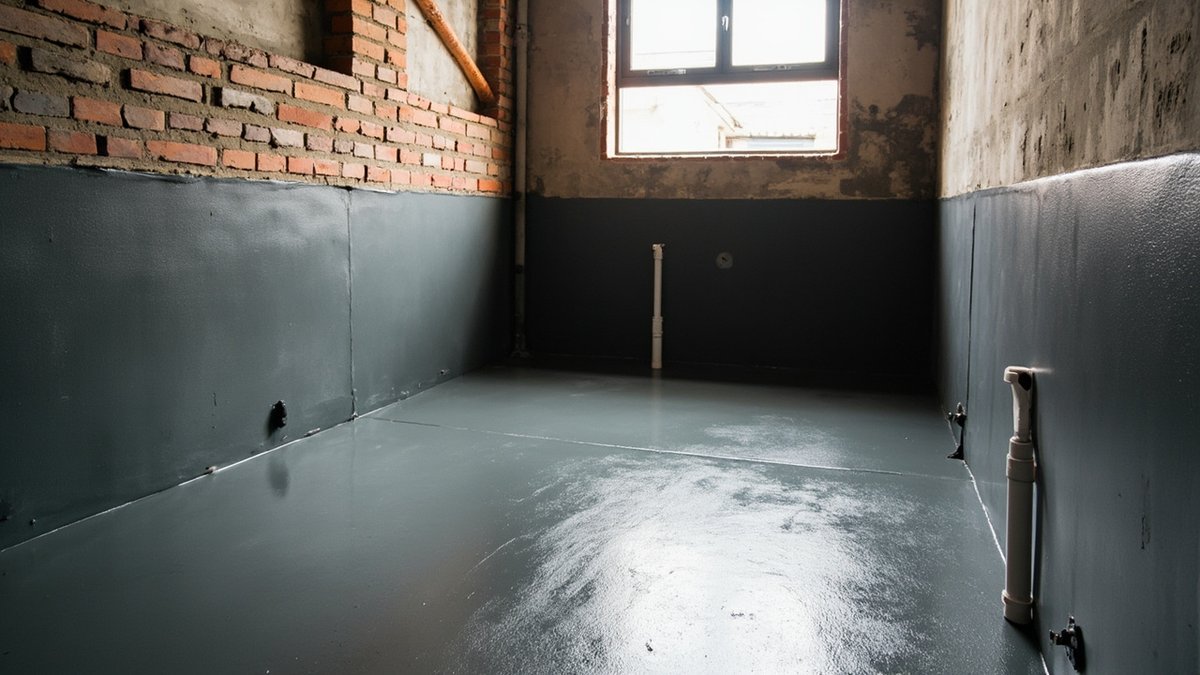

Bathroom waterproofing in Malaysia — where bathrooms leak, hacking vs non-hacking, membrane systems, the ponding test and honest 2026 prices from a Klang Valley contractor.
📍 We serve KL, Selangor & Putrajaya.

Almost every leaking bathroom in Malaysia fails at the same handful of points. Water rarely comes through the middle of the slab — it finds the weakest joint and follows it down. Knowing where to look is half the diagnosis, and it is why a serious contractor inspects before quoting instead of reciting a per-point price over the phone.
| Leak point | Why it fails | Typical symptom |
|---|---|---|
| Floor trap & drain outlet | Membrane never dressed into the outlet; movement breaks the seal | Drip directly below the trap, stain around a downlight |
| Tile joints & grout | Grout is porous and cracks with age; water slowly saturates the screed | Ceiling patch below that grows after every shower |
| Wall-to-floor junction | Upstand too low or missing; corners move and crack | Damp skirting or bubbling paint outside the bathroom |
| Pipe penetrations | Concealed pipe collars and sleeves left unsealed | Leak continues even when the bathroom is not used |
| Shower area screed | Old screed fully saturated once the membrane fails | Wide, slow-drying stain on the ceiling below |
WhatsApp us your job details — we reply within the hour with a free quote.
A repair inspection is RM180, deducted from the repair bill if you go ahead. To quote faster, tell us your area, property type and the size or quantity.
💬 Get Your Free QuoteOne free test before anything else: stop using the bathroom for 24 hours. If the ceiling below keeps dripping, suspect a pressurised supply pipe — a plumbing repair, not waterproofing. If it dries out and returns after showers, the membrane or joints are the culprit.
The classic giveaways are a yellow-brown stain on the ceiling directly below the bathroom, paint bubbling or peeling on the other side of a bathroom wall, a musty smell that never clears, white powdery efflorescence on the concrete soffit and — in apartments — the downstairs neighbour knocking on your door. If the damp tracks the shower area or floor trap and worsens with use, the waterproofing layer has failed. Our ceiling leak repair guide walks through the full diagnosis playbook, and if the water is crossing into a neighbour’s unit, our inter-floor leakage guide explains the strata side — who inspects, who pays and how to document it.
Hacking means removing tiles and screed to lay a brand-new membrane; non-hacking means treating from above (penetrative sealers, regrouting) or from below (PU injection) without demolition. The honest decision rule is to match the fix to the failure. If the leak is confined to tile joints or one cracked junction, a surface treatment at RM1,500–RM3,500 can genuinely work. If the membrane itself has failed across the floor — the bathroom is 15–20 years old, stains keep spreading, previous patch fixes did not last — only a hack-and-redo at RM4,500–RM9,000 actually resets the clock (indicative 2026, Klang Valley). Anyone who promises a permanent cure for a fully failed membrane without lifting a tile is selling hope. We compare every non-hacking method honestly in our toilet waterproofing without hacking guide.
Malaysian contractors use three main families of bathroom waterproofing, plus one rescue method applied from below. Each has a legitimate use — the scam is selling the cheap one as a substitute for the right one.
| System | Indicative price | Best for |
|---|---|---|
| Cementitious slurry (2 coats) | RM6 – RM10 / sq ft supply & apply | Standard re-waterproofing under new tiles; economical and proven |
| Flexible liquid membrane (PU / acrylic hybrid) | RM10 – RM18 / sq ft supply & apply | Wet areas with hairline movement; elastic, bridges fine cracks |
| Penetrative / nano sealer (from above) | RM1,500 – RM3,500 per bathroom | Porous grout seepage where the membrane is still largely intact |
| PU injection (from the ceiling below) | Market RM80 – RM250 / point; ClickBina from RM850 per bathroom ceiling | Stopping an active drip through the slab without touching the bathroom above |
All prices indicative 2026, Klang Valley. For a full apples-to-apples price list across every system, see our waterproofing cost guide.
A proper hack-and-redo follows a fixed sequence, and every skipped step shortens the life of the job: (1) hack off tiles and screed down to the structural slab; (2) make good cracks, honeycombing and pipe collars; (3) prime the cleaned surface; (4) apply two coats of membrane, turned up every wall 150–300mm and dressed into the floor trap and outlets; (5) flood the floor for a 24–48 hour ponding test; (6) lay a protective screed with falls toward the trap; (7) retile and grout. Allow roughly 4–7 working days for a standard bathroom including curing time, during which the bathroom is out of action. Membrane cure times are not negotiable — a crew that tiles the same afternoon the membrane dries is burying a future leak.
The ponding test is standard practice and the single best consumer protection in waterproofing. After the membrane cures, the floor traps are plugged, the doorway is dammed, and the floor is flooded with 25–50mm of water. The level is marked and left for 24–48 hours while the ceiling below is checked. If the level holds and nothing appears below, the membrane is proven watertight before screed and tiles hide it forever. Insist that the ponding test is written into the quote, and ask for timestamped photos of the flooded floor. A contractor who resists a two-day test is telling you something about their membrane.
Bathtub waterproofing deserves its own attention because a built-in tub creates a hidden wet zone that nobody can inspect. The membrane must run across the full floor and up the walls before the tub is installed — retrofitting waterproofing around an existing built-in tub is guesswork. The tub rim-to-wall joint should be sealed with a quality sanitary-grade silicone and re-sealed every two to three years, because that flexible joint, along with the overflow and waste connections underneath, is where most tub leaks start. Freestanding tubs are simpler: the whole floor becomes the wetted zone, so a full-floor membrane with proper upstands does the work. If your tub surround tiles sound hollow or the silicone has blackened and lifted, treat it as an early warning, not a cosmetic issue.
| Scenario | Indicative cost (2026, Klang Valley) | Notes |
|---|---|---|
| Non-hacking treatment (sealer / regrout) | RM1,500 – RM3,500 | Right for joint and grout failures; 1–2 days |
| Full hack-and-retile re-waterproof | RM4,500 – RM9,000 | Membrane reset; includes ponding test; 4–7 days |
| PU injection from the ceiling below | Market RM80 – RM250 / point; ClickBina from RM850 | Stops active drips; 6-Month No-Leak Warranty with ClickBina |
| Membrane element alone | RM6 – RM18 / sq ft | Supply and apply, system-dependent |
For the line-by-line breakdown — what the hacking, membrane, screed and retiling each cost — see our bathroom waterproofing cost guide. If the bathroom is due for a makeover anyway, folding the waterproofing into a full renovation is better value: our bathroom renovation cost guide shows how the numbers combine.
The mistakes we are called to undo are remarkably consistent. Tiling over existing tiles on a leaking floor traps water between two layers and doubles the future hacking bill. Painting a “waterproof coating” over grout without fixing the trap or upstands buys a few dry months at most. Skipping the ponding test saves two days and gambles the entire job. And the classic pricing trap: a RM80-per-point injection quote that balloons to 25–30 “points” once the crew is on a ladder — suddenly a RM2,000+ bill for work quoted to sound like RM240. A flat, scoped price and a written warranty exist precisely to kill that game.
Ask for an itemised written quote naming the membrane system and number of coats, a method statement that includes upstand heights and the ponding test, stage photos, and a workmanship warranty in writing. Be wary of phone-quote per-point pricing, miracle nano products pitched as a universal cure, and anyone unwilling to explain where your bathroom is leaking before naming a price. Our waterproofing contractor guide covers the full vetting checklist, red flags and the questions that separate specialists from general renovators.
ClickBina does waterproofing the transparent way: published pricing — PU injection is from RM850 for one bathroom ceiling, backed by a 6-Month No-Leak Warranty — and fixed itemised quotes for hack-and-redo re-waterproofing with the 24–48 hour ponding test as standard on every membrane job. We serve the whole Klang Valley, explain the diagnosis before the price, and reply on WhatsApp within the hour. Send us the details of the stain and we will tell you honestly whether you need a from-RM850 injection or a full re-waterproof.
WhatsApp us your job details for a free quote — we reply within the hour.
💬 Get a Free QuoteHow we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.
