Bathroom Renovation Waterproofing Requirements Malaysia 2026
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Bathroom Renovation Waterproofing Requirements
in Malaysia (2026)

Why every bathroom renovation must be re-waterproofed — condo approvals, renovation deposits, the ponding test and who pays if it leaks after the reno.

📍 We serve KL, Selangor & Putrajaya.

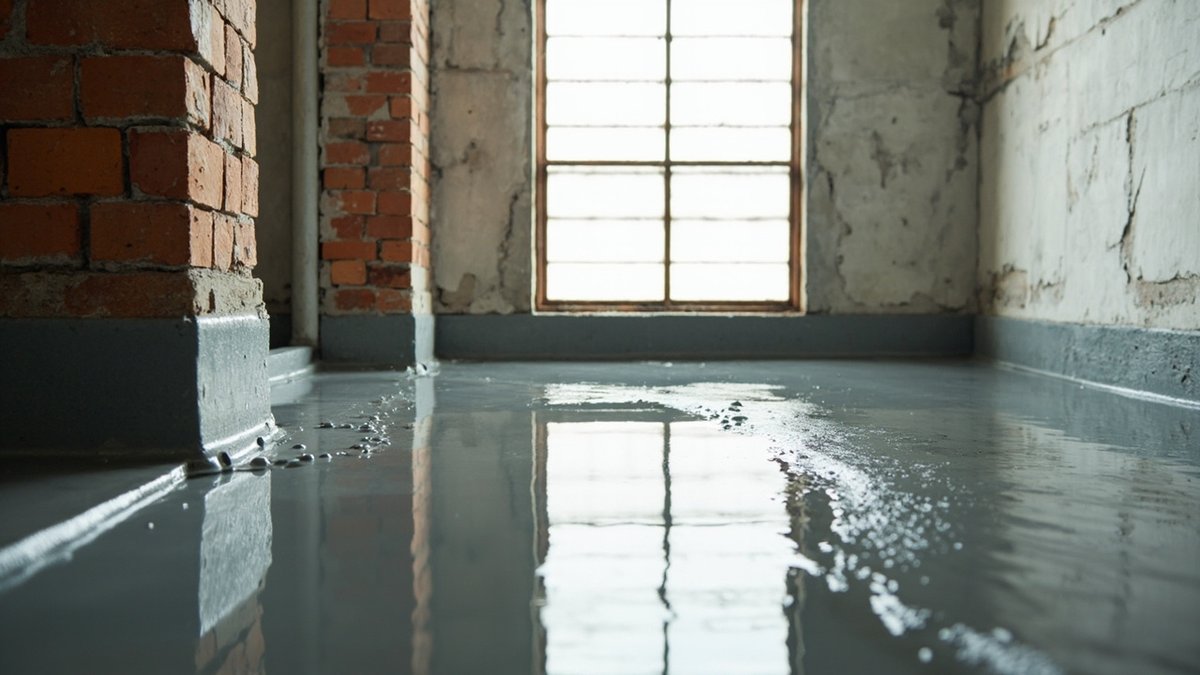

Room under renovation with wet grey waterproofing membrane on the floor beside a brick wall corner and large window
Any bathroom renovation that hacks the floor or walls destroys the existing waterproofing membrane, so re-waterproofing before tiling is non-negotiable — and in a condo you also need management approval, a renovation deposit (commonly RM1,000–RM5,000) and a ponding test before the tiler starts (indicative 2026, Klang Valley). Skipping any of these is how a beautiful new bathroom becomes a leak dispute with the unit below six months later.
📐 Free tool: Try our renovation cost calculator for an instant estimate — no sign-up needed.

Why renovation destroys waterproofing

The waterproofing in your bathroom is a thin, continuous membrane sitting under the tiles and screed — and continuity is the whole point. The moment a renovation contractor hacks up the old tiles, chases new pipe runs into the floor, or breaks out a hob to fit a new shower area, that membrane is punctured, torn and interrupted in dozens of places. There is no such thing as a renovation that “mostly” keeps the old membrane: even partial hacking compromises the system, because water on a bathroom floor finds the one breach it needs. This is why almost every “new bathroom, new leak” story downstairs traces back to a reno where waterproofing was treated as optional. The physics of how that water then appears in the neighbour’s ceiling is covered in our inter-floor leakage guide.

Re-waterproofing is non-negotiable

Because hacking destroys the membrane, every bathroom renovation that touches the floor or wet-area walls must include full re-waterproofing before tiling — not patching, not “touch up the corners”, a complete new system. A renovation quote that does not itemise waterproofing as its own line is telling you it will be skipped or skimped. The failure timeline is deceptive: a skipped membrane usually holds through handover and shows up as a stain on the downstairs ceiling six to twenty-four months later, when the contractor is long gone and the defects period may have lapsed. The methods, materials and standards are covered in our bathroom waterproofing guide — read it before signing any reno quote.

Condo approval & renovation deposits

In a strata building, a bathroom renovation is not just your business — wet works above someone else’s ceiling are exactly what house rules exist for. Typical requirements: submit a renovation application with your scope and contractor details, receive a written approval letter before any hacking starts, and place a refundable renovation deposit — commonly in the RM1,000–RM5,000 range depending on the building and scope (indicative 2026, Klang Valley) — which the management refunds after a post-reno inspection confirms no damage to common property. Budgeting for the deposit and the timeline sits alongside the wider numbers in our condo renovation cost guide. Starting wet works without approval risks stop-work orders and deposit forfeiture — and it hands the building a ready-made villain if anything leaks later.

Typical JMB renovation rules

Every building’s house rules differ, so check yours — but the pattern across Klang Valley condos is consistent. How management bodies think about waterproofing generally, including for common areas, is covered in our JMB common area waterproofing guide, and the wider framework in the JMB guide.

Typical requirementWhat it usually involves
Renovation application & approval letterScope, drawings for wet works, contractor details; approval before work starts
Refundable renovation depositCommonly RM1,000 – RM5,000; refunded after post-reno inspection
Working hoursTypically weekday and Saturday daytime; no noisy works Sundays and public holidays
Hacking noticeSome buildings require notice to neighbours or restrict hacking days
Protection of common areasLift padding, corridor protection, approved debris disposal
Contractor requirementsRegistration with management; some buildings ask for insurance or workman details

Get a free quote on WhatsApp

WhatsApp us your job details — we reply within the hour with a free quote.

A repair inspection is RM180, deducted from the repair bill if you go ahead. To quote faster, tell us your area, property type and the size or quantity.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

What proper re-waterproofing includes

A proper re-waterproofing during renovation is a system, not a coat of paint. It starts with surface preparation on the hacked slab — clean, sound, and patched level; corners and pipe penetrations get fillets and reinforcement because joints are where membranes fail; a primer goes down, then the membrane in at least two coats, carried up the walls — a few hundred millimetres around the general floor and to full shower height in the wet zone; floor drains and penetrations are detailed, not just painted around. The membrane then needs its curing time and a protective screed before tiling. Every one of these steps is visible and photographable while it happens — and invisible a week later, which is exactly why you photograph it. The full method and material options are in our bathroom waterproofing guide.

The ponding test before tiling

The ponding test is the single cheapest discipline in the entire renovation: after the membrane has cured, the floor drains are plugged, the floor is flooded with a few centimetres of water, and it stands for 24–48 hours while the ceiling below is checked for any sign of moisture. If the membrane leaks, you find out now — when the fix costs a re-coat — instead of after tiling, when the fix costs a hacked-up bathroom and a neighbour dispute. Insist on it in the contract, make it a payment milestone (no tiling payment until the ponding test passes), and get dated photos of the flooded floor plus a short written record of start time, end time and result. A contractor who resists a ponding test is telling you something important about the membrane they intend to install.

Who pays if it leaks after the reno?

If a leak appears downstairs after your renovation, the starting presumption in most strata disputes is uncomfortable but simple: the unit that just renovated its bathroom is the prime suspect, and as the renovating owner you are generally the one the downstairs neighbour and management will look to. Your protection is the paper you set up before the works: a renovation contract that names the waterproofing system and warranty (multi-year written waterproofing warranties are common — get yours in writing), a defects liability period so the contractor returns to fix failures at their cost (check your contract for the period and what it covers), and the membrane-stage and ponding-test photos that prove the job was done properly. Note that insurance rarely rescues a bad reno — defective workmanship is a typical exclusion, as our water damage insurance claim guide explains. This is general guidance, not legal advice — the contract you signed governs.

Landed vs strata differences

In a landed house there is no JMB, no approval letter and no renovation deposit — though structural work and extensions may still need local authority approval, as covered in our renovation checklist. But do not mistake fewer rules for lower stakes: the physics are identical, and in a double-storey house the “downstairs neighbour” is your own living room. Landed failures are often discovered later because no third party complains — the water quietly works on your own ceiling, wiring and beams. Strata adds the neighbour, the management body and the deposit inspection to the equation, which is pressure — but also a discipline landed owners must impose on themselves. Either way, the membrane, the details and the ponding test are the same job.

Bathroom renovation process and timeline in Malaysia: where waterproofing fits

The order of work matters more than the speed. In a typical bathroom renovation the waterproofing sits in the middle of the job, and every stage after it depends on it passing.

  1. Approval and deposit (strata): renovation application, written approval letter and refundable deposit before any hacking.
  2. Hacking of old tiles and screed down to a sound slab.
  3. Plumbing and pipe runs chased in while the floor and walls are open.
  4. Surface preparation: slab cleaned, patched and level; fillets and reinforcement at corners and pipe penetrations.
  5. Membrane: primer, then at least two coats carried up the walls, left to cure.
  6. Ponding test: drains plugged and the floor flooded for 24–48 hours while the ceiling below is checked.
  7. Protective screed, then tiling, fittings and the management post-reno inspection.

That is why the timeline cannot be squeezed at the waterproofing stage: the membrane needs its curing time and the ponding test needs its 24–48 hours. A schedule that jumps from hacking straight to tiling has skipped the step that protects the ceiling below.

The cost of doing it right

Set against the total cost of a bathroom renovation, doing the waterproofing properly is a small line — and set against the cost of a post-reno leak, it is trivial. The ranges below are indicative 2026, Klang Valley; the full breakdown is in our bathroom waterproofing cost guide.

ItemIndicative cost (2026, Klang Valley)
Re-waterproofing a standard bathroom during reno (membrane system)RM1,500 – RM3,500 depending on size and system
Ponding test & photo recordOften included — insist it is itemised in the quote
Skipping it: PU injection from below when the leak appearsfrom RM850 for one bathroom ceiling (ClickBina) — buys time, not a new membrane
Skipping it: hack up the new bathroom and redo properlyRM8,000 – RM15,000+ including retiling
Skipping it: neighbour’s ceiling repair & repaintRM500 – RM2,000, plus the dispute itself

The asymmetry is the whole argument: a four-figure membrane done once, versus a five-figure redo plus a neighbour dispute that can end at the tribunal.

Owner’s checklist during the reno

You do not need to be on site daily — you need to be present, or represented, at the moments that matter. How to vet the contractor doing this work is covered in our waterproofing contractor guide.

StageWhat to insist on
Before signingWaterproofing itemised in the quote: system named, coverage area, wall heights, warranty stated
Before hackingManagement approval letter in hand; deposit paid; working hours confirmed
Membrane stageDated photos of fillets, penetration details and both membrane coats — before the screed hides them
Before tilingPonding test passed: 24–48 hours, dated photos, written result; tiling payment released only after
HandoverWritten waterproofing warranty; defects liability period confirmed in the contract
After handoverManagement post-reno inspection done; renovation deposit refunded

Why ClickBina

ClickBina handles bathroom renovation waterproofing across the Klang Valley the way this guide describes — membrane systems installed to specification, penetration and corner detailing, a ponding test with dated photos and a written record as standard, and a written waterproofing warranty — with itemised fixed quotes so the waterproofing line is visible, not buried. If you are mid-dispute instead of mid-reno, our PU injection service stops an active ceiling leak from RM850 for one bathroom ceiling (indicative 2026, Klang Valley) while the proper fix is arranged. WhatsApp us your reno plan or leak photos for a same-day ballpark.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we reply within the hour.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

Do I need to re-waterproof when renovating a bathroom?
Yes — non-negotiable. Hacking tiles, chasing new pipes or breaking out a hob punctures the existing membrane in dozens of places, and even partial hacking compromises the system. Every renovation touching the floor or wet-area walls needs a complete new membrane before tiling, itemised in the quote.
Do I need JMB approval to renovate a condo bathroom?
Typically yes. Most Klang Valley condos require a renovation application, a written approval letter before work starts and a refundable renovation deposit, with wet works specifically scrutinised because they sit above a neighbour’s ceiling. Every building’s house rules differ — check yours before hacking.
How much is a condo renovation deposit?
Commonly RM1,000–RM5,000 depending on the building and scope (indicative 2026, Klang Valley), refundable after management’s post-reno inspection confirms no damage to common property. Some buildings add non-refundable admin fees — check the house rules.
What is a ponding test and how long does it take?
After the membrane cures, drains are plugged and the floor is flooded for 24–48 hours while the ceiling below is checked. It catches membrane failures when the fix is a re-coat instead of a hacked-up finished bathroom. Get dated photos and a written result, and make passing it a payment milestone before tiling.
Who pays if my bathroom leaks after renovation?
The renovating owner is generally the prime suspect and the person the neighbour and management look to. Your protection is paperwork set up in advance: a contract naming the waterproofing system, a written warranty, a defects liability period, and membrane-stage plus ponding-test photos. Defective workmanship is typically excluded from insurance, so prevention is the real cover.
How much does re-waterproofing during renovation cost?
Indicatively RM1,500–RM3,500 for a standard bathroom membrane system (2026, Klang Valley) — small against the renovation, trivial against a failure: a post-reno redo runs RM8,000–RM15,000+ including retiling, plus the neighbour’s ceiling and the dispute.
Is it different for a landed house?
No JMB approval or deposit, though structural work may still need local authority approval. The physics are identical — in a double-storey house the downstairs victim is your own living room, and failures are often found later because nobody complains. The membrane, detailing and ponding test are the same job either way.
What is the bathroom renovation process in Malaysia?
Approval and deposit (for a condo), hacking, plumbing, surface preparation, the waterproofing membrane, a 24–48 hour ponding test, a protective screed, then tiling and fittings. The waterproofing and ponding test come before any tile is laid.
How long does bathroom waterproofing take before tiling?
The membrane needs its curing time first, then the ponding test runs for 24–48 hours while the ceiling below is checked. Tiling should only start, and be paid for, once the ponding test has passed.
Does a bathroom refurbishment need new waterproofing?
Yes, if the work touches the floor or wet-area walls. Hacking tiles or chasing new pipes punctures the existing membrane, so a complete new membrane is needed before tiling, itemised in the quote.

Get a Free Quote

Tell us what you need — we reply within the hour.

WhatsApp ClickBina← All Guides
💬 Get Your Free Quote
