Balcony Waterproofing Cost Malaysia 2026: Leaks, Systems & Price
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Balcony Waterproofing
Cost & Guide in Malaysia (2026)

Balcony waterproofing in Malaysia — tile-on-tile traps, upstands, drainage falls, planter boxes and the condo who-pays question, with honest 2026 Klang Valley prices.

📍 We serve KL, Selangor & Putrajaya.

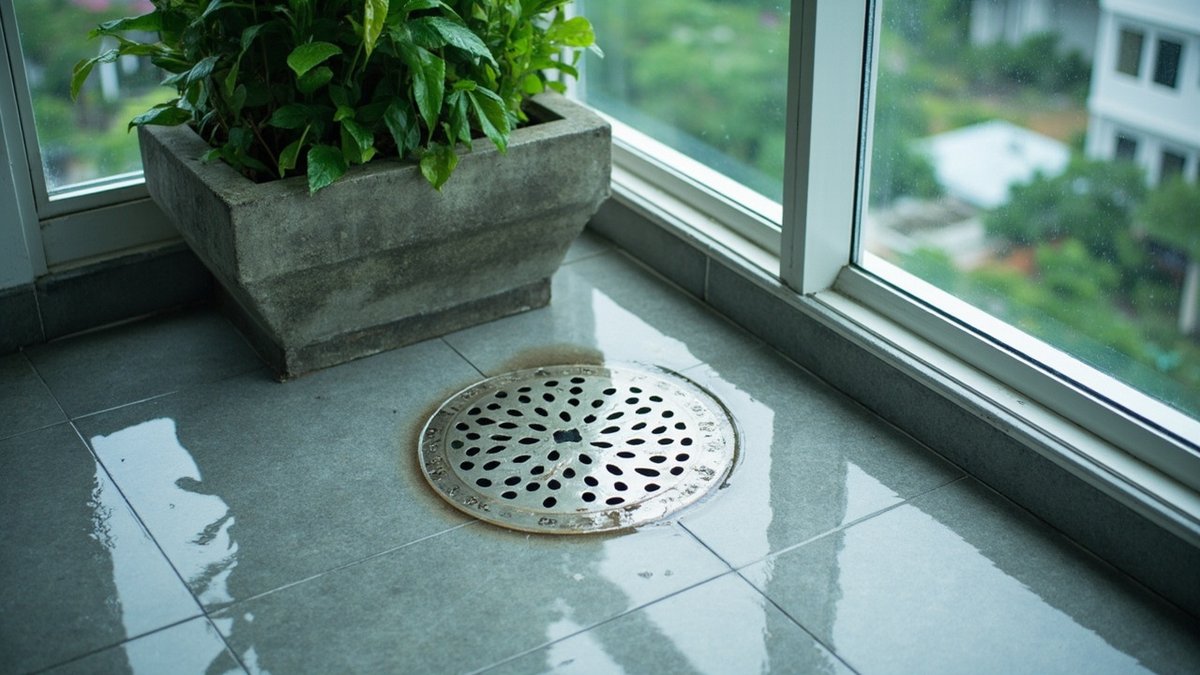

Condominium balcony floor drain with pooling water beside a planter box
Balcony waterproofing in Malaysia typically costs RM1,200–RM4,000 for a standard condo or terrace-house balcony, with membrane systems running RM6–RM18 per sq ft supply-and-apply (indicative 2026, Klang Valley). Balconies fail at predictable points — tile-on-tile layers, low upstands, flat drainage falls, planter boxes and the sliding-door threshold — so the fix starts with finding which one is yours.

Why balconies leak so often

A balcony is the hardest-working waterproofed surface in a Malaysian home: fully exposed to monsoon downpours and direct sun, cycling through expansion and contraction every single day, with a large number of joints and penetrations packed into a small slab. The leak shows up either on the balcony ceiling of the unit below, or — sneakier — as a damp wall or floor edge inside your own living room or bedroom where water tracks under the door threshold. The failure points are remarkably consistent.

Failure pointWhat goes wrong
Tile joints & cracked groutUV and thermal cycling crack joints faster than indoors; water saturates the screed
Wall & parapet upstandsMembrane stops at floor level instead of turning up; water wicks sideways into walls
Floor trap / rainwater outletMembrane not dressed into the outlet; debris blockage causes flooding
Sliding-door thresholdOutside floor level too high; driving rain and ponded water cross into the room
Planter boxesPermanently wet soil against the slab; roots puncture membranes
Slab & parapet cracksStructural movement opens hairline paths straight through

Get a free quote on WhatsApp

WhatsApp us your job details — we reply within the hour with a free quote.

A repair inspection is RM180, deducted from the repair bill if you go ahead. To quote faster, tell us your area, property type and the size or quantity.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

The tile-on-tile trap

The most common bad “fix” we see: the balcony leaks, so someone lays a new layer of tiles over the old one, sometimes with a skim of “waterproof” slurry between. It looks new for a while — and solves nothing, because the failed membrane is still failed underneath both layers. Worse, the second layer adds dead load to a cantilevered slab, raises the floor level toward or above the door threshold (inviting water into the house), and traps moisture between the tile beds where it migrates and stains the ceiling below in new places. When the leak returns, both layers must be hacked off — you pay for demolition twice. If a contractor proposes tile-on-tile for a leaking balcony, that is your cue to get another opinion.

Upstands: the 150mm rule

A balcony membrane is only as good as its edges. Good practice turns the membrane up every wall and parapet at least 150mm above finished floor level — and up to 300mm at the door — so that ponded water during a storm sits inside a waterproof tray rather than against bare plaster. Plenty of original-build balconies in Malaysia got little or no upstand, which is why the first symptom is often not a drip below but a damp band on the bedroom or living-room wall beside the balcony. If that is your symptom, our wall waterproofing guide explains the wall side of the problem — but the lasting cure is re-doing the balcony membrane with proper upstands, not coating the wall.

Drainage falls & floor traps

Water should reach the outlet within minutes of rain stopping. Balcony screeds are supposed to fall gently toward the floor trap or rainwater spout — in practice many are laid dead flat or even fall toward the door, so water ponds in corners and against thresholds after every storm. Standing water is the membrane’s enemy: it finds every pinhole given hours instead of minutes. During a re-waterproof, the screed is re-laid to proper falls and the membrane is dressed into the outlet itself — the most commonly botched detail on the slab. Between renovations, the cheapest balcony maintenance in existence is clearing leaves and dirt off the floor trap so the water can actually leave.

To turn these figures into a number for your own project, try the Balcony Renovation Cost Calculator: it adds up the published range for each balcony work you pick.

Planter boxes

Built-in planter boxes are a beautiful idea with an appalling leak record. They hold permanently damp soil against the structure, their internal render cracks, and plant roots are genuinely capable of puncturing membranes in search of water. A planter that shares a wall with your living room is a slow leak with a countdown timer. The proper treatment is a dedicated planter membrane (root-resistant grade), a drainage layer with functioning weepholes so the soil drains instead of swamps, and waterproofing carried over the planter walls. The pragmatic alternative many owners choose during a re-waterproof: decommission the built-in planter, waterproof it as part of the deck, and switch to freestanding pots — all of the greenery, none of the liability.

Sliding-door thresholds

The sliding-door threshold is the balcony’s border crossing, and it fails when the levels are wrong: the outside finished floor should sit a proper step below the internal floor, with a hob or drop the membrane can turn up against. Tile-on-tile layers and flat falls erode that margin until one heavy storm with a slightly blocked outlet sends water over the track and into the laminate flooring. Retrofit fixes, in ascending order of effort: keep the outlet clear and re-seal the track ends; add a slot drain across the threshold; rebuild the hob and re-level the falls during a full re-waterproof. If your living-room floor swells after storms, the threshold — not the roof — is the usual suspect.

Systems for exposed balcony decks

An exposed deck needs a system that tolerates UV and daily thermal movement, or one that hides under protective layers. All prices indicative 2026, Klang Valley.

SystemIndicative priceBest for
Flexible cementitious membrane under new tilesRM6 – RM10 / sq ft supply & applyStandard re-tile jobs; protected by screed and tiles
Liquid PU membrane, exposed gradeRM10 – RM18 / sq ft supply & applySeamless, self-flashing around outlets and upstands; can be left exposed with topcoat
Acrylic deck coatingRM4 – RM10 / sq ft supply & applyLight-duty refresh on sound substrates; maintenance protection, not a failed-membrane cure
Torch-on membrane under screedRM8 – RM15 / sq ft supply & applyLarge decks and roof terraces; robust when detailed well

For big roof terraces the calculus shifts toward the heavier systems — our flat roof waterproofing guide compares them in depth. Whichever system goes down, a 24–48 hour ponding test before tiling or handover is standard practice and should be in the quote.

Condo balconies: who pays when it leaks below?

In a condo, a leaking balcony is a legal question as well as a technical one. Depending on your development’s plans and by-laws, the balcony slab and its waterproofing may be your responsibility, the JMB/MC’s, or split between you — and the neighbour below whose ceiling is staining will not wait for the philosophy. The practical sequence: document everything with dated photos, notify the management office in writing early, and get the leak inspected before positions harden. Malaysia’s strata framework has a defined process for inter-floor leakage certificates and cost allocation, which we walk through in our inter-floor leakage guide. External facade seepage that mimics a balcony leak is usually the management’s scope — our external wall seepage guide covers telling them apart.

Balcony waterproofing cost

ScenarioIndicative cost (2026, Klang Valley)
Small condo balcony — strip, re-membrane, retileRM1,200 – RM2,500
Larger balcony or terrace deck with falls re-laidRM2,500 – RM4,000+
Planter box re-membrane with drainage & weepholesAdd several hundred ringgit per planter
Membrane element aloneRM6 – RM18 / sq ft supply & apply

The spread is driven by deck size, how many layers must be hacked off (tile-on-tile jobs cost more to undo), upstand and threshold rebuilding, and outlet details. Worked cost scenarios follow further down this page, and the master waterproofing cost guide shows how balcony work prices against bathrooms and roofs.

Choosing a contractor

A balcony specialist should talk about upstand heights, falls and outlet dressing before talking about brands. Ask for an itemised quote naming the system and coats, confirmation that the old finishes come off (no tile-on-tile), the ponding test in writing, stage photos, and a workmanship warranty. In a condo, check they will handle management-office permits and protection of common corridors. Our waterproofing contractor guide has the full vetting checklist and the red flags that predict a two-year callback.

Worked cost scenarios

ScenarioScopeIndicative total
Condo balcony, 60 sq ftLiquid PU over prepared screed, upstands, overlay finishRM1,200 – RM1,600
Landed car-porch deck, ~200 sq ftHack old tiles, flexible membrane, re-fall, retileRM3,000 – RM5,000
Pair of built-in planter boxesStrip, liquid PU lining, drainage cells, outletsRM800 – RM1,800

The car-porch deck lands above the “typical balcony” band because it combines a bigger area with full tile removal and retiling — it is effectively a small flat-roof job over a habitable space, and worth doing to that standard because the leak drips into your porch or a room below.

Signs your balcony is leaking

From above: tiles that sound hollow, grout lines that stay dark long after rain, moss in corners, water pooling at the door. From below — usually the first anyone notices: a brown ring or peeling paint on the ceiling under the balcony, drips during or hours after rain, or (in a condo) a complaint from the neighbour downstairs. Catching it at the “dark grout” stage often means a RM1,200 fix; waiting for the downstairs ceiling to stain means a bigger job plus making good someone else’s ceiling. If the drip is coming through a concrete slab, PU injection can sometimes stop it from below while the topside repair is planned. In condos there is a deadline pressure as well: once the unit below lodges a complaint, managements typically require the owner above to rectify a confirmed leak within a set period — acting at the first signs keeps the job small and keeps you out of a dispute with the JMB.

Why ClickBina

ClickBina re-waterproofs balconies across the Klang Valley with fixed itemised quotes — strip-off, membrane with proper upstands, falls to the outlet, ponding test, retile — and no quiet extras once work starts. If the urgent problem is the drip on your neighbour’s ceiling, our PU injection is from RM850 per ceiling with a 6-Month No-Leak Warranty to stop the water while the deck repair is planned. WhatsApp us details of the balcony and the stain below, and we will tell you which failure point you are looking at and what the honest fix costs.

Ready to price your leak repair job?

WhatsApp us your job details for a free quote — we reply within the hour.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

How much does balcony waterproofing cost in Malaysia?
A standard condo or terrace balcony runs about RM1,200-RM2,500 for strip, re-membrane and retile, and RM2,500-RM4,000+ for larger decks or where falls and thresholds are rebuilt. Membranes themselves cost RM6-RM18 per sq ft supply-and-apply (indicative 2026, Klang Valley).
Why is my balcony leaking into the room below?
Usually one of six points: cracked tile joints saturating the screed, missing membrane upstands at walls, an outlet the membrane was never dressed into, a too-high door threshold, a planter box, or a slab crack. Exposure to sun and rain makes balcony joints fail faster than indoor ones.
Can I just tile over my existing balcony tiles?
Not on a leaking balcony. The failed membrane stays failed underneath, the extra layer adds load and raises the floor toward the door threshold, and water gets trapped between tile beds. When the leak returns you pay to hack off both layers.
Who pays when a condo balcony leaks into the unit below?
It depends on the development's strata plans and by-laws - the balcony may be your scope, the JMB/MC's, or shared. Document with dated photos, notify management in writing early, and follow the inter-floor leakage inspection process rather than trading blame with the neighbour.
What is an upstand and why does it matter?
The membrane's vertical turn-up at walls and parapets - good practice is at least 150mm above floor level, more at doors. Without it, storm water sits against bare plaster and wicks sideways into bedroom and living-room walls instead of staying in a waterproof tray.
How long does balcony waterproofing take and last?
A typical balcony takes 3-5 working days including the 24-48 hour ponding test before retiling. A properly detailed membrane with correct upstands and falls should last 10+ years; exposed coatings need recoating sooner.
Can ClickBina stop the drip without redoing the whole balcony?
If the leak path is through the slab, PU injection from the ceiling below - from RM850 per ceiling with a 6-Month No-Leak Warranty - stops the drip fast. It is an honest stopgap, not a substitute for fixing failed upstands, thresholds or planters.
Why is the per-sq-ft rate so high on a small balcony?
Because a contractor still mobilises a team, materials and disposal for 60 sq ft. Minimum job charges of RM500-RM800 plus fixed setup costs get divided by very few square feet - so a small balcony realistically prices at RM15-RM25 per sq ft all-in.

Get a Free Quote

Tell us what you need — we reply within the hour.

WhatsApp ClickBina← All Guides
💬 Get Your Free Quote
