Swimming Pool Waterproofing
in Malaysia (2026)

Leaking pool diagnosis and repair in Malaysia — the bucket test, shell vs pipework vs fittings, re-waterproofing systems, retiling costs and a fixed quote from a Klang Valley contractor.

📍 We serve KL, Selangor & Putrajaya.

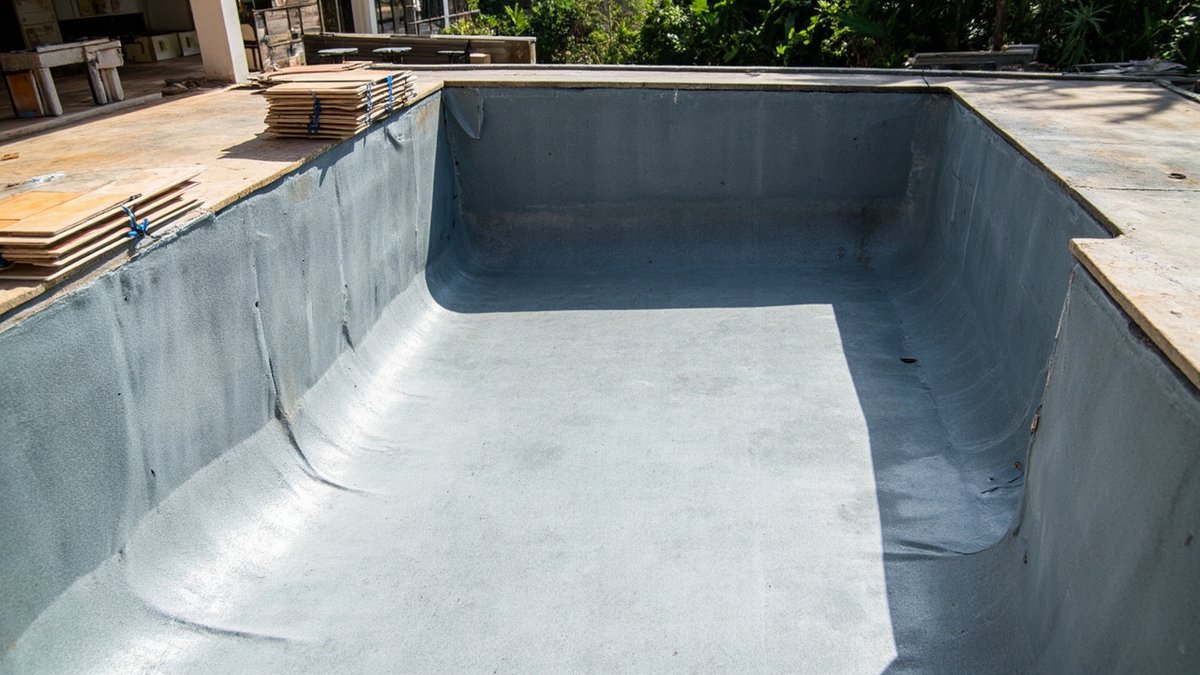

Empty swimming pool shell coated with grey waterproofing membrane before tiling
Re-waterproofing a leaking swimming pool in Malaysia typically costs RM15–RM30 per sq ft of pool surface before retiling, with complete strip-and-rebuild jobs running RM8,000–RM30,000+ depending on pool size and finish (indicative 2026, Klang Valley). The first step is always confirming you actually have a leak — a simple bucket test separates a real leak from normal evaporation.

Why swimming pools leak

A swimming pool is a concrete tank that lives outdoors, holds tonnes of water, bakes in the Malaysian sun and gets dosed with chemicals daily — so it is no surprise that pools eventually leak. Tiles and grout are not the waterproofing; the real barrier is the layer beneath them, and it ages. The RC shell moves fractionally with ground settlement and temperature, opening hairline cracks. Grout lines erode and let water reach a tired membrane. Pipework buried in the pool deck corrodes or pulls away at joints. And fittings — underwater lights, skimmer boxes, return inlets, main drains — are penetrations through the shell where sealant eventually gives up. Bungalow pools, condo pools and hotel pools all follow the same pattern; the difference is only in scale and in who has to manage the repair.

Evaporation or leak? The bucket test

Pools in Malaysia genuinely do lose several millimetres of water a day to evaporation, so a dropping level does not automatically mean a leak. Before spending anything on repairs, run the bucket test. Place a bucket on a pool step and fill it so the water inside the bucket matches the pool level. Mark both levels with tape. Leave everything running normally for 24–48 hours, then compare: evaporation affects the bucket and the pool equally, so if both dropped the same amount, you have evaporation, not a leak. If the pool level fell noticeably further than the bucket’s, water is escaping somewhere. As a rule of thumb, losing more than about 5mm a day beyond what the bucket loses — or needing to top up markedly more than usual — justifies a proper investigation.

Shell, pipework or fittings — narrowing it down

A leaking pool has three suspect zones, and simple observations separate them. First, compare water loss with the circulation pump running versus switched off for a day each: if the pool loses clearly more water with the pump on, the leak is likely in the pressurised pipework; if it loses the same either way, suspect the shell or fittings. Second, watch where the level stabilises: a pool that drops and then holds at a particular height is often leaking through a crack, fitting or tile line at exactly that level — check the skimmer mouth, light niches and return inlets there. Third, a dye test around suspect cracks and fittings (with the pump off and the water still) shows dye being drawn into the leak path. This diagnosis matters because the three causes carry very different price tags.

Leak sourceTypical clueTypical fix
Shell (cracks / failed waterproofing)Same loss pump on or off; level stabilises at crack heightCrack injection, re-waterproof & retile
Buried pipeworkFaster loss with pump running; soggy deck or lawnPressure-test lines, repair or re-route the failed run
Fittings (lights, skimmer, drains)Dye drawn in around the fitting; loss stops at fitting levelReseal or replace the fitting & its seal

Get a free quote on WhatsApp

WhatsApp us your job details — we reply within the hour with a free quote.

A repair inspection is RM180, deducted from the repair bill if you go ahead. To quote faster, tell us your area, property type and the size or quantity.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

Shell cracks & structural movement

Cracks in the RC shell come from concrete shrinkage, ground settlement and, in older pools, corroding reinforcement. Hairline surface crazing in the render is usually cosmetic; a crack that runs through the shell and weeps water is not. Structural cracks can be stitched and injected — epoxy injection restores structural bond in dry, stable cracks, while PU injection seals cracks that are actively wet (see our epoxy injection guide and PU injection guide for how the two differ). Injection alone treats the crack, not the tired waterproofing layer around it — which is why a pool with multiple cracks or widespread seepage is usually better served by a full re-waterproof than by chasing cracks one at a time.

Re-waterproofing systems compared

Three system families dominate Malaysian pool re-waterproofing. Flexible cementitious coatings — two-part polymer-modified slurries — are the standard base layer under new tiles: they bridge hairline movement, bond to damp concrete and take tile adhesive directly (our cementitious waterproofing guide covers the chemistry). Reinforced membrane systems add a fabric layer at corners, joints and fitting penetrations for extra movement tolerance. Fibreglass lining takes a different route entirely: layers of glass fibre and resin form a one-piece waterproof shell finished with a gelcoat — no tiles needed, which changes both the look and the budget. Crystalline treatments (RM8–RM15 per sq ft — see the crystalline guide) suit water-retaining RC where hairline cracks are the issue, and are often used on the shell before the flexible coat goes on.

SystemFinishBest for
Flexible cementitious coatingTiled over (mosaic / porcelain)The standard under-tile re-waterproof for most pools
Reinforced membrane (fabric at details)Tiled overPools with movement history; corners, joints & fittings
Fibreglass liningGelcoat — no tilesFast turnaround; owners happy with a non-tiled finish
Crystalline (shell treatment)Under other systemsHairline cracks in the RC shell; belt-and-braces base layer

The retiling reality

Here is the part many owners don’t expect: if the waterproofing under your tiles has failed, the tiles have to come off. The waterproof layer sits beneath the tile bed, so re-waterproofing means hacking off the existing finish, repairing the shell, applying the new system, and tiling again. Patching grout or smearing sealer over tile lines does not reach the failed layer and rarely buys more than a few months. Retiling is also where the budget swings most — standard ceramic mosaic is economical, glass mosaic and imported porcelain cost several times more, and feature bands, steps and coping all add labour. Treat a pool re-waterproof as a renovation of the pool interior, not a patch job, and budget for the finish you actually want, because you will live with it for the next decade.

Condo & commercial pools

For a condo JMB or a hotel, a leaking pool is a water-bill problem, a reputation problem and a liability problem — and the repair is a project that needs planning. The pool will be out of service for weeks, so residents need notice; the works involve hacking, so noise hours and debris routes matter; and the water discharged during drain-down must go to an appropriate drain, slowly enough not to flood the compound. Procurement should follow the same discipline as any strata works: an itemised scope, a warranty on the waterproofing system, and a contractor who can show similar completed pools. Our waterproofing quotation guide shows what a proper itemised quote looks like, and our contractor guide covers the vetting questions. If your block also has roof tank issues or a flooding lift pit, our water tank leak repair guide and lift pit waterproofing guide are the companion reads — bundling the works into one mobilisation usually saves the JMB money.

Swimming pool waterproofing cost in Malaysia (2026)

Pool jobs are quoted on the wetted surface area — floor plus walls, which is always more than the plan footprint. The ranges below are indicative 2026, Klang Valley planning figures.

ScopeIndicative priceNotes
Re-waterproofing (system only)RM15 – RM30 / sq ftHack-off, shell repair & new waterproof layer
Retiling (on top)Varies with tile choiceMosaic economical; glass / porcelain several times more
Crack injection (targeted)RM80 – RM250 / point (market)For isolated weeping cracks in an otherwise sound shell
Complete job (typical bungalow pool)RM8,000 – RM30,000+Size, finish & access drive the total; condo pools higher

A small plunge pool with mosaic lands near the bottom of the range; a large freeform pool with glass mosaic and new fittings can pass RM30,000 comfortably. See the waterproofing cost guide for how these figures compare with other structures.

What a pool re-waterproof involves

A typical project runs: drain the pool in a controlled way; hack off tiles and screed down to sound concrete; repair cracks (injection where needed) and rebuild damaged corners and fitting boxes; apply the waterproofing system with reinforcement at all penetrations; then — the step that separates professionals from patchers — a flood test, refilling or ponding the pool for 24–48 hours to prove the new layer holds before any tile goes on. Only after a passed flood test do screeding, tiling and grouting proceed, followed by refill and rebalancing of the water chemistry. End to end, expect roughly two to four weeks for a residential pool depending on size, weather and tile lead times.

Keeping the pool watertight

A re-waterproofed pool should give you a decade or more, and simple habits extend it. Keep water chemistry balanced — persistently aggressive (low-pH) water eats grout and eventually the layer beneath. Re-grout worn tile lines every few years rather than letting them erode to bare edges. Keep an eye on the expansion joint between pool deck and coping, and re-seal it when it cracks. Never leave the pool empty for extended periods without advice — groundwater pressure under an empty shell can crack it or even lift it. And repeat the bucket test once or twice a year; catching a small leak early is the difference between resealing a fitting and repeating the whole exercise.

Why ClickBina for pool waterproofing

ClickBina diagnoses and repairs leaking pools across the Klang Valley — bungalow pools, condo pools and commercial facilities — from bucket-test verification through crack injection, full re-waterproofing, flood testing and retiling, with an itemised fixed quote and workmanship warranty. If the leak turns out to be pipework or a fitting rather than the shell, we tell you so — you shouldn’t pay for a re-waterproof you don’t need. WhatsApp us your pool size and a few photos for a same-day assessment.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we reply within the hour.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

How much does swimming pool waterproofing cost in Malaysia?
Re-waterproofing runs about RM15–RM30 per sq ft of pool surface, plus retiling on top, with complete jobs typically RM8,000–RM30,000+ depending on pool size and tile choice (indicative 2026, Klang Valley). Targeted crack injection is quoted per point at RM80–RM250 in the wider market.
How do I know if my pool is leaking or just evaporating?
Run the bucket test: place a bucket on a step, match its water level to the pool, mark both, and compare after 24–48 hours. Evaporation lowers both equally — if the pool dropped noticeably more than the bucket, you have a leak worth investigating.
How do I tell if the leak is the shell or the pipework?
Compare water loss with the circulation pump on versus off. Clearly faster loss with the pump running points to pressurised pipework; equal loss either way points to the shell or a fitting. A pool that stabilises at one level is often leaking at exactly that height.
Do the tiles really have to come off to re-waterproof a pool?
Yes — the waterproof layer sits beneath the tile bed, so reaching it means hacking off the existing finish, applying the new system, flood testing and retiling. Patching grout over a failed layer rarely lasts more than a few months.
What waterproofing system is best for a swimming pool?
Most pools use a flexible two-part cementitious coating under new tiles, with fabric reinforcement at corners and fittings. Fibreglass lining is an alternative that needs no tiles, and crystalline treatment suits hairline cracks in the RC shell as a base layer.
How long does a pool re-waterproof take?
Roughly two to four weeks for a residential pool: drain-down, hacking, shell repair, waterproofing, a 24–48 hour flood test to prove the new layer holds, then tiling, grouting and refill. Condo and commercial pools need extra time for notices and access control.
Can you repair a condo or hotel pool?
Yes — ClickBina handles strata and commercial pools across the Klang Valley, including drain-down planning, noise-hour scheduling, itemised scopes for JMB approval and a warranty on the installed system.
