Concealed Pipe Leak Detection Malaysia 2026: Signs & Cost
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Concealed Pipe Leak Detection
in Malaysia (2026)

Water meter spinning, damp patch that never dries — how concealed pipe leaks are found and fixed in Malaysian walls and floors, and what it costs.

📍 We serve KL, Selangor & Putrajaya.

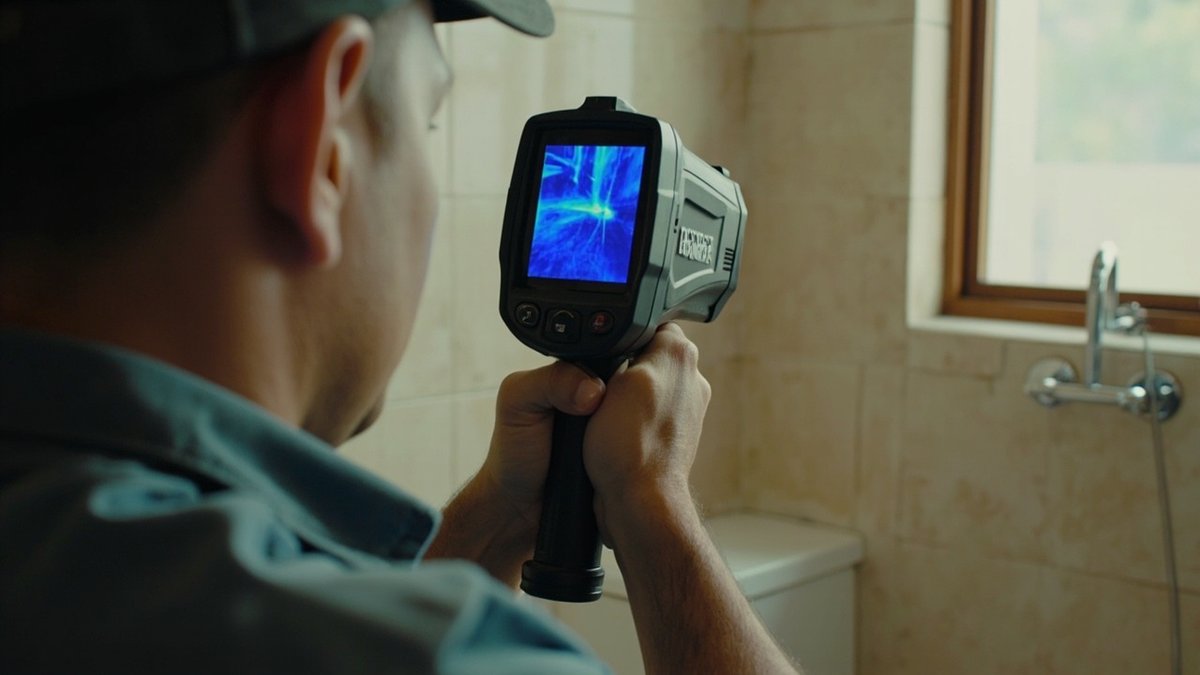

Technician using a thermal imaging camera to scan a bathroom wall for a concealed pipe leak
A concealed pipe leak — a supply pipe leaking inside a wall or floor slab — shows up as a spinning water meter, a damp patch that never dries, hissing sounds or a pressure drop, and typically costs RM300–RM1,500+ to repair once found, with hacking and making good extra (indicative 2026, Klang Valley). The free first step is the DIY water meter test; a professional detection visit (RM300–800) then pinpoints the leak so only one hole gets hacked.

What a concealed pipe leak is

Most Malaysian homes run their water supply through pipes buried in the wall plaster or cast into the floor slab — copper, PPR or poly pipe you will never see until something goes wrong. A concealed pipe leak is a failure somewhere along that hidden run: a corroded joint, a nail from old renovation work, a hairline crack from building movement. Because the pipe is pressurised, even a pinhole pushes out water 24 hours a day, and because it is buried, the water shows up somewhere else — a damp patch two metres away, a stain on the neighbour’s ceiling, or nowhere at all except your water bill. That invisibility is what makes concealed leaks expensive: they run for months before anyone connects the clues.

Signs of a pipe leak in a wall or floor

The classic signs, roughly in order of reliability: the water meter creeps even when every tap is off; the water bill rises with no change in habits; a damp patch on a wall or floor never fully dries, even in dry weather; you hear a faint hiss or trickle inside a wall at night when the house is silent; water pressure at the taps drops noticeably; a floor area feels warm underfoot (a hot-line leak); or paint and plaster bubble along a line rather than in a blob. One sign alone can have innocent explanations — a leaking toilet inlet valve also spins the meter — but two or three together make a concealed leak the leading suspect, and the meter test below turns suspicion into evidence.

The DIY water meter test — free first step

Before paying anyone, run the meter test. It costs nothing and takes an hour. First, shut off every tap and everything that draws water: washing machine, dishwasher, water filter — and check that no toilet is refilling (lift the cistern lid; a hissing fill valve invalidates the test). Second, find your meter and photograph the reading, including the small red dials or litre digits. Third, use no water for one full hour — go out if that is easier. Fourth, read the meter again. If the reading has moved, water is escaping somewhere between the meter and your fittings, and a concealed supply pipe is the prime suspect. If you have isolation valves, repeat the test with sections shut off to narrow down which line is losing water. A static meter does not fully clear you — waste pipe and waterproofing leaks never register on the meter because they only leak when water is used — but a moving meter is close to proof.

Hot vs cold line clues

If your home has concealed hot water piping from a storage or instant heater, the leak often announces which line it is on. A hot-line leak shows as a warm patch on the floor or wall, a heater that cycles on when nobody is using hot water, hot water that runs out faster, or a higher electricity bill alongside the water bill. Isolate the heater’s inlet valve and repeat the meter test: if the meter stops moving with the heater isolated, the leak is on the hot side. Cold-line leaks carry no temperature signature and move the meter around the clock. Knowing the line matters because it halves the search area before detection even begins — and hot lines show up beautifully on a thermal camera.

Detection technology — acoustic, thermal, pressure

Professional detection is about pinpointing the leak so that only one hole gets hacked, not five. The main tools complement each other.

MethodHow it worksBest for
Acoustic listeningAmplifies the hiss of pressurised water escaping through concrete or plasterLocating supply-line leaks in slabs and walls
Thermal imagingReads surface temperature differences — evaporative cooling from damp, or heat from a hot lineHot-line leaks and mapping how far moisture has spread
Pressure testingIsolates and pressurises one line at a time to see which holdsConfirming which line leaks — hot, cold, or a specific branch
Moisture meter & dye testsMaps dampness levels; coloured dye traces waste-water pathsSeparating supply leaks from waste, shower and waterproofing leaks

Get a free quote on WhatsApp

WhatsApp us your job details — we reply within the hour with a free quote.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

No single instrument is conclusive on its own — the skill is in combining them. A visit that produces a specific, marked location before hacking is what the RM300–800 detection fee buys; our leak detection service guide covers the full visit step by step.

Repair options — hack, re-route or re-pipe

Once the leak is located, there are three honest options, and the right one depends on pipe age and position.

OptionWhat it involvesWhen it makes sense
Hack-and-fixOpen the wall or floor at the marked point, repair or replace the failed section, make goodA single, well-located failure in otherwise healthy pipe
Re-routeAbandon the buried section and run a new line along the surface or ceiling, boxed upDeep slab leaks, repeat failures, or pipe that is hard to reach
Full re-pipeReplace the ageing pipe run entirely, usually surface-run and concealed with boxingOld copper or poly systems failing in multiple places

Re-routing feels drastic but is often cheaper and faster than chasing a leak deep in a slab — and it retires the whole failed section rather than fixing one pinhole in a pipe that is corroding along its length. A contractor who only ever proposes hacking, or only ever proposes re-piping, is selling a habit rather than a diagnosis.

Slab leaks vs waterproofing failures — honest both ways

This is the most common misdiagnosis in Malaysian leak repair, and it cuts both ways. A pipe leaking inside a bathroom floor slab produces a ceiling stain downstairs that looks exactly like failed waterproofing — and plenty of owners have paid for a full bathroom re-waterproofing job while the pipe kept leaking underneath it. Equally, failed floor waterproofing gets misdiagnosed as a pipe leak, and owners pay for hacking that finds a perfectly sound pipe. The meter test separates them: a moving meter with everything off points to the supply pipe; a static meter with stains that freshen after showers points to waterproofing or waste pipes — see our upstairs bathroom leak and shower floor leak repair guides. Insist on this distinction being demonstrated, not asserted, before you approve either repair.

Detection & repair costs

ItemIndicative cost (2026, Klang Valley)Notes
DIY water meter testFreeOne hour; the essential first step
Professional leak detection visitRM300 – RM800Acoustic, thermal, pressure and dye testing with a marked location
Concealed pipe repairRM300 – RM1,500+Hacking and making good (tiling, plastering, painting) are extra
Re-route / partial re-pipeRM800 – RM3,000+By run length and boxing-up finish
PU injection (bathroom ceiling leak)from RM850ClickBina starting price — for waterproofing-type leaks

The making-good line deserves attention when comparing quotes: hacking a tiled floor means retiling, and matching discontinued tiles can cost more than the pipe repair itself. A complete quote states the repair, the making good and who carries each — a suspiciously cheap repair quote usually just leaves the making good out.

What happens if you ignore it

A pressurised pinhole does not heal. Left alone, it saturates the slab or wall, lifts tiles, rots cabinetry and feeds mould across the damp area — see our damp and mould treatment guide — and in a condo it eventually stains the neighbour’s ceiling and turns a plumbing job into a dispute with the management office. The water bill quietly compounds the cost: even a modest concealed leak can waste thousands of litres a month. Every month of delay adds making-good scope, and none of it is recoverable.

Choosing a leak detection contractor

Ask three things. First, what instruments will actually be used on site — a contractor whose only tool is a hammer diagnoses everything as "hack and see". Second, is the fee structure clear: detection visit price, repair price and making good, itemised separately. Third, does one team carry the job from detection through repair and making good, with a warranty on the fix — the handover between a detection company and a separate repair contractor is where accountability evaporates. A contractor competent in both waterproofing and plumbing matters, because as the slab-leak section shows, the diagnosis can land on either side of that line.

Why ClickBina

ClickBina finds and fixes concealed pipe leaks across the Klang Valley with one team — meter and pressure testing, thermal and acoustic detection, the repair itself and the making good, all itemised in one quote. Detection visits run RM300–800, concealed pipe repairs RM300–RM1,500+ with hacking and making good quoted upfront, and bathroom-above ceiling leaks that turn out to be waterproofing are fixed by PU injection from RM850. WhatsApp us your meter test result and where the damp patch is, and we will tell you the likely line and the next step within the hour.

Ready to price your leak repair job?

WhatsApp us your job details for a free quote — we reply within the hour.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

How do I know if I have a concealed pipe leak?
Watch for a water meter that moves with every tap off, a rising bill, a damp patch that never dries, hissing inside a wall at night, or a pressure drop. Two or more signs together make a concealed leak the leading suspect — then confirm with the free one-hour meter test.
How do I do the water meter test?
Shut every tap and appliance that uses water, check no toilet is refilling, photograph the meter reading, use no water for one hour, then read it again. Movement means water is escaping between the meter and your fittings. It is free and the best first step.
How much does it cost to repair a concealed pipe leak in Malaysia?
Typically RM300–RM1,500+ for the pipe repair itself, with hacking and making good (retiling, plastering, painting) extra. A professional detection visit to pinpoint the leak first runs RM300–800 (indicative 2026, Klang Valley).
Is it better to repair or re-route a leaking concealed pipe?
A single well-located failure in healthy pipe suits a hack-and-fix. Deep slab leaks, repeat failures or ageing pipe often favour re-routing a new surface-run line — frequently cheaper and faster than chasing the leak, and it retires the whole failing section.
Can a pipe leak be mistaken for a waterproofing problem?
Yes, in both directions. A slab pipe leak under a bathroom looks identical to failed waterproofing from below, and vice versa. The meter test separates them: a moving meter points to the supply pipe; a static meter with stains after showers points to waterproofing or waste pipes.
What technology is used to find hidden pipe leaks?
Acoustic listening amplifies the hiss of escaping water, thermal imaging reads damp and hot-line temperature differences, pressure tests isolate which line is losing water, and moisture meters and dye tests separate supply leaks from waste and waterproofing leaks.
Will my wall or floor definitely need hacking?
Not always. Detection first means only the marked point is opened rather than exploratory holes, and re-routing can avoid opening the slab at all. Where the problem turns out to be bathroom waterproofing instead, PU injection fixes it from below with no hacking — from RM850 with ClickBina.
The plumber hacked my wall in 3 places and still cannot find the burst pipe. Is that normal?
Hacking three spots without finding a concealed pipe leak is a sign the leak was never located before opening, not normal good practice. Water from a buried pipe travels, so the damp patch is often not over the leak. Stop the hacking and ask for a meter test plus acoustic, thermal or pressure testing to mark one precise spot first; a professional detection visit is indicatively RM300–RM800.
