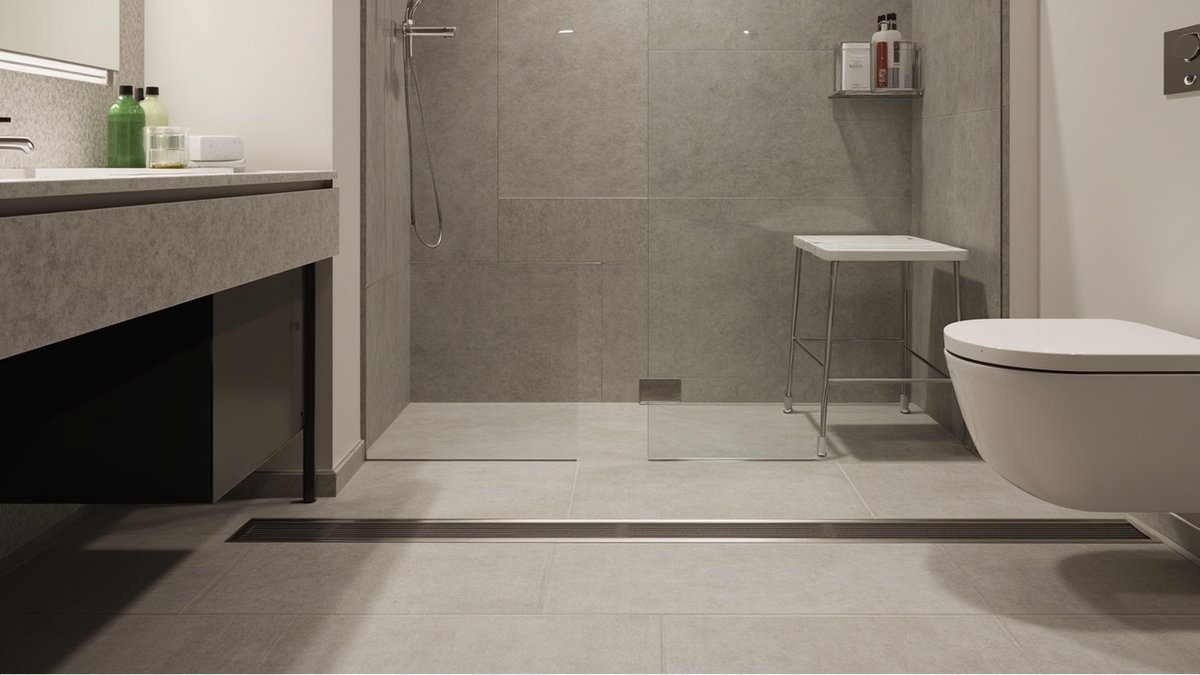

Worried about an elderly parent tripping on the shower kerb? Here is how a level, step-free shower is built so the water still stays where it should.
📍 We serve KL, Selangor & Putrajaya.

A step-free shower replaces the kerb or step that holds water in with a floor that falls gently towards a drain, usually a linear drain, so the water stays in the shower without anything to step over. It means hacking the floor, re-screeding with proper falls, new waterproofing and new tiles, and in a condo the slab usually cannot be lowered, so the fall has to be built within the existing floor depth. On ClickBina's bathroom waterproofing guide, a full hack-and-redo including retiling costs RM4,500 – RM9,000 for a standard bathroom (indicative 2026, Klang Valley).
Many Malaysian bathrooms have a raised kerb around the shower, a step down into the bathroom, or both. They keep water in the wet area, but for an elderly parent, someone recovering from surgery, a wheelchair or walking-frame user, or a young child, that small step is where falls happen. Wet feet, a slippery tile and a raised edge are a bad combination. A step-free shower also looks cleaner and makes a small bathroom feel larger.
Removing the kerb is not a cosmetic job, though. The kerb or step is doing a job, and the new floor has to do that job instead.
The kerb holds water inside the shower; the step at the bathroom door stops water reaching the bedroom or corridor floor; and both often exist because the bathroom floor sits higher to fit the pipes and the fall to the floor trap. Take them away and three things must replace them:
ClickBina's small bathroom layout guide explains how wet and dry zones are separated; a level shower floor is the most demanding version of that.
In a landed house the bathroom floor is often on a slab you can hack down into or build up around, and on the ground floor there may be room to lower the shower area. In a condo, the structural slab is common property and cannot be cut or lowered, and the pipes run through it to the unit below. The fall has to be built within the screed you already have, or the rest of the bathroom (and sometimes the corridor outside) raised slightly so the shower can sit lower.
That is why the first question on any step-free conversion is how much screed depth there is between the slab and the finished floor. A contractor can only tell by opening up a small area or measuring at the floor trap. Check the building's renovation rules before any hacking in a strata unit.
| Option | How it works | Suits |
|---|---|---|
| Linear (channel) drain at the shower entry | Floor falls one way to a long drain across the opening | Step-free showers; keeps water off the dry side |
| Linear drain along the back wall | Floor falls away from the door to the wall | Where the entry must stay flat for a wheelchair |
| Centre floor trap | Floor falls four ways to a round trap | Traditional; harder to make truly step-free |
| Existing trap relocated | Trap moved to suit the new fall | Possible in landed homes; limited in condos |
A linear drain lets the floor fall in one plane, which is easier to walk and roll across and allows larger tiles. Whatever you choose, the drain must be sized for the shower's flow and set at the right level before tiling.
Without a kerb, the glass does more of the work. A fixed glass panel covering most of the shower, with an open entry beyond the drain, keeps splashes in while leaving a clear way in. Hinged doors on a step-free floor need a seal at the bottom and must not swing over the drain. ClickBina's shower screen guide compares the options. For a carer helping someone shower, a folding screen or a weighted curtain can be more practical than glass.
Taking out the kerb removes a barrier, so the waterproofing has to be continuous across the whole bathroom floor, turned up the walls, detailed around the linear drain and carried under the door threshold. ClickBina's bathroom waterproofing cost guide describes the hack-and-redo sequence: hacking, re-screed with falls, a flexible two-part membrane, a ponding test to prove the membrane before tiling, then tiling.
Insist on the ponding test. It is the only point at which a leak can be found cheaply; once the tiles are down, finding it means hacking again, and in a condo the first sign is usually a stain on the neighbour's ceiling.
A kerb removal is effectively a bathroom floor hack-and-redo. These indicative Klang Valley figures (2026) are from ClickBina's published guides:
| Item | Indicative price | Source guide |
|---|---|---|
| Full hack-and-redo including retiling, standard bathroom | RM4,500 – RM9,000 | Bathroom waterproofing cost guide |
| Hacking and debris disposal | RM900 – RM1,600 | Bathroom waterproofing cost guide |
| Re-screed with falls | RM500 – RM1,000 | Bathroom waterproofing cost guide |
| Waterproofing membrane | RM700 – RM1,300 | Bathroom waterproofing cost guide |
| Tiling, supply and install | RM2,000 – RM3,800 | Bathroom waterproofing cost guide |
| Fixed glass shower panel | RM500 – RM900 | Small bathroom layout guide |
WhatsApp us your job details for a quote — we reply within the hour.
💬 WhatsApp for a quoteA linear drain, relocating a drain, grab bars and a new door are priced on top, depending on what the bathroom needs.
ClickBina is an experienced KL & Selangor contractor for whole-house refurbishment and trade coordination, and a level shower floor brings together hacking, screeding, waterproofing, tiling and plumbing. WhatsApp us your job details for a quote: the bathroom size, whether it is a condo or landed house, and who the bathroom is for. We reply within the hour, the price we agree is a flat price with no hidden charges, and a renovation site visit is free, and a repair inspection is RM180, deducted from the bill if you go ahead.
How we estimated prices: every RM figure on this page is quoted unchanged from the ClickBina guides named above; they are indicative Klang Valley ranges for 2026, not fixed rates. Whether a level floor is possible depends on the screed depth and the building's rules, checked on site.
