Perimeter & Apron Drain Defects in New Landed Homes
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
🏠 Defect Check

Perimeter & Apron Drain Defects in New Landed Homes
Falls, Ponding and Joints at VP (2026)

The drain and apron should carry rain away from your walls. How to check them at handover, word the defects and judge the repair.

📍 We serve KL, Selangor & Putrajaya.

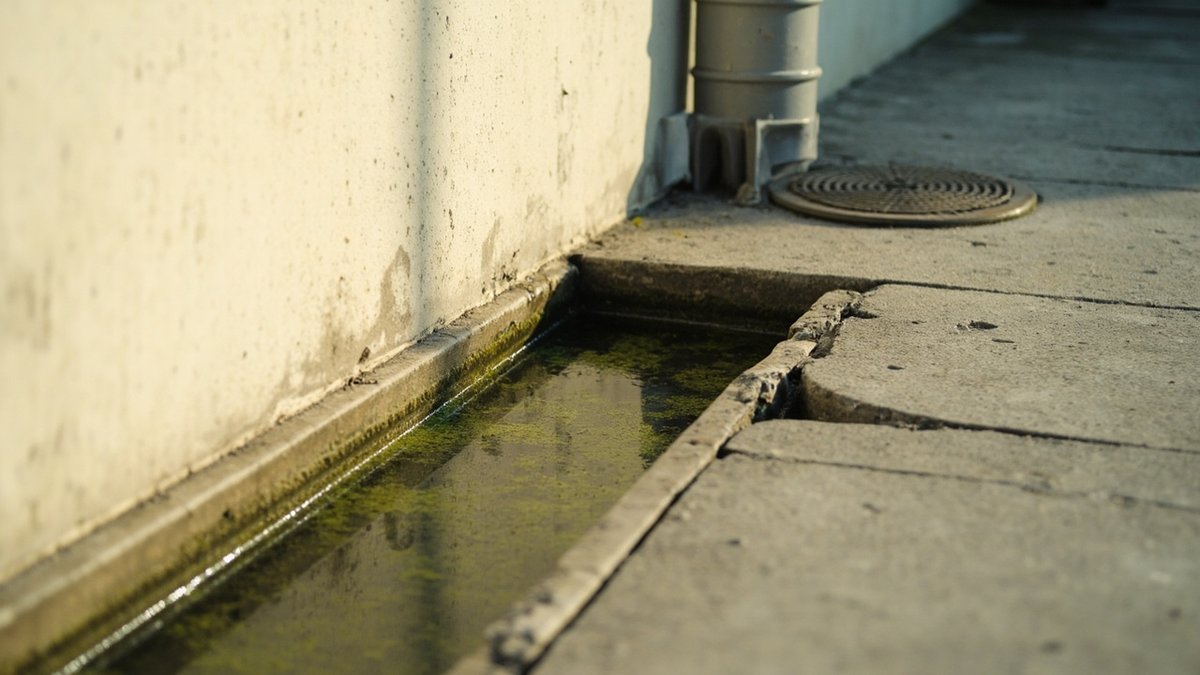

Perimeter drain beside a new terrace house holding standing water, with a cracked section and loose cover

The perimeter drain and the concrete apron around a new landed house have one job: carry rain away from the walls. The usual defects at handover are drains laid without a steady fall, so water stands in them; cracked or broken drain sections; covers that rock, are missing or do not fit; cement and debris left in the channel; downpipes that do not discharge into the drain; and aprons that slope towards the wall or have an open joint against it. Check them after rain or with a bucket of water at vacant possession, list each one in writing, and send it to the developer inside the 24-month defect liability period.

What perimeter drain and apron defects look like

Walk around a new terrace, semi-D or bungalow and you will usually find a concrete apron along the outside walls and an open or covered drain at its edge, with the roof downpipes feeding into it. When these are built well, rain runs off the roof, down the pipes, into the drain and away to the outlet without wetting the base of the walls. When they are not, you see pools in the drain days after the rain, green slime and mosquito larvae in the low spots, cracked channel sections, a gap opening where the apron meets the wall, and damp marks creeping up the paint.

Settlement of the apron or car porch slab is a related but separate problem with its own causes. The guide to a sinking car porch or apron in a new house covers it in detail; this page concentrates on the drain and the apron as drainage surfaces.

What is an apron drain? Apron and perimeter drain explained

Searchers use several names for the same two parts. The apron (sometimes called the perimeter apron) is the strip of concrete laid along the outside walls of a landed house. The perimeter drain is the open or covered channel at the outer edge of that apron, running round the house to an outlet. “Apron drain” usually means that same channel: the drain that the apron sheds water into.

They work as one system. Roof water comes down the downpipes into the drain, rain falling on the apron runs off it into the drain, and the drain carries both to the outlet and the road drain. If the apron slopes the wrong way, water sits against the wall; if the drain has no fall, water sits in the channel. That is why this page checks the apron and the drain together. In Malay the drain is usually called longkang keliling rumah or longkang apron.

Why new houses get these defects

External drains are often among the last works on a project, built by a different team from the house and sometimes after the roof and gutters. If the channel is cast without checking the fall from end to end, water collects in the flat or back-falling sections. Precast sections that are not bedded properly crack or shift as the fill beneath them settles. Covers are ordered to a standard size and may not suit the channel they sit on.

The apron has its own issues. It is a ground-bearing slab laid on filled ground around a house that usually stands on different foundations, so the joint between the two moves. The car porch and apron guide notes that this gap is often filled with sealant by the developer and then opens again, and that a slab not tied to the house needs a flexible joint, not rigid mortar. Finally, clean-up crews sweep cement, sand and offcuts into the nearest drain.

How to check drains and the apron at VP

You do not need tools beyond a bucket, a torch and a notebook. The best time is during or just after rain; if the day is dry, pour water yourself.

ElementWhat to look forSimple owner check
Drain channelStanding water, slime, debris, cracked or displaced sectionsWalk the full length; pour a bucket at the high end and watch whether it reaches the outlet
Drain outletOutlet blocked, higher than the channel, or not connected to the road drainFind where the water leaves your lot and check it flows freely
Drain covers and gratingsMissing, cracked, rocking or wrong-size covers; sharp edgesPress each cover with your foot and look for gaps at the ends
DownpipesPipe ending above the apron instead of into the drainFollow each downpipe to where it discharges
Apron surfaceSlope towards the wall, low spots, cracks across the slabPour water near the wall and see which way it runs
Apron-to-wall jointOpen gap, cracked sealant, mortar packed into the jointLook along the base of every external wall with a torch

Record each finding with the side of the house and the nearest room, for example "rear apron outside the kitchen". You can tick your defects room by room on ClickBina's checklist tool and add these under the external section.

Drain falls and standing water

Falls are the most common perimeter drain defect and the easiest to prove. A drain should empty after the rain stops. Water that sits in the same stretch the next day, a stripe of green slime along the bottom, or silt collecting in one section all point to a channel that is flat or falls the wrong way. Standing water in an outdoor drain also breeds mosquitoes, which makes it more than a cosmetic issue.

Do not try to fix falls by adding cement to the channel yourself before the developer has seen it. Once the drain has been altered, the defect becomes your work. The drain cleaning guide explains how silt and debris also cause overflow, which is a maintenance issue once the drain itself has been built correctly.

The apron: slope, cracks and the joint at the wall

The apron should shed water away from the house into the drain. If water runs towards the wall or ponds along it, every storm soaks the base of the wall and the ground under the slab. Over time that can show as damp marks and peeling paint at skirting level inside, and it speeds up settlement under the slab. The rising damp guide explains why water held against a wall base shows up as damp indoors.

Cracks across an apron are common because it is a large slab on fill. Fine surface cracks are usually shrinkage; cracks with one side higher than the other, cracks that keep widening, or a slab that has dropped away from the wall are signs of movement and belong on the defect list. The guide to cracks in a new house helps you sort the two.

Defect or normal? How to tell the difference

Use the table as a guide, not a rule book. It is qualitative because there is no homeowner-measurable published tolerance for drain falls or apron cracks; judge by whether water is carried away from the house.

FindingUsuallyWhy
Water still standing in the drain the next dayDefectThe channel has no steady fall to the outlet
Cracked or displaced drain sectionDefectWater leaks into the ground beside the house
Missing, cracked or rocking coverDefectSafety risk and debris enters the drain
Cement or construction debris in the drainDefectLeft by the builder; blocks flow
Downpipe discharging onto the apronDefectRoof water is released against the wall
Apron sloping towards the wallDefectWater ponds at the base of the wall
Gap at the apron-to-wall joint filled with rigid mortarDefect to listThe joint moves and needs to be flexible
Fine hairline surface cracks on the apronUsually cosmeticShrinkage; list it only if it widens or steps
Leaves or garden soil in the drainNormalRoutine cleaning by the owner

Example defect-list wording

Write each item so the developer's team can find it without you. Location, element, problem, request.

  1. Rear perimeter drain behind the kitchen: water remains in the drain the day after rain; no fall to the outlet. Please re-lay the channel to drain fully.
  2. Left side drain beside the car porch: channel section cracked and displaced. Please replace the section.
  3. Front drain at the gate: drain cover rocks when stepped on and does not fit the channel. Please replace with a fitted cover.
  4. Right side, downpipe outside bedroom 2: pipe discharges onto the apron, not into the drain. Please connect it to the drain.
  5. Rear apron outside the yard: slab falls towards the wall and water ponds at the wall base. Please re-lay the apron to fall to the drain.
  6. Apron-to-wall joint along the left side: joint packed with mortar and cracked open. Please form a proper flexible joint.
  7. Drain at the front outlet: cement and debris left in the channel. Please clear the drain.

Send the list in writing and keep a copy. The new house defects guide explains how to submit it and follow up.

What a proper repair should look like

  • Flat or back-falling channels are re-laid or re-screeded so water runs to the outlet, then tested with water.
  • Cracked or broken drain sections are replaced and re-bedded, not plastered over.
  • Covers are replaced with ones that fit the channel and sit firm.
  • Every downpipe is connected into the drain.
  • An apron that falls to the wall is broken out and re-laid to fall to the drain, or topped so water runs away.
  • The apron-to-wall joint is cleaned out and sealed with a flexible joint sealant, not mortar.
  • Debris is removed from the whole drain run.

Ask the developer's team to pour water at the high end of the drain after the repair while you watch. If the drain empties, note the date on your copy of the list.

If ponding, cracks or the gap come back

If the drain ponds again or the joint at the wall reopens, report it again in writing as a repeat defect, giving the date of the earlier repair. The defect liability period guide says an inadequate repair should be documented and reported again, because it is a fresh breach of the developer's obligation. A joint that keeps reopening can also mean the apron is still settling, which is the point to read the porch and apron guide and consider an engineer's view.

If damp marks indoors persist after the outside has been fixed, a water leak detection visit can rule out a buried pipe or a failed waterproofing layer before anyone hacks the floor. The garden drainage guide covers where water from the lot is allowed to go.

Timing: the defect liability period

For a new house bought from a licensed developer, the defect liability period is 24 months from vacant possession. Drain and apron faults are easiest to see in the wet season, so check again after the first monsoon and send a further written list if needed. The defect liability period guide says the developer is typically expected to make good within 30 days of receiving your written notice.

Hold off on landscaping, planter boxes or a porch extension that covers the apron until the drain and apron defects are fixed. Building over them hides the evidence.

How ClickBina can help

ClickBina offers a defect inspection service in KL & Selangor. We walk the drains and apron as part of the inspection, test the falls with water, write a numbered defect list for the developer, and can carry out rectification for items the developer does not cover or after the period ends. As an experienced KL & Selangor contractor handling whole-house refurbishment and trade coordination, the same team can re-lay drains, apron and porch works as one job.

Where damp points to a hidden leak, leak detection is a separate visit at RM300 – RM800. For repair work, a site visit to quote is arranged on WhatsApp, and any fee is confirmed before we come. We reply within the hour, the price we agree is a flat price with no hidden charges, and ClickBina is registered with SSM.

Sources & methodology

  • ClickBina car porch and apron sinking guide: apron-to-wall gap often filled with sealant then reopening; a slab not tied to the house needs a flexible joint; water from downpipes and broken drains softens the ground.
  • ClickBina defect liability period guide: 24 months from vacant possession, written notice, typical 30-day make-good period, inadequate repairs reported again.
  • ClickBina drain cleaning, rising damp and garden drainage guides.
  • ClickBina water leak detection guide: leak detection visit at RM300 – RM800.

Methodology: defect-versus-normal calls are qualitative. We do not quote fall ratios or crack widths as pass marks, because no homeowner-measurable figure is published for these.

Ready to book a defect inspection?

WhatsApp us your unit type, size and VP date for an inspection quote — we reply within the hour.

💬 WhatsApp for an inspection quote
Reply within the hourFlat price, no hidden chargesExperienced KL & Selangor contractor

Common Questions

Is standing water in a new perimeter drain a defect?
Usually yes. A drain should empty to its outlet after the rain stops; water left standing the next day points to a channel with no proper fall.
How can I test the drain fall myself at VP?
Pour a bucket of water at the high end of the drain and watch whether it runs all the way to the outlet without collecting in a low stretch.
The developer filled the gap between the apron and the wall with sealant. Is that enough?
Not if it keeps reopening. The apron and the house usually move separately, so the joint needs to be a proper flexible joint and any ongoing settlement looked into.
Should downpipes go into the drain?
Yes. A downpipe that discharges onto the apron or the ground beside the wall wets the base of the house every time it rains. List it as a defect.
Are fine cracks on the apron a defect?
Fine hairline shrinkage cracks are usually cosmetic. Cracks that step, widen or come with the slab dropping away from the wall should be listed.
Can I fix the drain myself before reporting it?
Do not alter it before the developer has seen it. Once you change the drain, the defect becomes your own work.
Does ClickBina inspect and repair external drains?
Yes. ClickBina checks drains and aprons during a defect inspection, writes the defect list and can carry out the rectification.
What is an apron drain?
It is the drain at the outer edge of the concrete apron around a landed house. Rain on the apron and roof water from the downpipes run into it, and it carries the water to the outlet away from the walls.
Is an apron drain the same as a perimeter drain?
In everyday use, yes. Both names describe the channel that runs round the house beside the apron. The apron itself is the concrete strip between the wall and that drain.
What is perimeter drain in Malay?
It is usually called longkang keliling rumah, and the drain beside the apron is often called longkang apron. The checks on this page apply whichever name your developer uses.
