Car Park Deck Polyurea Coating Malaysia 2026: Scope & Phasing
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Car Park Deck Coatings
Polyurea, Wear Layers and Traffic Phasing (2026)

A suspended deck is a roof with cars on it. What a trafficable coating system is actually made of, where polyurea earns its premium, and how a live car park gets coated zone by zone.

📍 We serve KL, Selangor & Putrajaya.

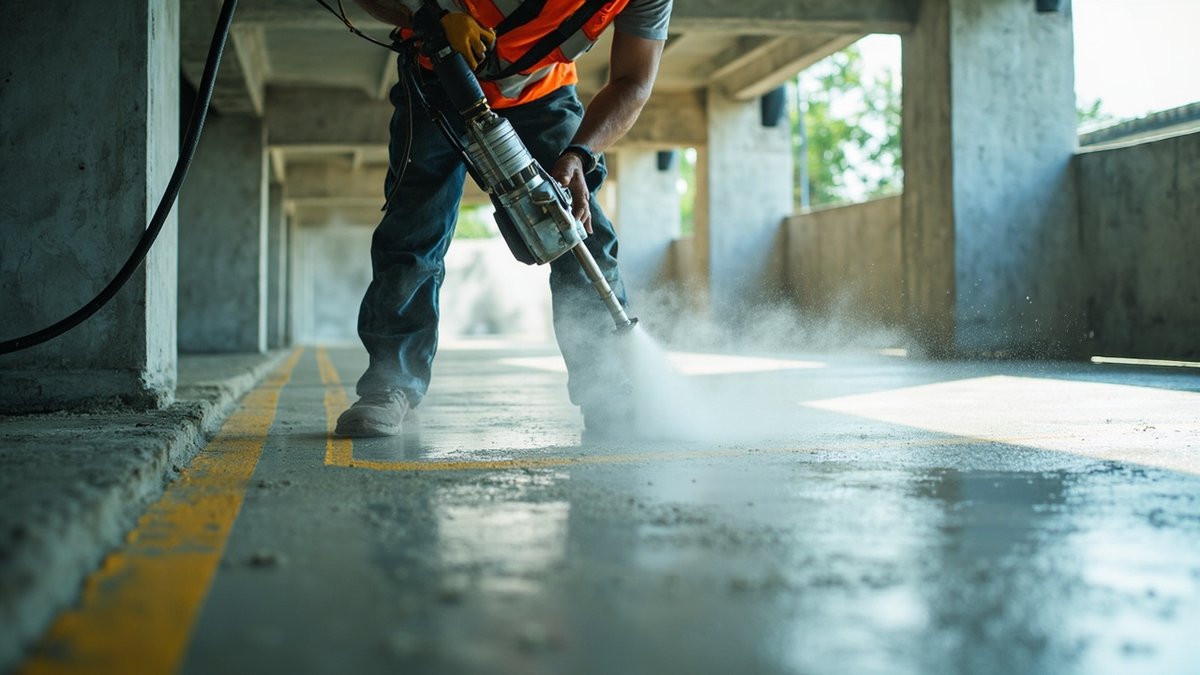

Seamless deck coating being spray-applied over a car park deck
A car-park deck coating has to do two jobs at once: survive tyres, turning and dropped loads as a wear surface, and keep water out of a structural slab with occupied space beneath it. Polyurea and other spray-applied elastomeric systems are specified for suspended decks because they stay flexible and go down seamlessly — but the coating is the last step. Falls, ponding, cracks and movement joints get fixed first, or the new deck fails at the same places the old one did. WhatsApp ClickBina for a fixed quote.

Two jobs, one system: wear surface and waterproofing

A car-park deck coating is asked to do two different things with one build-up, and most disputes about them come from a client buying one job and receiving the other. The first job is wear: taking tyre scuff, power steering turned on the spot, grit ground under wheels, dropped tools, spilled fuel and oil, and the point loading of a jack or a trolley. The second job is waterproofing: keeping rain, wash-down water and vehicle drip out of a structural slab that usually has parking, a lobby, a shop or a plant room directly underneath.

Those two jobs pull in different directions. A hard, abrasion-resistant film is good at wear and poor at bridging a crack that opens and closes; a soft, elastic membrane bridges movement beautifully and would be shredded by turning tyres within months. That is why a proper deck system is a stack rather than a single product: an elastic waterproofing layer taking the movement, and a tough, aggregate-filled wear layer above it taking the traffic. If a quotation names one product and one coat, ask which of the two jobs it is doing, because it is not doing both.

Why a car-park deck is not a warehouse floor

The most expensive misunderstanding in this market is treating a suspended car-park deck as a floor-coating job. A warehouse floor sits on the ground: if the coating is imperfect, water goes into the sub-base and nobody sees it. A suspended deck is a roof for whatever is beneath it, and every pinhole is a leak into somebody’s ceiling.

 Ground-bearing floor (warehouse, factory)Suspended car-park deck
What is belowSub-base and groundOccupied space — parking, lobby, shop, plant room
Consequence of a pinholeCosmetic; slab stays wet at worstA drip into the ceiling below and a complaint
Movement to accommodateMinimal; joints are saw cutsStructural movement, thermal cycling, live load deflection
ExposureUsually internal and dryOften open to sun and rain on the top deck
What the coating must beHard and abrasion-resistantElastic underneath, hard on top, continuous at every detail
Where it usually failsPoor preparation, moisture in the slabDetails — joints, upstands, outlets, kerbs, ramp junctions

Get a free quote on WhatsApp

WhatsApp us your job details — we'll reply as soon as we can with a free quote.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

This is exactly why a hard epoxy floor system is the right answer inside a factory and the wrong answer on an exposed suspended deck. Our epoxy floor cost guide covers the ground-bearing case in detail; the rest of this page is about the suspended one. Where the deck is a basement roof with earth or landscaping on part of it, the below-ground logic in basement waterproofing applies to that section as well.

What a trafficable deck system is made of

Read any credible deck specification and you will find the same layered logic, whatever the product family:

  • Preparation. Mechanical preparation of the slab — grinding, shot blasting or scarifying — to remove laitance, old coatings, oil contamination and tyre rubber, and to open the surface so the primer can key into it. This is where most of the labour goes and where cheap quotes save their money.
  • Repair. Crack treatment, spalled and delaminated concrete cut out and reinstated, falls corrected where water ponds, movement joints prepared as a separate detail.
  • Primer. Matched to the substrate and its moisture condition. On a damp slab an inappropriate primer is the reason a whole deck blisters.
  • Waterproofing layer. The elastic membrane that carries the movement and forms the continuous barrier, taken up every upstand, kerb and column base and dressed into every outlet.
  • Wear layer with aggregate. Broadcast aggregate bound into the coating to take abrasion and provide slip resistance.
  • Topcoat. The sacrificial, UV-stable layer that is renewed periodically without disturbing the waterproofing beneath it. This is the layer that makes a deck maintainable rather than disposable.
  • Details and reinstatement. Joint details, outlet dressings, line marking, bay numbering, signage and kerb painting.

The single most useful question you can ask a deck contractor is which of those layers they have priced. A deck “coating” that is primer plus one coloured coat is a paint job on a structural roof.

The systems a deck quote will name

Deck quotes in the Klang Valley name a small set of systems. These are what each is actually for — the priced rows are market bands (market estimate 2026, indicative Klang Valley), and the spray-applied and sheet systems are quoted per project because the price is driven by access, deck geometry and phasing rather than by area alone:

SystemMarket range (2026, Klang Valley)What it is for
Cementitious slurryRM6 – RM10 per sq ftrigid; sound slab areas only, never across a movement joint
Flexible two-part membraneRM8 – RM14 per sq fttolerates hairline movement; common under a wear layer
Liquid PU membraneRM10 – RM18 per sq ftseamless liquid membrane, the volume choice on decks
Torch-on bituminous membraneRM8 – RM15 per sq ftburied decks under screed or paving, not an exposed wear surface
Polyurea and spray-applied elastomericsQuoted per project after a site inspectionFast-curing, seamless, high elongation — the premium trafficked-deck option
Single-ply sheet membranes (EPDM, TPO)Quoted per project after a site inspectionSheet systems for large flat areas; need a separate wear surface where traffic runs

The system-level cost band for polyurea across all applications is already set out in our polyurea waterproofing guide. A car-park deck is quoted per project on top of that because the drivers are not square feet: how much of the deck is exposed to sun and rain, how many bays have to be released back each night, whether a spray rig can reach the level at all, the linear metres of upstand, kerb and joint detail, the amount of falls correction, and the extent of line marking to reinstate. Two decks of identical area routinely price very differently for those reasons.

Where polyurea fits — and where it is overkill

Polyurea earns its premium in specific situations rather than as a default. It suits the top deck of a multi-storey car park, where UV and thermal cycling are relentless and the membrane has to keep moving. It suits a deck over occupied retail or a lobby, where the cost of a leak is a business interruption rather than a stained ceiling. It suits ramps and turning circles that take the hardest wear. And it suits a car park where downtime is the real constraint, because a fast-curing system returns bays to service sooner — ask the contractor to state the return-to-traffic times for the specific system in writing rather than relying on a general claim.

It is overkill on a small, sheltered basement deck with no exposure and light traffic, where a liquid membrane with a wear layer does the job for less. It is also the wrong answer anywhere the substrate has not been dealt with: a high-performance coating over a ponding, cracked, contaminated slab is an expensive way to reproduce the existing failure. And it is strictly an applicator-with-a-rig job — the equipment and the handling are specialist, so the contractor selection matters more than the product name.

Substrate first: falls, ponding, cracks and joints

Every deck coating failure we are asked to look at falls into one of four substrate problems that were not fixed before coating.

  • Ponding. A deck that holds water after rain will hold it under the new coating too, and standing water finds every weakness in a topcoat. Falls have to be corrected with a screed or the low points drained before coating — not painted over and hoped about.
  • Blocked or badly detailed outlets. The outlet is where the deck actually gets rid of water. If it is silted, undersized or set proud of the finished level, the deck ponds regardless of falls. Outlets are cleared, lowered where necessary, and the membrane dressed into them.
  • Cracks. A live crack that moves will telegraph through any film. Cracks are routed and treated, and where a crack is structural rather than shrinkage, that is a structural repair before a waterproofing one — see epoxy injection crack repair.
  • Movement joints. The coating stops at the joint; the joint gets its own detail sized to its movement. A deck coating taken straight across an expansion joint tears along the joint line, often invisibly under the topcoat. The whole subject is in expansion joint leak repair.

Add contamination to that list. Car-park slabs are soaked in oil, fuel and tyre rubber at the bays and ramps, and no coating bonds to any of it. Mechanical preparation plus degreasing at the contaminated areas is a line item, not an optional extra.

Anti-skid, ramps and turning areas

Slip resistance on a car-park deck is a safety requirement and a wear requirement at once, and it is delivered by the aggregate broadcast into the wear layer rather than by the colour of the topcoat. Specify it by area rather than uniformly: ramps, turning circles, the approach to barriers and the pedestrian routes across the deck need a coarser, more aggressive finish than a straight run of bays, while a heavy anti-skid texture everywhere makes the deck harder to sweep and wash.

Ramps deserve their own paragraph in the specification. They take the highest shear from tyres, they are where vehicles brake and accelerate, they collect water running down them from the deck above, and they are the first place a deck coating wears through. Expect a heavier build-up on ramps, and expect the ramp finish to be renewed on its own cycle before the flat bays need attention. Pedestrian crossings and stair thresholds are the other places worth a distinct finish, and both should be marked on the drawing rather than agreed verbally on site.

Line marking, bay numbering and reinstatement

This is the line item that most often turns a competitive quote into an argument. Coating a deck destroys every line, arrow, bay number, disabled bay, hatched area, kerb stripe and directional marking on it, and all of it has to come back. Before you compare two prices, check that both include: a marked-up plan or photographic record of the existing layout taken before work starts; the number of bays to be re-marked; arrows, hatching, no-parking zones and speed markings; kerb and column painting; bay numbering and any unit or lot numbers; disabled and motorcycle bays; and the paint type for the markings, which has to be compatible with the deck system.

Two practical points. First, a re-coat is the natural moment to change a layout — if the bays are too tight or the circulation is awkward, decide before the deck is coated, not after. Second, agree who signs off the marking-out before the paint goes down, because moving a line afterwards means grinding into a brand-new deck.

Coating a live car park in bays

Almost no Klang Valley car park can close for the duration of a deck job, so phasing is part of the technical scope. The pattern that works is a rolling programme by zone, with each zone taken through the whole sequence before the next one opens.

Stage in each zoneWhat has to be agreed in advance
Notice and bay clearanceHow much notice residents or tenants get, where displaced vehicles go, who enforces it
Preparation (grinding, blasting)Permitted hours, dust control and extraction, protection of adjacent cars and lifts
Repairs and falls correctionProvisional quantities agreed, so extra repair does not stall the programme
Coating applicationVentilation and odour management, exclusion zone, no vehicle movement across wet areas
Cure periodReturn-to-foot and return-to-traffic times stated in writing for the system used
Line marking and reinstatementLayout signed off before paint, drying time before bays reopen
Zone handoverWho inspects, what is recorded, when the bays are formally released

The two things that wreck a phased deck programme are weather and access. Rain on a freshly prepared or freshly coated zone can cost the whole zone, so agree in writing how weather delay is handled and who carries it. And a deck that can only be reached by a vehicle ramp with a low headroom limits what equipment can get up there — establish that before the tender, not on the first morning.

Cure and return to traffic

Return to traffic is the number every building manager wants and the one most often glossed over. Ask the contractor to state, in writing and for the specific system being used in the specific conditions on your deck, three separate times: when the surface can be walked on, when light vehicles may return, and when the coating has reached full properties. They are three different milestones and the gap between them is where damage happens — a car driven onto a deck that is walkable but not fully cured leaves tyre marks that cannot be polished out.

Humidity and slab temperature change these times, and Klang Valley afternoons deliver both. Build a margin into the reopening schedule rather than promising residents an exact hour, and keep the exclusion barriers up until the contractor confirms the zone is released. It is far cheaper to keep twenty bays closed for another evening than to re-do a zone that was driven on early.

What a deck coating quote must itemise

A deck quote should be readable line by line: the deck area in square feet by level and by exposure; the preparation method and the standard of finish it will achieve; concrete repair and falls correction as provisional items with rates; outlet works; the linear metres of upstand, kerb and column-base detail; the movement joint detail as a separate item with its own system; the coating system named layer by layer with the number of coats; the anti-skid specification by area; line marking and reinstatement itemised as above; the phasing programme with zone sizes and reopening times; and how weather delay is handled commercially.

Then the closing items: what testing is carried out, who witnesses it, what photographic record is handed over, and what the warranty document covers, what voids it and who honours it. Our waterproofing quotation guide sets out the general checklist, questions to ask a waterproofing contractor covers the selection, and waterproofing scams covers the patterns to walk away from.

How a deck is priced, and why it is per project

The systems that are already published per square foot on this site give the honest context for the layers a deck is built from (market estimate 2026, indicative Klang Valley):

SystemMarket range (2026, Klang Valley)What it is for
Cementitious slurryRM6 – RM10 per sq ftrigid; best on sound concrete
Flexible two-part membraneRM8 – RM14 per sq fttolerates hairline movement
Liquid PU membraneRM10 – RM18 per sq ftseamless, the common flat-roof choice
Torch-on bituminous membraneRM8 – RM15 per sq ftflat roofs and podium decks
Roof waterproofing (all systems)RM8 – RM20 per sq ftthe whole-roof band across systems

Those bands describe the waterproofing layer, not a finished trafficked deck — which also carries preparation, repair, falls correction, an aggregate wear layer, a topcoat, joint details and marking reinstatement. That is why a car-park deck is quoted per project after a site inspection, and why polyurea and single-ply systems are not sensibly reduced to a rate on this page. For a large deck it is worth asking for the tender to be priced in two parts: a fixed price for the known scope and a schedule of rates for the repair quantities that only appear once the slab is exposed.

One comparison worth making before you commit: what does the deck cost you when it leaks? A drip into a retail unit or a lobby, a claim from a resident whose car was marked, or a corroding slab that eventually needs structural repair all cost more than the difference between two coating quotes. Our waterproofing cost per square foot guide sets out the same arithmetic across systems.

Testing, handover and maintenance triggers

Agree the completion checks before work starts, not at the end: a visual inspection of every detail — upstands, kerbs, outlets, joints, column bases — with the person who signs the deck off; a water test on each zone with somebody watching the soffit below where there is occupied space; a rain watch through the first heavy storm after completion, logged; and a handover pack with the system specification, the photographic record of each layer, the line-marking plan and the maintenance instructions.

Afterwards, maintenance is event-driven. Wash the deck down and clear the outlets before the monsoon and after any period of heavy leaf fall. Then act rather than monitor when you see: water ponding where it did not before; the aggregate texture worn smooth on a ramp or a turning circle; the topcoat chalking, fading or thinning to a different colour; a crack reappearing through the coating; sealant lifting at a joint; or a new stain on the ceiling below. Renewing a worn topcoat is a modest job; letting the wear layer go through to the membrane is not. How long waterproofing lasts covers what shortens a system’s working life, and why waterproofing fails covers the failure patterns.

Why ClickBina

ClickBina works on car-park and podium decks across Kuala Lumpur and Selangor for building owners, management committees and commercial landlords. We survey the deck before pricing it, quote the preparation, repair and falls correction as visible line items rather than burying them, treat every movement joint as its own detail, and set out the phasing zone by zone with return-to-traffic times in writing so a building manager can tell residents something true. Where a simpler liquid membrane with a wear layer would serve a sheltered basement deck, we will say so rather than sell a premium system into a job that does not need it. Send us the deck area, the level, what sits below it and photographs of the worst bays on WhatsApp for a fixed quote. Related reading: waterproofing services, podium deck waterproofing and drone thermal roof inspection.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we'll reply as soon as we can.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

Is a car-park deck coating the same as an epoxy floor?
No, and treating them as the same is the most expensive mistake in this market. An epoxy floor system is designed for a hard, dry, ground-bearing slab where a pinhole is cosmetic. A suspended car-park deck is a roof over occupied space, so it has to stay continuous at every detail and stay elastic enough to bridge movement. The usual answer is a layered system — an elastic waterproofing layer under a tough aggregate-filled wear layer and a renewable topcoat.
How much does polyurea car-park deck coating cost in Malaysia?
A finished trafficked deck is quoted per project after a site inspection, because the price is driven by exposure, deck geometry, access for a spray rig, the linear metres of upstand, kerb and joint detail, falls correction and the amount of line marking to reinstate — not by area alone. The system-level cost band for polyurea across all applications is set out in our polyurea waterproofing guide.
Can the car park stay open while the deck is coated?
Usually yes, as a rolling programme by zone. Each zone goes through notice and bay clearance, preparation, repair, coating, cure, line marking and handover before the next one opens. Agree the notice period, where displaced vehicles park, the permitted hours for grinding and blasting, and the return-to-traffic times in writing before work starts, and expect weather to move the programme.
How long before cars can drive on a newly coated deck?
Ask the contractor to state three separate times in writing for the specific system on your deck: when it can be walked on, when light vehicles may return, and when the coating reaches full properties. They are different milestones, and humidity and slab temperature change all three. Driving onto a deck that is walkable but not fully cured leaves tyre marks that cannot be polished out, so keep the barriers up until the zone is formally released.
Why does my deck coating keep failing at the same places?
Because the substrate problems were not fixed before coating. The four usual causes are ponding where the falls are wrong, blocked or badly detailed outlets, live cracks telegraphing through the film, and a coating taken straight across a movement joint so it tears along the joint line. Add oil, fuel and tyre-rubber contamination at the bays and ramps, which nothing bonds to. All five are preparation line items, not extras.
Does the quote include repainting the parking bay lines?
It has to be checked, because coating a deck destroys every line, arrow, bay number, hatched area and kerb stripe on it. A comparable quote includes a record of the existing layout taken before work starts, the number of bays to re-mark, arrows and hatching, kerb and column painting, bay and unit numbering, disabled and motorcycle bays, and a marking paint compatible with the deck system. This is a common source of a late variation.
Do ramps need a different specification from the flat bays?
Yes. Ramps take the highest shear from tyres, they are where vehicles brake and accelerate, they collect water running down from the deck above, and they are the first place a deck coating wears through. Expect a heavier build-up and a coarser anti-skid finish on ramps and turning circles, and expect them to be renewed on their own cycle before the flat bays need attention. Mark those areas on the drawing.
What should I inspect after the deck is finished?
Wash down and clear the outlets before the monsoon, then act rather than monitor when you see water ponding where it did not before, the anti-skid texture worn smooth on a ramp or turning circle, the topcoat chalking or thinning to a different colour, a crack reappearing through the coating, sealant lifting at a joint, or a new stain on the ceiling below. Renewing a worn topcoat is a modest job; letting the wear layer go through to the membrane is not.
