SBR Latex Waterproofing Mix: Not a Membrane (RM6-RM10)
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

SBR Latex & Cement Mix
Where It Works, and Where It Is a False Economy (2026)

SBR latex is a bonding aid, not a membrane. Here is what it genuinely changes in a cement mix, the jobs it is right for, and the jobs where a batched system is the only defensible answer.

📍 We serve KL, Selangor & Putrajaya.

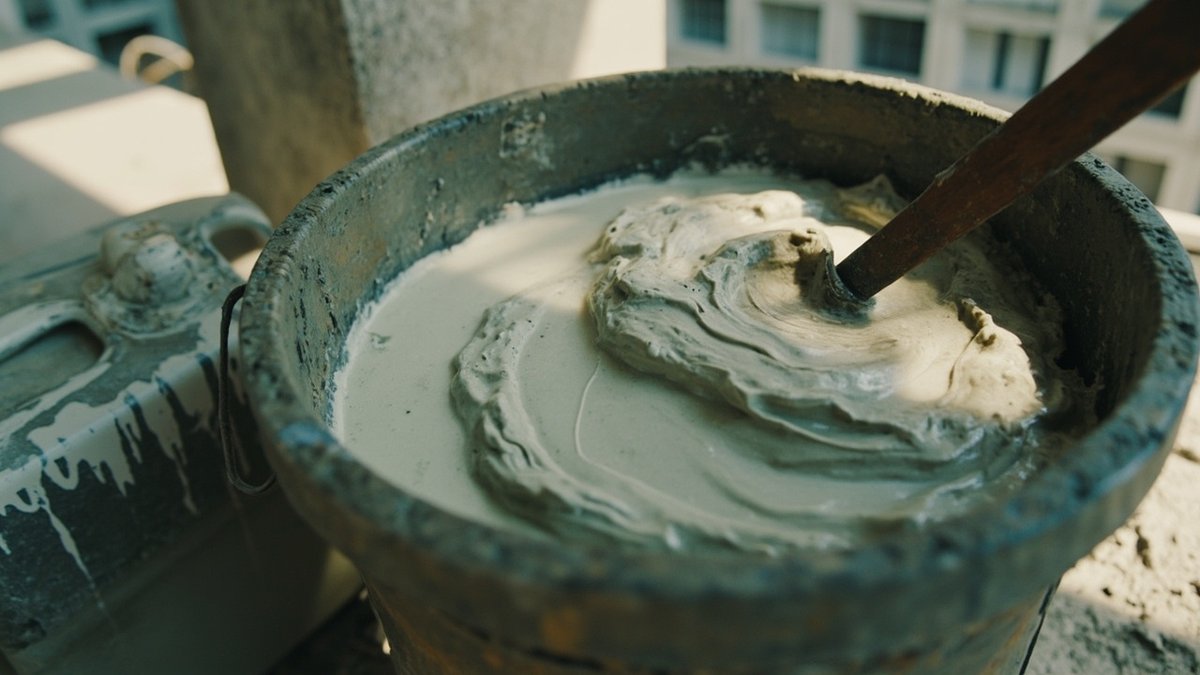

Cement and SBR latex being site-mixed in a bucket on a Malaysian site
SBR latex is a bonding and modifying admixture, not a waterproofing membrane. Stirred into a cement mortar or slurry it improves adhesion, cuts water absorption and reduces shrinkage cracking, which makes it a legitimate bond coat, patch mortar or screed modifier. What it does not do is bridge a moving crack, and a batch mixed in a pail on site carries no declared performance at all. Proprietary cementitious systems are installed at RM6 – RM10 per sq ft (market estimate 2026, indicative Klang Valley). WhatsApp ClickBina for a fixed quote.

What SBR latex actually is

SBR latex is a milky white liquid — a styrene-butadiene rubber polymer dispersed in water — sold in drums and pails as a bonding aid and mortar modifier. It is not a product you apply on its own. It is gauged into a cement mix, either replacing part of the mixing water in a mortar or render, or whisked with cement into a thin slurry that is brushed onto a prepared surface as a bond coat. As the mix cures, the water leaves and the polymer particles coalesce into a film through the cement matrix.

That is the whole mechanism, and it explains both what the material is good at and where people get it badly wrong. A polymer film woven through a cement mortar makes the mortar stickier, denser and less brittle. It does not turn the mortar into rubber. The finished thing is still cement: still rigid, still capable of cracking, still only as good as the surface it was bonded to and the ratio someone mixed it at.

What the polymer changes, and what it does not

The honest way to describe SBR is by what measurably changes in the mortar and what stubbornly does not.

PropertyWhat the polymer changesWhat it still cannot do
Adhesion to the substrateImproves it markedly — this is the main reason it exists, and why it is sold as a bonding aidBond to a dusty, oily, friable or laitance-covered surface; the polymer improves a good bond, it does not rescue a bad one
Water absorptionReduces it — a polymer-modified render soaks up less water than a plain oneBecome watertight under standing water or under pressure from behind; less absorbent is not the same as waterproof
Shrinkage and drying cracksReduces the fine crazing that a plain cement render is prone toBridge a structural or moving crack. A crack that moves will reappear straight through it
Flexural and tensile behaviourMakes the mortar less brittle and better able to take a thin sectionTurn a rigid cement layer into an elastomeric membrane with a crack-bridging capability
Abrasion resistanceImproves it, which is why it turns up in screeds and repair mortarsSurvive as a permanently exposed wearing or weather surface if the product was never rated for it
Declared performanceNothing — the mortar takes on the dose the mixer decided to use that morningGive you a number you can hold anyone to, or a warranty path if it fails

Get a free quote on WhatsApp

WhatsApp us your job details — we'll reply as soon as we can with a free quote.

RM180 for the inspection visit. If you go ahead with the repair, we'll give you a discount. To quote faster, tell us your area, property type and the size or quantity.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

Read the last row twice, because it is the row that decides most arguments. Every other property in that table depends on a ratio, and on a building site the ratio is a judgement rather than a measurement.

Three different things people mean by “SBR waterproofing”

Half the confusion in this subject is that one phrase covers three genuinely different jobs, with three different verdicts.

  • A bond coat. SBR and cement whisked to a thin slurry and scrubbed into a prepared concrete surface immediately before a render, screed or repair mortar goes on. This is the material doing exactly what it was designed for, and it is uncontroversial.
  • A modified mortar or render. SBR gauged into the mix water of a render, a screed or a patching mortar, to make it stick better, absorb less and crack less. Also legitimate, and widely specified.
  • A “waterproof coating”. Two or three brushed coats of SBR-and-cement slurry applied to a bathroom floor, a balcony or a roof and called the waterproofing layer. This is the one that produces callbacks, and it is where the argument in this guide sits.

The first two are ordinary construction practice. The third is a substitution: something specified as a bond coat is being asked to do the job of a membrane. It is not always wrong — there are places where a dense polymer-modified cement layer on sound, static concrete is a reasonable answer — but it is being chosen for the wrong reason far more often than for the right one.

Where a site-mixed SBR mortar is a legitimate spec

It is worth being clear that this material is not a cowboy product. It has been in the specification for decades, and there is a real list of jobs where it is the correct, professional choice.

  • Bonding new to old. A bond coat before a screed, a render or a patch, so the new layer does not simply lift off the old concrete. See cement render and skim coat for the wider plastering context.
  • Concrete repair and making good. Polymer-modified repair mortars for patching spalled concrete, filling chases and reinstating cover to reinforcement — the work described in spalling concrete ceiling repair.
  • Reducing absorption in a render. As one part of a wall build-up whose weather resistance comes from the whole system, not from the admixture. Wall waterproofing sets out what that system looks like.
  • Screeds that need to be tough and thin. Falls to a floor trap, a levelling layer, a thin topping in a plant room.
  • Dubbing out before a real membrane. Making a rough or dished substrate flat, sound and bonded so that the membrane specified above it has something proper to go onto — see concrete waterproofing for what sits on top.
  • Small, sound, static, sheltered repairs. A patch to a parapet coping, a haunching, making good around a new pipe sleeve in a dry concrete surface.

The common thread is that in every one of those jobs the SBR mortar is part of a build-up and something else is responsible for keeping water out. That is the material in its proper place.

Where it is a false economy, and a proprietary system is the right call

The important thing to understand is that the argument is not about chemistry. Polymer-modified cement is exactly what a proprietary two-part cementitious system is: a powder component and a liquid polymer component. The difference is not what is in the pail. The difference is batching control, a declared performance, an accountable supplier and a warranty path. A factory-batched system arrives with a fixed mixing ratio printed on the pack, a datasheet stating what it is rated to do and on what substrates, and a manufacturer standing behind it. A site mix arrives with a general-purpose admixture and whatever ratio the man with the drill decided on.

So the question to ask is never “is SBR any good?” It is: does this job need a performance you can hold someone to? When the answer is yes, the site mix is the false economy, because the few hundred ringgit saved on materials buys you a layer nobody has to defend.

The jobSite-mixed SBR mortarProprietary systemThe deciding factor
Bond coat under a screed or renderCorrect choiceUnnecessaryThe bond coat is not the waterproofing; nothing is being warranted
Patching spalled concrete, filling chasesCorrect choiceOptional, for structural repairA repair mortar, not a water barrier
Bathroom or toilet floor, under tileWrong callRight callWet-area membranes must be crack-bridging and be a defensible spec — see bathroom waterproofing
Balcony, exposed and movingWrong callRight callDaily thermal movement and standing water; a rigid layer cracks — see balcony waterproofing
Flat roof or podium deckWrong callRight callPonding, full UV and movement; needs a rated exposed system — see flat roof waterproofing
Water tank, internallyWrong callRight callA tank lining has to be certified for the stored water; a general admixture is not
Basement or retaining wall, water pushing from behindWrong callRight callNegative-side pressure needs a system rated for it — see basement waterproofing
Anything with a warranty attached, or a JMB or developer spec to satisfyWrong callRight callYou cannot warrant a mix nobody batched or declared
Sound, static concrete surface, sheltered, no warranty requiredDefensibleAlso fineJudgement call — the honest answer here is that either can work

Note the last row. Dismissing site-mixed SBR outright would be as dishonest as selling it as a membrane. There is a genuine middle where a dense polymer-modified layer on sound static concrete does the job. It is simply a much narrower band than the people selling it as cheap waterproofing suggest.

What it is commonly confused with

Confused withWhat is actually different
A two-part cementitious waterproofing systemSame broad chemistry, completely different control. A two-part system is factory batched to a fixed ratio, has a datasheet stating what it is rated for, and is warrantable. See cementitious waterproofing
A flexible or crack-bridging membraneA flexible membrane is designed to stretch across a moving crack. An SBR-modified cement layer is not, whatever it looks like when wet. See flexible waterproofing membrane
A crystalline waterproofing admixtureDifferent mechanism entirely — crystalline products react with moisture in the concrete to grow crystals that block pores. See crystalline waterproofing
A plasticiser or ordinary mortar additiveA plasticiser changes workability; the two are sometimes sold from adjacent drums and are not interchangeable
Acrylic bonding aidsBonding aids are sold in both SBR and acrylic grades, and the grades are specified for different exposures. Which one is arriving on site, and what its datasheet says about immersion and external exposure, is a fair question to ask
Grouting or crack fillingA different job with a different objective. See grouting versus waterproofing

Reading the datasheet, and what to ask the supplier for

Here is the awkward truth about a site-mixed layer: there is no datasheet for it. There is a datasheet for the latex in the drum, and it will describe the latex as a bonding aid and mortar modifier — which is what it is. It will not describe the slurry someone made from it as a waterproofing membrane, because that is not what the manufacturer sold.

So the useful questions are about the drum, not about the finished layer:

  • Ask for the product datasheet before the work starts, not after. If the supplier cannot produce one, that is the answer.
  • Read what the manufacturer says the product is for. A bonding aid described as a bonding aid is not a membrane because someone applied three coats of it.
  • Look for the stated mix ratios — bonding slurry, modified mortar, modified render are usually given as separate ratios, and they are not the same.
  • Look for what the datasheet says about external exposure and about immersion or permanently wet conditions. Grades differ, and this is the sentence that most often rules a product out of the job it is about to be used for.
  • Note any stated coverage rate and any stated curing requirement, and hold the applicator to both. A coverage rate stretched thin is the commonest way a legitimate product produces an illegitimate result.
  • Ask whether the product is rated for contact with potable water if it is going anywhere near a tank.

If the answer to any of those is a shrug, you are not buying a specification, you are buying a bucket. Choosing a waterproofing product and waterproofing brands in Malaysia cover how to compare what is on the shelf.

Dosing and mixing: the part that decides the outcome

With a factory-batched system, mixing is a rule: this much liquid to this much powder, mixed for this long, used within a stated pot life. With a site mix, every one of those is a decision, and every one of them is routinely got wrong in the same three ways.

Guessing the ratio. Latex is the expensive part of the pail, so under-dosing is the default direction of error. A mortar that was supposed to carry a meaningful polymer content and got a splash instead is, for practical purposes, a plain mortar with a receipt attached.

Adding latex and the usual water. The latex is largely water. If it is added on top of a normal gauging of water rather than in place of some of it, the mix ends up wetter than it should be, and a wetter cement mix is a weaker and more porous one. This single mistake undoes the whole reason for adding the polymer.

Over-mixing and re-tempering. Whipping air into a latex-modified mix leaves it full of voids; splashing more water into a batch that has started to stiffen so it can be used up ruins it. Both are common at the end of a working session, when a pail has to be finished.

None of this is exotic. It is simply the reason the same material produces an excellent bond coat in one pair of hands and a chalky, dusty layer in another, and it is why a proprietary system exists at all: not because the chemistry is better, but because the decisions have been taken away from the site.

Surface preparation and application

Bond is everything here, and bond is decided before any mixing starts. The substrate has to be structurally sound, clean and free of dust, laitance, curing compound, oil, paint and loose material. On concrete that normally means mechanical preparation — grinding, scabbling or high-pressure water — rather than a sweep with a broom. Existing cracks are cut out and treated as their own repair, not covered.

Two more application points do most of the damage when they are skipped. The first is pre-wetting: a dry, absorbent substrate pulls water out of a thin mortar or slurry before it can hydrate, so the surface is usually damped to a saturated but surface-dry condition — damp, not wet, with no standing water and no puddles in the low spots. The second is timing on a bond coat: the bond coat is there to be built onto while it is still live, so the render or screed goes on wet-on-wet within the window the datasheet gives, not the next morning. A bond coat that has been left to dry hard is now simply another surface to bond to, and a poor one.

Then curing. A thin polymer-modified layer in Malaysian afternoon heat, with a breeze across it, can dry far faster than it hydrates. Protection from direct sun and drying wind for the period the datasheet requires is not optional detailing, it is the difference between the layer the specification described and a dusty one.

How a site-mixed SBR job fails

What you seeWhat went wrongWhat prevents it
The layer lifts off in sheets or sounds hollow when tappedBonded to dust, laitance or a hard-dried bond coat rather than to sound concreteMechanical preparation, and building onto the bond coat within its window
Fine map cracking across the surfaceDried faster than it hydrated, or the mix was too wet, or it was not protected while curingCorrect gauging, damp substrate, protection from sun and wind while curing
A single straight crack that reopens after every repairA moving crack. No rigid cement layer will hold it — this is a detailing problem, not a product problemTreat the movement: see expansion joint leak repair and injection versus membrane
Chalky, dusty surface that marks your handUnder-dosed, over-watered, or cured out too fastMeasured gauging and proper curing
Damp still coming through after two or three coatsThe layer was never the right answer — water is arriving under pressure or from behindDiagnose the water path first; sealing the exit face moves the problem rather than solving it
Damp reappears elsewhere on the same wall or slabThe moisture path was closed at one point and simply took the next available routeTreat the source, not the stain — see rising damp
Nobody will take responsibility when it failsThere was never a declared performance to fall short ofA batched system with a datasheet and a named installer — see what a waterproofing warranty is worth

How to check it was applied properly

Almost all of this work disappears under a screed, a tile bed or a render, so the checks have to happen while it is visible. None of them requires any equipment.

  1. See the substrate before anything is mixed. Photograph it prepared: clean, sound, no dust, no loose material, cracks cut out and dealt with separately.
  2. See the container. Ask which product is being used and photograph the label. This is also the moment the datasheet question gets answered honestly.
  3. Watch one batch being gauged. Measured, with a container, not poured by eye. If latex is going in on top of a full gauging of water, say so at that moment rather than afterwards.
  4. Check the coats. Ask how many coats the spec calls for, that the second is applied across the direction of the first, and that the recoat window is respected.
  5. Tap the cured layer. A hollow, drummy sound over an area means it has not bonded there. This is easy to hear and impossible to argue with.
  6. Ponding test where it can be ponded. On a floor or a flat area, water held for a period agreed in advance with someone checking underneath is the only real proof. Agree the duration before work starts, not after a dispute.
  7. Photographs of every stage, because once the tiles are on, the evidence is gone. Questions to ask a waterproofing contractor covers the wider vetting.

What the alternatives cost, installed

The temptation with a site mix is that the material is cheap. It is worth setting that against what the proper systems actually cost installed, because the gap is usually smaller than the argument suggests once labour, preparation and making good are counted (market estimate 2026, indicative Klang Valley):

SystemPrice (2026, Klang Valley)Notes
Cementitious slurryRM6 – RM10 per sq ftrigid; best on sound concrete
Flexible two-part membraneRM8 – RM14 per sq fttolerates hairline movement
Liquid PU membraneRM10 – RM18 per sq ftseamless, the common flat-roof choice

Those are installed market ranges for the system, supplied and applied — not a shelf price for a pail, and not our quoted price. Product pack prices vary by dealer and by pack size and are not a useful basis for comparison; what you are buying is a prepared substrate, a declared material applied at a stated rate, and someone accountable for the result. On our own side, ClickBina leak detection and assessment is RM300 – RM800 per visit — that is our price, not a market range. Waterproofing cost per square foot breaks the systems down further, and how to read a waterproofing quotation covers comparing two of them line by line.

What to ask the contractor before anything is mixed

  • What exactly is going on this surface — a named product, or a mix made on site? If it is a mix, of what, at what ratio?
  • Can you show me the datasheet for the material in the drum, before you start?
  • Does the datasheet describe this product as a bonding aid, or as a waterproofing membrane?
  • What does it say about external exposure, and about immersion or permanently wet conditions?
  • How is the substrate being prepared, and by what method?
  • How many coats, at what rate, and how is the second coat applied relative to the first?
  • How is it being cured and protected, given the working temperature on the day?
  • Is any part of this work being warranted, by whom, and on the strength of what document?
  • What test will be done before it is covered, and what happens if it fails?

A contractor who answers those calmly is doing normal professional work. A contractor who treats them as an insult is telling you something useful. Waterproofing scams covers the patterns to walk away from.

Why ClickBina

ClickBina waterproofs and repairs leaks across Kuala Lumpur and Selangor, and on this subject the useful thing we do is diagnose before specifying. Whether a job needs a bonded, dense cement layer or a rated, warrantable membrane is decided by the water path, the movement and the exposure — not by what is cheapest in the pail — and we will say plainly which one your slab or wall actually needs, including when the honest answer is the cheaper one. We quote preparation, materials, coats and testing as separate lines so you can see what you are paying for, and where the picture is unclear we do a paid detection visit at RM300 – RM800 per visit. Browse all of our waterproofing and leak repair services, or send your job details on WhatsApp for a fixed quote.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we'll reply as soon as we can.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

Is SBR latex and cement good waterproofing?
It is a good bonding aid and mortar modifier, and it is not a waterproofing membrane. Mixed into cement it improves adhesion, reduces water absorption and reduces shrinkage cracking, which makes it legitimate as a bond coat, a repair mortar or a screed. What it cannot do is bridge a crack that moves, hold back water pushing from behind, or give you a declared performance you can hold anyone to.
What is the difference between SBR mixed on site and a two-part cementitious system?
Not the chemistry — both are polymer-modified cement. The difference is control. A two-part system is factory batched to a fixed ratio, carries a datasheet stating what it is rated for and on what substrates, and has a manufacturer behind it, so it can be specified and warranted. A site mix uses whatever ratio was decided that morning, and there is no declared performance to fall short of if it fails.
Can I use SBR to waterproof my bathroom floor?
For a bathroom under tile, a proprietary system is the right call. A wet-area floor needs a layer that can accommodate hairline movement, that is rated for the exposure, and that someone will stand behind — because when it fails, the tiles come off before anyone can reach it. A site-mixed rigid cement layer meets none of those three tests, and the saving on materials is small against the cost of hacking a bathroom twice.
Where is site-mixed SBR mortar genuinely the right choice?
Bonding new work to old concrete as a bond coat before a screed or render; polymer-modified repair mortars for patching spalled concrete and reinstating cover; reducing absorption in a render as part of a wider wall build-up; thin tough screeds laid to falls; and dubbing out a rough substrate flat and sound before a proper membrane goes on. In every one of those the SBR layer is part of a build-up, and something else keeps the water out.
How much SBR latex do I add to cement?
That is set by the product datasheet, not by a rule of thumb, and the ratios differ for a bonding slurry, a modified mortar and a modified render. Ask for the datasheet before the work starts and hold the applicator to the stated ratio. Two errors matter most: under-dosing, because latex is the expensive part of the pail, and adding latex on top of the normal gauging of water instead of in place of some of it, which leaves the mix too wet.
Why did my SBR coating fail?
Usually one of four reasons. It was bonded to dust or laitance rather than to prepared concrete. It was under-dosed or over-watered, so it cured chalky. It dried faster than it hydrated in the afternoon heat and was never protected. Or it was the wrong answer to begin with, because the crack moves or the water is arriving from behind, and a rigid cement layer was never going to hold either of those.
Is SBR cheaper than a proper waterproofing system?
The material is cheaper. The job often is not, because most of the cost of any waterproofing job is preparation, labour and making good rather than what is in the pail. Proprietary cementitious systems are installed at RM6 – RM10 per sq ft and flexible two-part membranes at RM8 – RM14 per sq ft (market estimate 2026, indicative Klang Valley), supplied and applied. Set that against the cost of hacking and re-tiling a floor a second time, and the saving usually disappears.
Can SBR mortar be used in a water tank?
Anything going inside a tank that stores water for use in the building has to be rated for contact with that water, and a general-purpose bonding aid normally is not. This is a question for the datasheet before anything is bought, and the honest position is that if the datasheet does not address it, the product is not suitable for that use. Tank linings are covered separately under our water tank work.
