PU vs Silicone Sealant
Polyurethane or Silicone for an Exterior Joint (2026)

Paintability, exposure and substrate decide the family; the declared movement class and the joint design decide whether the bead survives a Malaysian facade.

📍 We serve KL, Selangor & Putrajaya.

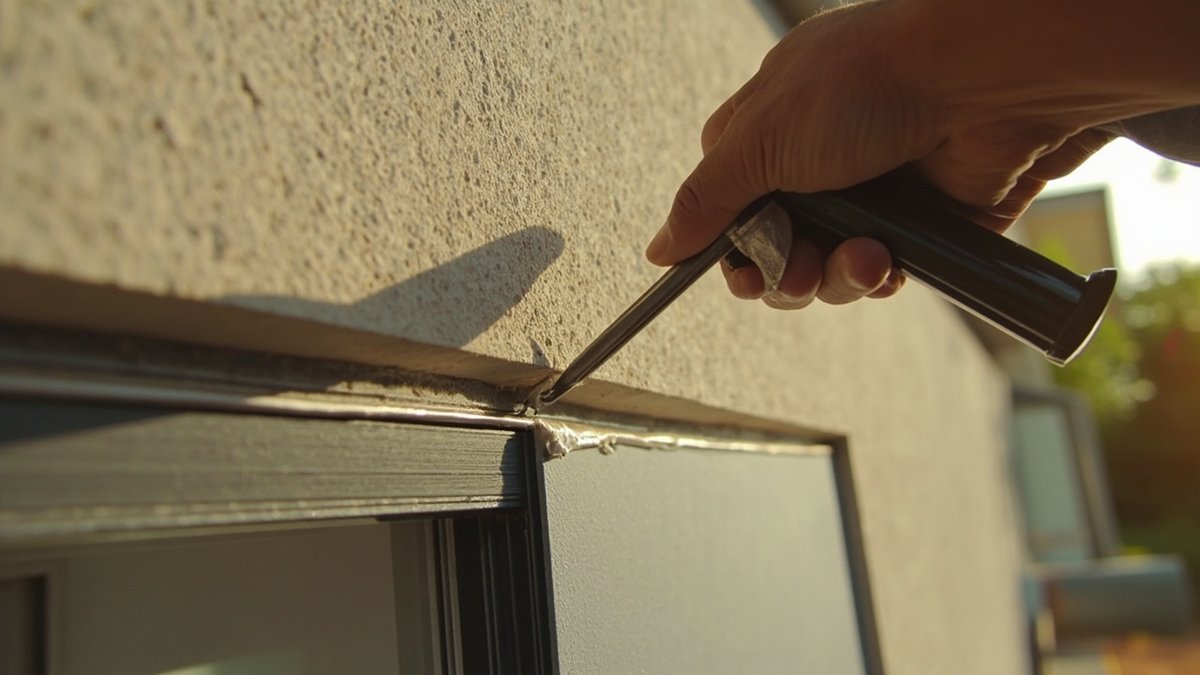

A bead of sealant being gunned into an exterior wall joint beside a window frame
PU vs silicone sealant for an exterior joint usually comes down to one question: does this joint need to be painted? Polyurethane takes paint and bonds readily to concrete, render and masonry. Silicone does not take paint at all, but holds up outstandingly to sun and heat and is the usual answer at glass, metal and glazed surfaces. Movement capability is a declared property of the individual product, not of the family — ask which class the datasheet states. WhatsApp ClickBina for a fixed quote.

Two families, one joint: what actually separates them

Polyurethane and silicone are both elastomeric joint sealants. Both come in a cartridge, both are gunned into a joint and tooled, both stay flexible after curing, and on a shelf they look interchangeable. They are not, and the differences that matter outdoors are not the ones people usually argue about.

The useful way to think about it is that silicone is a weathering material and polyurethane is a construction material. Silicone is exceptionally stable against sunlight and heat, sticks readily to glass and glazed non-porous surfaces, and cannot be painted. Polyurethane is tougher and more abrasion-resistant, bonds well to porous masonry surfaces, takes paint, and is more vulnerable to prolonged sunlight unless it is overcoated. Neither is better. They answer different questions, and the question your joint is asking is usually obvious once you know to ask it.

PropertyPolyurethaneSiliconeWhat it means on an exterior joint
PaintabilityGenerally paintable, and often specified because it will be paintedNot paintable — paint beads and peels off itThe single most decisive property on a painted facade. Choose silicone at a joint that will be repainted and you have created a permanent problem
Sunlight and heat stabilityMore vulnerable to prolonged direct sun; commonly overcoated for exposed positionsVery stable, which is why it dominates glazing and exposed non-porous jointsOn a fully exposed west-facing elevation this is a real consideration, and the datasheet states what the product is rated for
Adhesion to concrete, render, masonryGenerally good, often with a primer on porous substratesVariable by product; frequently needs a primer and is not always suitableAsk what the datasheet lists as approved substrates, and whether a primer is scheduled for yours
Adhesion to glass, glazed tile, anodised metalVaries by product; check the substrate listThe usual choice at these surfacesA window perimeter with a glazed or metal face is a different problem from a rendered one
Toughness and abrasion resistanceTougher, resists tearing and rubbing betterSofter, less resistant to abrasion and tearingAnywhere a joint gets walked on, brushed past, or hit by debris
Dirt pick-up on a facadeLower, and paint hides the joint anywayHigher — silicone joints on a light facade often darken into visible linesAn aesthetic issue on a front elevation, and a common source of complaints
Movement capabilityDeclared per product on the datasheetDeclared per product on the datasheetDo not treat this as a family trait. Two silicones can differ from each other more than a silicone differs from a polyurethane
ReversibilityCan be cut out and the joint resealed or paintedLeaves a residue that nothing else bonds to, including new siliconeThis decides how easy the next maintenance cycle will be

Get a free quote on WhatsApp

WhatsApp us your job details — we'll reply as soon as we can with a free quote.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

Hybrid MS polymer: the third option worth knowing about

The two-family framing is slightly outdated, because a third option sits between them: hybrid sealants based on modified silane or MS polymer technology. These are marketed as combining the weathering behaviour associated with silicones with the paintability and broad substrate adhesion associated with polyurethanes, often without a primer on many surfaces, and frequently as non-staining.

The honest position is that they are a real and widely used option, that they are not uniformly better, and that the specific product’s datasheet is still the arbiter of what it will do and where. They are usually more expensive per cartridge than a general-purpose tube, which on a facade with a lot of linear metres is a real cost rather than a rounding error. If a contractor proposes one, the questions are exactly the same as for the other two: what movement class does it declare, what substrates is it approved for, does it need a primer on this one, and is it stated as paintable with the paint being used?

What “PU silicone” means at the hardware shop

“PU silicone” is how many people ask for a sealant at the counter, but it runs two different families together. A cartridge is normally sold as one family — polyurethane (PU), silicone, or a hybrid such as MS polymer — and the three behave differently on an exterior joint. The label and the datasheet say which one you are holding: look for the chemistry, whether it is stated as paintable, the declared movement class, and the substrates it is approved for. If the label says silicone, treat it as not paintable whatever the shop calls it; if it says polyurethane, check whether the datasheet expects it to be overcoated in full sun.

Movement: a declared property, not a family trait

This is where most advice goes wrong. People ask which family “moves more”, as though every silicone behaved one way and every polyurethane another. They do not. Movement capability — how much a cured bead can stretch and compress relative to the joint width, repeatedly, without tearing or losing adhesion — is a declared property of the specific product, printed on its datasheet as a class. Low-modulus grades in both families are formulated to move; high-modulus grades in both are formulated to be stiff and strong. Picking the family and ignoring the grade is picking the wrong half of the specification.

So the practical rule is simple and it is a question, not a number: which movement class does this product declare, and is it enough for the movement this joint will actually see? Ask for the datasheet before the work, not after. And notice the second half of that sentence — the joint’s movement is a function of what it is separating, how long that element is, and how much the sun heats it, so a joint between two long render panels on a west elevation is a different problem from a bathroom window reveal on a shaded side.

If a joint is moving enough that this question feels hard, the honest conclusion may be that it is a movement joint rather than a sealed gap, and it belongs in a different specification altogether — see expansion joint leak repair.

Paintability: the decision you cannot reverse

If only one thing from this page is remembered, make it this. Ordinary paint does not stick to ordinary silicone. It beads while wet and flakes once dry, and every subsequent repaint on that elevation will do the same thing on that line until someone cuts the sealant out and cleans back the substrate on both sides. Specialist overcoating products and specifically paintable grades do exist, and the datasheet is the only place that claim can be checked — but unless a supplier states it in writing for the exact sealant and the exact paint, treat a silicone joint on an elevation that gets repainted as a permanent problem you have created.

That makes the sequencing question decisive on a painted wall. A joint between rendered surfaces on an elevation that gets repainted every few years is a polyurethane job, because the bead becomes part of the painted surface and disappears. Put silicone there and the painter will either leave a visible untouched line down the facade or waste an afternoon painting something that will peel by the next monsoon.

There are two honest qualifications. First, paintable is not a licence — the sealant has to be fully cured before it is painted, and the paint has to be flexible enough to move with the joint or it will crack in a fine line along the bead. Second, some products are sold as paintable with conditions attached, so this is another datasheet question rather than an assumption. If the facade is being repainted anyway, building facade waterproofing and paint bubbling and peeling cover how the coating and the joints interact.

Sun, heat and the Malaysian facade

A Malaysian elevation is a hard place for any organic material. Full equatorial sun, high surface temperatures through the middle of the day, a cold downpour in the afternoon, and that cycle repeating all year without a winter to slow it down. Two consequences follow for sealant selection.

The first is exposure. Silicone’s resistance to sunlight and heat is its main technical advantage, and it is why it holds up in fully exposed positions where other families need help. Polyurethane in permanent full exposure is more commonly specified with an overcoat — which is convenient, because the elevations where you would want a polyurethane are painted ones anyway. What matters is that the decision is made deliberately: an unpainted polyurethane bead sitting in full sun on a west elevation is doing without the protection its specification usually assumes.

The second is movement. Heat is what drives most joint movement on a facade, because materials expand as they warm and the joint is where that expansion is absorbed. A joint that looks static in the morning may be opening and closing measurably by mid-afternoon, and it is doing that every day of the product’s life. That is why the movement class on the datasheet is not a technicality, and why a bead squeezed into a joint too narrow to stretch fails whichever family it came from.

Substrate and adhesion: where each one struggles

Adhesion is where a joint is won or lost, and it is more specific than the family name suggests. Every sealant datasheet carries a list of substrates it is approved for and a primer schedule saying which of them need priming first. That list, not the family, is the answer.

SubstrateWhat usually gets specifiedWatch out for
Cement render, plaster, fair-faced concretePolyurethane, commonly with a primer, especially where the joint will be paintedPorous, dusty surfaces need proper preparation; some silicones are not approved on cementitious substrates at all
Glass and glazed tileSiliconeNothing else bonds as readily, and nothing bonds afterwards to the residue it leaves
Aluminium and powder-coated metalDepends entirely on the product’s approved substrate list and coating typeCoatings vary; a bead that grips one powder coating may not grip another
Natural stone and porous claddingCheck for a non-staining grade specificallyStaining is a genuine risk on porous stone; there are products formulated to avoid it and products that are not
Bitumen, asphalt or an existing membraneCompatibility must be confirmed on the datasheet before anything is appliedSome materials are not compatible with bitumen and will soften or fail to bond
Polycarbonate and some plasticsOnly a product whose supplier explicitly states compatibilityThe wrong chemistry can attack the sheet rather than merely fail — see skylight sealant repair
Anywhere silicone has been used beforeNothing, until the residue is physically cut out and cleaned offThis is the commonest hidden cause of a resealing job failing on day one

Staining, dirt pick-up and the silicone residue trap

Three long-term consequences of the substrate decision are worth weighing before it is made for you by whoever is holding the gun.

  • Dirt pick-up. Silicone tends to attract and hold dust and airborne dirt, so a silicone joint on a light-coloured facade often reads as a darker line after a couple of years. On a rear elevation nobody cares. On a front elevation, people do.
  • Staining on porous substrates. On some natural stone and porous cladding, sealants can produce a stain running out from the joint into the surrounding material. Where the substrate is porous and visible, there are grades formulated specifically to avoid this, and that is a question to ask before the joint is filled rather than after.
  • The residue trap. Once silicone has been used on a joint, that joint is a silicone joint until someone mechanically cuts the old material out and cleans the substrate back on both faces. Nothing bonds to silicone residue — not paint, not polyurethane, not fresh silicone. This is why the cheapest tube used in the wrong place is so often the most expensive decision on the elevation.

Acetoxy, neutral and moisture cure: what the smell tells you

Silicone comes in two broad cure types and you can tell them apart by nose. Acetoxy-cure silicone smells strongly of vinegar while it cures, because it releases acetic acid. It is the cheap general-purpose tube, and that acid is why it is generally unsuitable on cementitious surfaces and on many metals, where it can corrode or attack the substrate. Neutral-cure silicone has little or no vinegar smell and is the type normally specified for construction and glazing work outdoors. If a tube smells strongly of vinegar and it is about to go against render, concrete or metal, that is worth stopping for.

Polyurethane sealants cure by reacting with moisture in the air. Practically, that means humidity and temperature affect how quickly a bead becomes handleable and how long it takes to reach full properties, and the datasheet states both a skin time and a full cure period. This matters more often than people expect, because two things must not happen before it has cured: it must not be painted, and it must not be washed down or rained on hard. Getting a bead wet before it has skinned is a common way to lose a morning’s work on a facade, and in Malaysia the afternoon storm is a scheduling constraint rather than a possibility.

The instruction that follows from all of that is the same in both families: get the cure and recoat periods from the datasheet, plan the day around them, and do not let anyone talk you into painting a joint the same afternoon it was gunned.

Joint by joint: what usually gets specified where

Exterior jointUsually specifiedWhy
Window or door frame perimeter against render, on a painted wallPolyurethaneThe joint has to be painted with the wall, and it bonds well to render
Window frame against a glazed, tiled or metal-faced revealSiliconeNon-porous surfaces, no paint involved, full exposure to sun
Glass to frame, and glazing generallySiliconeThe family designed for it — see window leak repair
Movement joints between render panels or blockwork baysDepends on the declared movement class, and on whether the wall is paintedThis is a movement joint first and a material choice second
Roof-to-wall and awning-to-wall junctionsNeither, as the primary seal — the flashing is the primary sealSealant alone at a junction like this is the classic failure — see awning joint wall leak
Parapet copings and capping jointsDepends on exposure and whether the parapet is paintedFully exposed, high movement, and a common leak path — see parapet wall leak
Aircon pipe and cable penetrations through an external wallUsually polyurethane on render, with the detail formed correctly firstThe sleeve and its fall matter more than the sealant — see aircon trunking penetrations
A joint that gets walked on or brushed pastPolyurethaneToughness and abrasion resistance decide it
A hairline crack across a wall faceNeither — this is not a jointA crack is filled, bridged or injected, not sealed as though it were a designed gap

Joint design: the part that decides the outcome

Here is the uncomfortable truth of this subject: joint design beats product choice. A correctly designed joint filled with a merely adequate sealant outlasts a badly designed joint filled with the most expensive tube on the shelf, every time. Four principles do almost all of the work, and none of them requires a number to understand.

  1. A bead must be wide relative to its depth. A sealant accommodates movement by stretching across the joint, and a deep, narrow plug of sealant cannot stretch — it is thick in exactly the direction that does not help. Manufacturers publish the ratio and the minimum and maximum depth in their application guides; ask for the figures on the datasheet for the product being used, and check the joint is being formed to them rather than simply filled.
  2. Two-sided adhesion, never three. The bead should stick to the two opposing faces of the joint and not to the back of it. If it is bonded on three sides, it cannot stretch when the joint opens and it tears — usually straight down the middle. This one mechanism explains a very large share of failed facade joints.
  3. Which means a backer rod, or a bond-breaker tape. A closed-cell foam rod pushed into the joint to a consistent depth does two jobs at once: it stops the sealant bonding to the back of the joint, and it sets the depth of the bead. Where the joint is too shallow for a rod, a bond-breaker tape across the back does the first job. A joint packed solid with sealant to the back is a worse joint than one with a rod in it, and it uses more material.
  4. Tool the bead. Pressing the bead firmly into the joint with a tool after gunning does something a gun alone cannot: it forces the sealant into contact with both faces so it actually wets them. A bead laid on and left proud is bonded far less than it appears to be, and it collects dirt on its raised face.

Preparation sits underneath all four. Joint faces have to be sound, clean, dry and free of dust, laitance, oil, old sealant and loose coating, and primed where the datasheet schedules a primer. A sealant is only ever as good as the two faces it is holding on to.

What a sealed joint is commonly confused with

Confused withWhat is actually different
WaterproofingA sealed joint is a line of defence at one gap. It is not a waterproofing system, and it will not stop water arriving through a wall face — see external wall water seepage
A flashingA flashing directs water away by its shape. Sealant relies on adhesion. Replacing a flashing with a bead removes the geometry that was doing the work
Crack repairA crack is not a designed joint. Filling a moving crack with sealant produces a bead in tension that tears — see injection versus membrane
GroutGrout is rigid and fills between tiles; sealant is elastic and fills a movement gap. They are not substitutes — see grouting versus waterproofing
Facade coatingA coating treats the whole wall surface; joints are detailed separately as part of it — see building facade waterproofing
Hardware-store DIY sealingDifferent job and different scale. The DIY shelf, what it is worth and where it stops is covered in DIY waterproofing sealants

How an exterior sealant joint fails

What you seeThe mechanismHow to avoid it
The bead has torn down its centre lineThree-sided adhesion, or a joint too narrow for the movement it seesBacker rod or bond-breaker tape, and a bead wide relative to its depth
The bead has pulled cleanly away from one faceAdhesion failure — a dusty or damp face, a skipped primer, or an unapproved substratePreparation, and the primer schedule from the datasheet
Paint peeling in a line along the jointSilicone was used where the wall gets paintedPolyurethane or a paintable hybrid on painted elevations
The joint has gone hard and crazedAn exposed product ageing in full sun without the protection its specification assumedMatch exposure to the product, or overcoat where the datasheet expects it
A dark line down a light facadeDirt pick-up on a silicone beadAn aesthetic decision to make deliberately before the joint is filled
The new sealant would not stick anywhereOld silicone residue was left in the jointCut the old material out mechanically and clean both faces back
It leaked again within weeks in the same placeThe sealant was never the right answer — water is entering elsewhere and exiting hereDiagnose the entry point first — see why waterproofing fails
The bead was applied over an old oneNew sealant bonded to old hardened sealant, so it is only as good as what is underneathNever overlay; always cut out and start from the substrate

How to check it was done properly

  1. Look into the joint before it is filled. Old sealant fully cut out, faces clean and dry, no dust, no loose coating. Photograph it.
  2. Confirm there is a backer rod pushed to a consistent depth, or a bond-breaker tape where the joint is too shallow for one. This is the check that is skipped most often and matters most.
  3. Ask which product and see the datasheet. Movement class declared, your substrate on the approved list, and the primer schedule — and whether a primer was actually used.
  4. Check the bead was tooled, not just gunned. It should be pressed into the joint and smooth, not sitting proud like a sausage on the surface.
  5. Check it is not bridging. Sealant smeared across the wall face on either side of the joint is not a wider joint, it is a wider mess, and it will peel off the face first.
  6. Check the ends and corners. Joints should be continuous, with no gaps at corners, changes of direction or where the crew stopped for the day.
  7. Respect the cure before anything else happens. No painting and no washing down until the datasheet’s period has passed, and no work in front of an afternoon storm.
  8. Hose test where it can be tested, after full cure, playing water on the elevation above the joint with someone inside watching. Agree in advance what happens if it still leaks.

What to ask before the gun comes out

  • Which product, and can I see the datasheet before you start?
  • What movement class does it declare, and is that enough for this joint?
  • Is my substrate on its approved list, and does it need a primer? Are you using one?
  • Will this joint ever be painted? If yes, is this product stated as paintable?
  • Is a backer rod going in, and to what depth? If the joint is too shallow, what is stopping three-sided adhesion?
  • Is the old sealant being cut out completely, or is new material going over old?
  • How long before it can be painted or washed down, and how does today’s weather affect that?
  • Is the sealant the primary seal here, or is there a flashing or a detail that should be doing that job?

That last question is the one that saves the most money. On many of the junctions where sealant gets used outdoors — roof to wall, awning to wall, a coping joint — the sealant was never meant to be the primary barrier, and a bead is being asked to stand in for a detail that is missing. Questions to ask a waterproofing contractor covers the wider vetting, and waterproofing scams covers the patterns to walk away from.

Where the money actually goes

The cartridge is rarely the cost. Access, preparation, cutting out the old material and the linear metres involved are, and on a facade that is what makes the difference between a morning and a week. Product and pack prices vary by dealer and by grade and are not a useful basis for comparing quotes; what to compare is the metres of joint, the preparation, whether a primer is included and what access is being used.

It is also worth knowing what the alternative looks like if the joints turn out not to be the problem. Where water is arriving through the wall face rather than through a joint, the work is a coated area rather than a sealed line, and that is priced per square foot (market estimate 2026, indicative Klang Valley):

SystemPrice (2026, Klang Valley)Notes
Acrylic roof coatingRM4 – RM10 per sq ftan exposed area coating, when the wall face is the problem rather than the joint
Cementitious slurryRM6 – RM10 per sq fta rigid system on sound concrete, where the substrate suits it

Those are installed market ranges for the system, supplied and applied — not a shelf price and not our quoted price. On our own side, ClickBina leak detection and assessment is RM300 – RM800 per visit — that is our price, not a market range, and on a wall that has been sealed twice already it is usually the cheapest money spent. External wall water seepage works through the diagnosis, and how to read a waterproofing quotation covers comparing two quotes line by line.

Why ClickBina

ClickBina repairs leaks and waterproofs buildings across Kuala Lumpur and Selangor, and on external joints the first job is deciding whether the joint is genuinely the leak path at all — because a wall that has been sealed twice and still leaks is usually telling you the water is coming in somewhere else. We diagnose before quoting, we quote preparation, cutting out, backer rod, materials and access as separate lines so you can see what you are paying for, and we will say plainly when the right answer is a flashing or a coated area rather than another bead. Where the picture is unclear we do a paid detection visit at RM300 – RM800 per visit. Browse all of our waterproofing and leak repair services, or send details of the joint and the damp patch inside on WhatsApp for a fixed quote.

Ready to price your waterproofing job?

WhatsApp us your job details for a free quote — we'll reply as soon as we can.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

Should I use polyurethane or silicone on an exterior joint?
Start with one question: will this joint ever be painted? If yes, polyurethane, because paint does not stick to silicone and never will. If the joint is against glass, glazed tile or metal and no paint is involved, silicone is the usual choice. After that, check the specific product’s datasheet for the movement class it declares, whether your substrate is on its approved list, and whether it needs a primer.
Can you paint over silicone sealant?
No. Paint beads on silicone while wet and flakes off once dry, and no primer or undercoat reliably changes that. It is not a brand problem, it is the material. If a joint on a painted elevation has been sealed with silicone, the only real fix is to cut the sealant out mechanically, clean both faces back to sound substrate, and reseal with a paintable product — because nothing bonds to silicone residue either.
Which sealant lasts longer outdoors, PU or silicone?
There is no honest general answer, because it is decided by the individual product, the joint design and the exposure rather than by the family. Silicone is the more stable of the two against sun and heat, which is why it dominates exposed glazing. But a well-designed joint with a backer rod and two-sided adhesion outlasts a badly designed one whatever went into it. Any durability figure a product claims is on its datasheet — ask for it.
What is a backer rod and do I really need one?
It is a closed-cell foam rod pushed into the joint before the sealant, and it does two jobs. It sets the depth of the bead, so the sealant is wide relative to its depth and can actually stretch. And it stops the sealant bonding to the back of the joint, which is what causes three-sided adhesion — a bead stuck on three faces cannot stretch when the joint opens, so it tears down the middle. Yes, you need one.
Why did my sealant peel off the wall?
Usually adhesion failure at one face rather than the sealant itself giving up. The common causes are a dusty, chalky or damp joint face, a primer the datasheet scheduled and nobody used, a substrate the product was never approved for, or new sealant applied straight over old hardened material so it is only as good as what is underneath. All four are preparation problems, and all four are avoidable.
Is the vinegar smell from silicone a problem?
It tells you the tube is an acetoxy-cure silicone, which releases acetic acid as it cures. That makes it generally unsuitable against cementitious surfaces and many metals, where the acid can attack or corrode the substrate. Neutral-cure silicones have little or no vinegar smell and are the type normally specified for outdoor construction work. If a tube smells strongly of vinegar and it is about to go against render or metal, stop and check.
Can sealant stop water coming through my external wall?
Only if the water is genuinely entering through that joint. A bead of sealant is a line of defence at one gap, not a waterproofing system, and it will do nothing about water arriving through the wall face, up from the ground, or through a failed flashing above. If a wall has been sealed once already and still leaks, the useful next step is finding the entry point rather than buying another cartridge.
What about MS polymer or hybrid sealants?
They are a genuine third option, marketed as combining silicone-like weathering with polyurethane-like paintability and broad adhesion, often without a primer and often as non-staining. They are not automatically better and they usually cost more per cartridge, which matters on a facade with many linear metres. Judge one the same way as the other two: movement class declared, approved substrate list, primer schedule, and whether it is stated as paintable.
Is PU silicone the same as polyurethane sealant?
No. “PU silicone” is a shop-counter name, not a product family. Polyurethane (PU) sealant takes paint and bonds readily to render and masonry; silicone does not take paint at all but is very stable in sun and heat. Read the cartridge label and datasheet to see which chemistry you are actually holding.
Is PU sealant better than silicone sealant outdoors?
Neither is better across the board. PU sealant is the usual choice on a joint that will be painted, on render and masonry, and where a joint gets walked on or brushed past; silicone sealant is the usual choice against glass, glazed tile and metal where no paint is involved and sun exposure is high. Movement capability is declared per product, so compare datasheets, not families.
