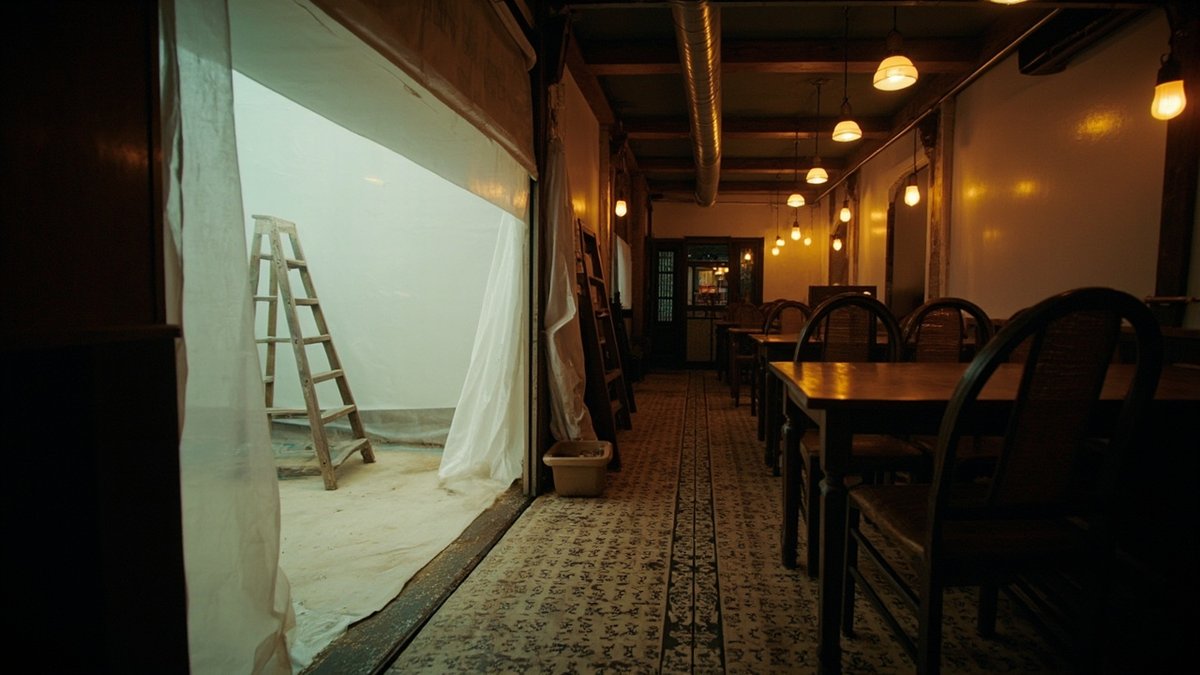

Need to renovate but cannot afford to close? Plan which work runs around trading, which runs at night, and what needs a short closure.

A shop or restaurant can usually be renovated without closing by splitting the work into zones and moving the noisy, dusty and customer-facing parts to nights or the quietest trading days. Finishes, lighting, seating areas and back-of-house can normally be phased; a kitchen exhaust, grease trap or floor across the cookline normally needs a short planned closure. Agree the phase plan, working hours and protection with the landlord or mall before starting, and expect phased or after-hours work to be quoted as its own line. A site visit is RM150, waived if you go ahead.
Rent, staff and regular customers do not stop while a renovation runs, so many owners want to keep the doors open. Phasing makes that possible, but it is not free: the job takes longer overall, the crew has to set up and clean up every day, and some items are simply safer and cheaper to do in one short closure. The right answer is often a mix — trade through most of the work and close for one or two planned days for the parts that cannot be done around customers.
Decide early which approach you are taking, because it changes the design, the order of works and the quotation.
| Approach | How it works | Suits |
|---|---|---|
| Zone phasing | One area closed and screened at a time while the rest trades | Larger shops, restaurants with separate dining areas |
| Night works | Work after closing; the shop is clean and set up before opening | Small units where there is no spare zone |
| Quiet-day blocks | Heavier work on the slowest trading days of the week | Cafes and shops with a clear weekly pattern |
| Short planned closure | One or two days closed for the items that cannot be phased | Kitchens, floors across the whole unit, shopfront changes |
Most successful projects combine two or three of these. ClickBina's guide to repainting with minimal downtime shows the zone-by-zone method for the painting part; the same logic applies to the rest of a renovation.
| Work item | While trading? | Notes |
|---|---|---|
| Painting and wall finishes | Yes, by zone or at night | Low-odour paint and ventilation while it dries |
| Lighting and ceiling changes | Usually at night | Needs scaffolds or ladders over the customer area |
| Seating, booths and display fixtures | Yes, by zone | Joinery can be built off site and installed quickly |
| Toilets | Yes, one at a time if there are two | Keep at least one toilet open for staff and customers |
| Floor finishes across the whole unit | Only in sections, or during a closure | Cure times decide when a section reopens |
| Kitchen exhaust, hood or ducting | Usually needs a kitchen closure | Cooking cannot continue without extraction |
| Grease trap or drainage | Usually needs a closure | Drainage out of use while pipes are opened |
| Shopfront replacement | At night, with a temporary secure closure | The unit must be lockable every morning |
Specialist items such as fire alarm, sprinkler or electrical changes follow the building's and the specialist's own rules on isolation and testing, which often means doing them outside trading hours.
Building work and food do not mix. Dust, debris and pests are the main risks, so a restaurant that keeps trading needs a clear separation between the works and anywhere food is stored, prepared or served. In practice that means:
Keep the hygiene standards your premises are inspected against in mind throughout; ClickBina's F&B maintenance schedule covers the routine cleaning and servicing that has to restart once the works finish.
On a shop floor the priorities are a safe customer route, protected stock and a unit that locks every night. Move stock out of the zone being worked on rather than covering it, keep aisles and exits clear, and screen the works area so customers cannot wander in. Any temporary opening in the shopfront or ceiling must be closed off before the crew leaves. Retail lighting changes are well suited to night work; ClickBina's retail lighting guide explains how the circuits and fittings are usually arranged.
Working at night avoids customers but brings its own arrangements:
Put the agreed working hours in the quotation rather than assuming night work is included.
Most landlords and every mall want to approve works before they start, even when the shop keeps trading. Expect to submit drawings or a method statement, follow permitted working hours, protect common areas, use hoarding or screens in front of the works, and follow hot-work and fire-detector procedures so dust or cutting does not set off the building's alarm. ClickBina's mall fit-out guide explains how a fit-out deposit is lost through damage, debris and working outside the permitted hours. Larger renovations of a shoplot may also need local council approval; check before the work starts rather than after.
| Phase | Work | Trading |
|---|---|---|
| 0. Preparation | Approvals, joinery made off site, materials delivered, phase plan shared with staff | Normal |
| 1. Back-of-house | Stockroom, office, staff areas and services that do not affect customers | Normal |
| 2. First customer zone | Half the dining area or sales floor screened and renovated | Reduced capacity |
| 3. Second customer zone | Other half renovated; first zone reopened | Reduced capacity |
| 4. Planned closure | Kitchen, floor across the entrance, shopfront or grease trap | Closed for the shortest possible time |
| 5. Night finishing | Lighting, touch-ups, signage and snagging after hours | Normal |
Leave a buffer at the end: phased jobs almost always uncover extra work behind fixtures once they are moved.
| Item | Indicative price | Source guide |
|---|---|---|
| Interior repaint, budget tier (KL) | RM2.20 – RM3.00 per sq ft | Minimal-downtime repainting guide |
| Interior repaint, mid-range tier (KL) | RM3.00 – RM4.50 per sq ft | Minimal-downtime repainting guide |
| Standard shop fit-out | RM80 – RM150 per sq ft | Mall fit-out guide |
| Simple / quick-service F&B fit-out | RM150 – RM220 per sq ft | Restaurant fit-out cost guide |
| Phasing and after-hours work | Priced on top, case by case | Minimal-downtime repainting guide |
WhatsApp us your job details for a quote — we reply within the hour.
💬 WhatsApp for a quoteKeeping a business open adds cost in predictable places: more phases mean more set-ups, protection and daily cleaning; night work is quoted differently from daytime work; joinery built off site costs more to plan but shortens the time on the shop floor; and mall charges or deposits sit outside the contractor's price. Set these against the income you keep by not closing.
WhatsApp us your job details for a quote. It helps to send:
ClickBina handles commercial renovation and fit-out works and coordinates the trades, including phasing the work around your trading hours and coordinating with specialists where fire, electrical or kitchen systems are involved. ClickBina is an experienced KL & Selangor contractor, we reply within the hour, and the price we agree is a flat price with no hidden charges. A site visit is RM150, waived if you go ahead.
Methodology: every RM figure is quoted unchanged from the ClickBina guides named above; they are indicative Klang Valley ranges for 2026, not a quotation. Phasing and after-hours premiums depend on the job and have no published figure.
