Timber & Laminate Floor Cupping Malaysia: Find the Moisture
🏠 Renovation🏢 Office Fit-Out🛍 Shop Fit-Out💦 Waterproofing❄ Aircon⚡ Electrical & Plumbing🔨 Carpentry🧹 Deep CleaningGuidesDesign IdeasToolsAbout🔍 SearchFree Quote
Waterproofing & Leak Repair

Timber & Laminate Floor Damage
Finding the Concealed Moisture First (2026)

A wood-based floor is a moisture gauge you walk on. Read the way it has deformed, find what is wetting it, dry the slab — and only then think about ordering boards.

📍 We serve KL, Selangor & Putrajaya.

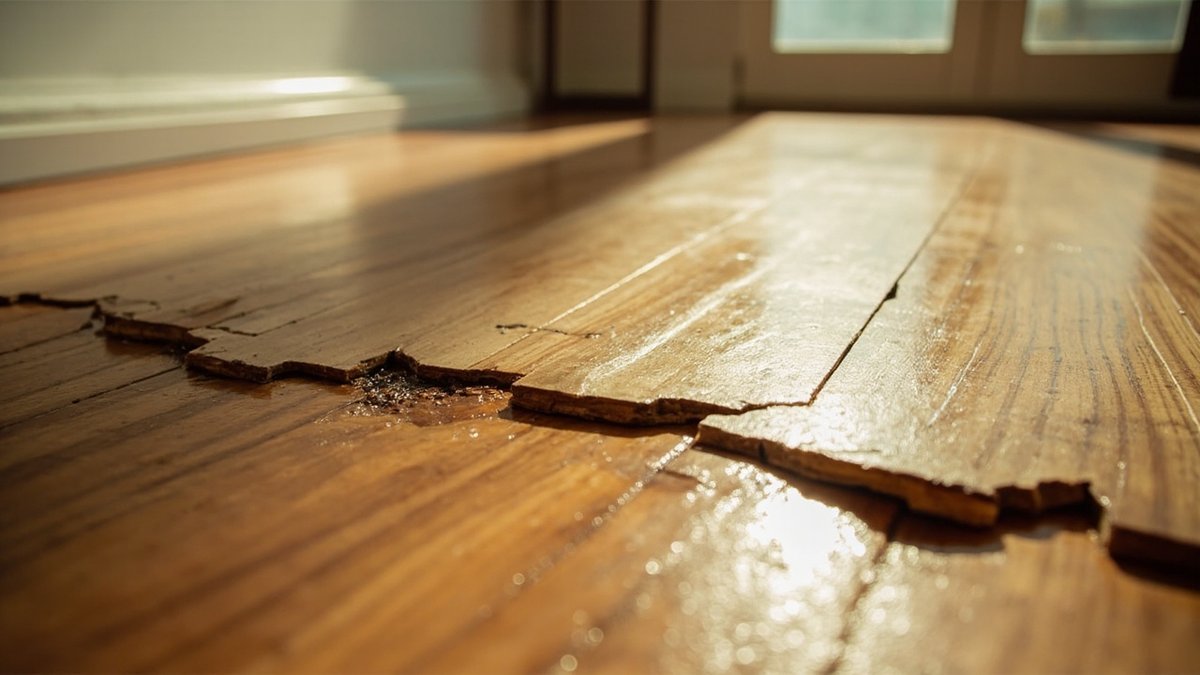

Timber flooring board cupping and cracking apart from moisture trapped underneath in a sunlit room
Cupped, tented or swollen timber and laminate flooring is almost always a moisture problem underneath it, and relaying the boards before the source is found simply buys the same damage again. Edges higher than the centre points to water from below; boards peaking at the joints points to swelling with nowhere to expand. Lift one board and tape plastic sheet to the slab for two days before you order anything. ClickBina leak detection is RM300 – RM800 per visit. WhatsApp ClickBina for a fixed quote.
📐 Free tool: Try our flooring & tiling calculator for an instant estimate — no sign-up needed.

Reading the damage — cupping, crowning, tenting, swelling

Wood-based flooring is a moisture gauge you happen to walk on. Every board moves with the water in it, and it moves more across its width than along its length, so the way a floor deforms tells you where the water came from before anyone lifts anything.

What you seeWhat it usually meansWhat to test next
Cupping — board edges higher than the middle, floor feels rippled underfootThe underside is wetter than the top. Moisture is coming from below or from the sidesPlastic sheet test on the slab; check what is behind the nearest wall
Crowning — middle higher than the edgesUsually a floor that cupped, was sanded flat while still wet, and then dried — or wetting from aboveAsk what happened before; check for a past spill or a past sanding
Tenting or peaking — boards lifting into a ridge at the jointsThe floor swelled and had nowhere to expand: no perimeter gap, or the gap was filled or pinned by skirtingRemove a section of skirting and look for the expansion gap
Edge swelling on laminate — joints raised, chipped and roughWater reached the fibreboard core through the joints. This damage is permanentWhere the water is arriving; whether the core is still swelling
Gapping — visible gaps opening between boardsThe floor is drying out and shrinking — often after the moisture source was fixed, or with heavy air conditioningWhether it is stable or still moving; re-measure in a month
Dark or black stainingProlonged wetting; possibly mould or tannin reaction with metal fixingsLift a board and look at the underside and the slab
Hollow or springy underfoot, no visible deformationAdhesive or underlay has debonded, usually because it got wetTap across the area and map the hollow zone
Musty smell with a floor that looks fineSomething is wet under it and has been for a whileLift a board in the smelliest corner

Get a free quote on WhatsApp

WhatsApp us your job details — we'll reply as soon as we can with a free quote.

💬 Get Your Free Quote
Free quoteFlat price, no hidden chargesExperienced KL & Selangor contractor

The single most useful of those is the cupping row, because it has a direction built into it. A board absorbs water on the wet face and that face expands more than the dry one, so the board curls away from the wet side. Edges up means the bottom is wet. It is not a proof, but it is the strongest free clue you will get.

Water from below, or a spill from above?

These two produce different damage and need completely different responses, and the distinction is worth settling before anything else.

From above — a spilled bucket, an overflowing washing machine, a pot boiled dry, an aquarium — hits the top surface first. The finish is affected: a solid timber floor shows a stain or a whitened patch in the lacquer; laminate shows damage that starts at the joint lines where the water went in. It is usually one event, the boundary of the damage is fairly sharp, and if the water is removed quickly the floor sometimes recovers.

From below — a leaking pipe under or in the slab, a wet area next door, a slab that was never dry, moisture rising through a ground-floor slab — wets the underside continuously. The finish on top may look almost untouched at first while the boards cup and the underlay rots. It gets worse rather than better, it recurs after any repair that did not address it, and it is the case where relaying the floor is money thrown away.

A quick reality check: pull up the skirting in the affected area and look at the wall base and the edge of the underlay. If the underlay is damp at the perimeter and the boards are cupped, you are dealing with moisture from below or from the side, whatever anybody says about the spill last year.

The shape of the wet area names the source

Map the damage on paper before you theorise about it. The outline is diagnostic.

  • A narrow stripe or a plume that widens away from one point follows a pipe run. Water leaving a pressurised pipe under a slab spreads outward from the break, and the shape usually points back at it.
  • Damage hugging one wall means the water is arriving from the other side of that wall — a bathroom, a yard, a wet kitchen, an external wall taking driven rain.
  • A broad, even, low-grade dampness across a whole room is a slab condition, not a leak: construction moisture in a new build, or a ground-floor slab with no working damp-proof membrane.
  • Worst at a doorway or a threshold means water is walking in — from a wet kitchen, a yard, a balcony or an entrance.
  • Worst directly under an air conditioning unit or along a chilled riser is condensation, and no amount of waterproofing will fix it.
  • A round patch in the middle of a room is almost always something that happened on top of the floor.

Combine the shape with the timing. Damage that worsens after heavy rain points outward, to an external wall or a balcony threshold. Damage that worsens after the neighbours shower points at the party wall. Damage that never varies at all, wet all year, points at a pipe or the slab itself.

The seven sources, in Malaysian order of likelihood

SourceTell-taleHow to confirm
Concealed supply pipe under or in the slabDamage in a plume; wet all year regardless of weather; sometimes a warm patch on a hot-water lineWater meter test with every tap closed — movement is conclusive
Adjoining wet area — bathroom, yard, wet kitchenDamage hugs the shared wall; worsens with use of that roomStop using that room for two days and watch; ponding test in the wet area
Slab never dry — new build or a fresh screedBroad, even, low-grade damp across the whole room; unit handed over recentlyPlastic sheet test in several places; a relative-humidity probe in the slab
No damp-proof membrane under a ground-floor slabGround floor only; worse in the wet season; salting at the skirting lineCompare against an upper floor; see our rising damp guide
Condensation on a cold slab or under air conditioningWorst under the aircon, along a cold riser, or against an external wall; seasonalPlastic sheet test — water forms on TOP of the sheet, not under it
Water walking in at a thresholdWorst at a doorway to a yard, wet kitchen, balcony or entranceTip a bucket at the threshold and watch which way it runs
Appliance or fitting — washing machine hose, fridge water line, water filterLocalised, near the appliance, may be intermittentPull the appliance out and look behind it; check every connection

Work down that table in order and most floors are diagnosed on the first two rows. If the water meter moves, stop — you have a supply leak and concealed pipe leak detection is the right page. If the answer is the wet room next door, bathroom waterproofing and wet kitchen floor waterproofing cover the repair.

The tests you can run before anyone quotes

  1. The water meter test. Close every tap, note the meter, wait an hour without using water, read again. Movement means a pressurised leak somewhere in the unit — the cheapest and most decisive test on this list. Our guide to a high water bill and a concealed pipe leak walks through the full isolation sequence.
  2. The plastic sheet test. Lift one board in the affected area — a spare or a damaged one, in a corner if possible. Tape a square of clear plastic sheet tightly to the exposed slab on all four edges and leave it for at least two days. Condensation on the underside, against the slab, means moisture is coming out of the structure. Condensation on the top means room air is condensing on a cold surface, which is a ventilation and insulation problem instead.
  3. The reference comparison. Whatever you measure, measure it twice: once in the damaged area and once in a part of the same floor that is clearly fine. A moisture meter reading on its own means very little; the same meter reading much higher in one zone than another is real evidence. Compare the number your flooring manufacturer states as its limit rather than any figure a contractor quotes at you.
  4. Isolate the neighbours. Where a shared wall is the suspect, agree with the household on the other side to stop using that room for two days, then check whether the damage stops advancing. Crude, free, and often conclusive.
  5. The threshold bucket test. Tip a bucket at every doorway into the room and watch which way the water runs.
  6. Photograph and wait. Take dated photographs with a ruler in shot, then repeat in two weeks. A floor that is still deforming has a live source. A floor that has stabilised may simply be waiting to be relaid.

Where those come back inconclusive and the floor keeps moving, that is the point at which a detection visit earns its fee — acoustic listening, thermal imaging and pressure testing applied to the same logic. Water leak detection explains what happens on the visit.

When it is condensation and not a leak at all

This is the diagnosis most often missed, and it is expensive to miss because the repair people buy instead — waterproofing, injection, a new floor — does nothing.

Malaysian air is warm and holds a lot of water. Cool any surface below the dew point of that air and water condenses on it. A concrete slab kept cold by a floor above a car park, an air-conditioned room over an unconditioned one, a chilled water riser passing through a floor, or an air conditioning unit blowing directly down onto a section of floor will all produce a persistently damp patch with no leak anywhere.

The plastic sheet test settles it in two days: water above the sheet is condensation, water below it is moisture from the structure. The fix is thermal and ventilation work — insulating the cold surface, redirecting the air flow, improving ventilation, running a dehumidifier — not a membrane. Condensation versus water seepage is the full comparison, and air conditioning water dripping covers the case where a unit is the actual source.

The ground-floor and new-build slab case

Two situations produce broad, even dampness with no leak to find.

A new build or a fresh screed. Concrete and screed are placed wet and give that water up slowly. Lay a moisture-sensitive floor covering over a slab that has not finished drying and the moisture has nowhere to go but into the flooring. This is why flooring manufacturers specify a moisture limit for the substrate and why the honest answer in a newly handed-over unit is sometimes “wait, and measure again”. It is the same construction moisture that produces efflorescence on new condo walls.

A ground-floor slab with no working damp-proof membrane. Older landed housing frequently has no membrane under the slab, or has one that was punctured during construction. Ground moisture then moves up through the slab continuously. The signs are a ground floor only problem, worse in the wet season, often with salting at the skirting line — and the diagnosis and retrofit belong to rising damp, which this page deliberately does not duplicate.

In both cases the options are the same three: wait for it to dry and measure before laying anything; apply a surface damp-proof or moisture-suppression system to the slab before the new floor goes down; or choose a floor covering that tolerates the conditions. Flooring types in Malaysia compares those options, and vinyl flooring cost and parquet flooring cost cover two of the common replacements.

Stop the water, then dry the slab

The sequence is not negotiable, and every step skipped comes back.

Stop the source. Whatever the table above pointed at — the pipe, the wet room next door, the threshold, the appliance — that repair happens first. Laying new flooring over a live source is the single most common expensive mistake in this whole subject.

Open the floor up. Lift the damaged boards and the underlay in the affected area. Wet underlay is a wick and it will keep the slab damp indefinitely; it also holds the smell. Get it out.

Dry the slab, then confirm it. Ventilate, move air across it with fans, and use a dehumidifier in a closed room if you have one. A concrete slab gives up water slowly, and the drying period is measured in weeks rather than days — longer where the slab is thick, where the water was in it for a long time, or where the room cannot be ventilated. Do not accept a calendar as proof. Confirm with repeated measurements against a dry reference area, and against the moisture limit your new flooring’s manufacturer states.

Then relay. A floor laid onto a slab that measures dry, with a proper moisture barrier and a real perimeter expansion gap, is a floor that will not repeat this.

Relay, wait, or leave it — how to decide

SituationWhat to doWhy
Source still live, floor still movingFix the source. Do not order flooring yetNew boards laid over a live leak fail the same way, on the same schedule
Source fixed, boards mildly cupped, solid timberWait. Give it weeks and re-measureSolid timber often flattens substantially as it equalises; sanding it early causes crowning later
Source fixed, laminate with swollen jointsReplace the affected boards or the floorA swollen fibreboard core does not recover — the damage is permanent
Tenting with no expansion gap, boards otherwise soundCut a proper perimeter gap and re-lay the lifted sectionOften a fitting fault rather than a water fault, and much cheaper to correct
Hollow and springy, no deformationLift the area, check the slab, re-bond or re-layDebonded adhesive means water got in even if the boards look fine
Small isolated area, spare boards availablePatch it once the slab is dryCheapest option, and colour matching is easier with original stock
Widespread damage, no spare boards, discontinued rangePlan a full replacement, and pick a covering suited to the roomPatching a discontinued floor rarely looks acceptable across a whole room

If the room is one that will always be at risk — next to a wet kitchen, opening onto a yard, on a damp ground-floor slab — the replacement is the moment to reconsider the material rather than repeat it.

What the diagnosis costs

The floor itself is a flooring cost and it varies enormously by material, so it is priced on our flooring guides rather than here. What we can price is finding the water and fixing the wet-area sources it usually comes from. These are ClickBina’s own published prices:

ClickBina serviceClickBina priceWhat it covers
Leak detection & assessmentRM300 – RM800 per visitcharged separately from the repair
PU injection — leaking bathroom ceilingfrom RM850one bathroom ceiling, includes the injection points
Bathroom re-waterproofing (non-hacking)RM1,500 – RM3,500 per bathroomexisting tiles stay; coating over the screed
Bathroom re-waterproofing (hack & retile)RM4,500 – RM9,000 per bathroomtiles off, new membrane, retiled

The detection line is the one that decides everything downstream. A floor is an expensive thing to lay twice, and the gap between “we replaced the flooring” and “we replaced the flooring and it happened again” is exactly one afternoon of testing.

Where the fix turns out to be waterproofing the wet room next door rather than a pipe, the membrane is priced per square foot (market estimate 2026, indicative Klang Valley), shown here against a 40 square foot floor:

SystemMarket range (2026, Klang Valley)40 sq ft floor
Cementitious slurryRM6 – RM10 per sq ftRM240 – RM400
Flexible two-part membraneRM8 – RM14 per sq ftRM320 – RM560
Liquid PU membraneRM10 – RM18 per sq ftRM400 – RM720

For the flooring replacement itself, see flooring types, vinyl flooring cost and parquet flooring cost. The full waterproofing menu is on waterproofing services.

What the quote must itemise, and what to ask

Be suspicious of any quote that goes straight to flooring. A repair quote for this problem should state: the moisture source the contractor believes is responsible and the evidence for it; the repair to that source, itemised separately from the flooring; the area of flooring and underlay being removed and disposed of; the drying method and the expected drying period; how substrate dryness will be verified before laying, and against what limit; whether a moisture barrier or damp-proof membrane is being applied to the slab; the new floor covering, underlay and perimeter expansion gap; skirting removal and reinstatement; and making good.

Then ask: What is the source, and what test showed you that? How will you prove the slab is dry before you lay anything — and what happens if it is not dry on the day you planned to start? Is the source repair on this quote, or a separate one? What perimeter gap are you leaving, and how will the skirting cover it without pinning the floor? If it cups again within the year, what is the process? A contractor who wants to lay a floor next week without answering the second question is quoting on your optimism. Questions to ask a waterproofing contractor covers the wider version.

Preventing the repeat

Most repeat failures come from four omissions, and all four are cheap at the time of laying.

A moisture barrier over the slab. On a ground floor, on a new build, or anywhere the slab has any history of damp, the barrier under the floor is not an upsell. A real perimeter expansion gap. Wood-based flooring moves; if it cannot move at the edges it moves upwards in the middle. Skirting should cover the gap, not clamp the floor into it. A hard threshold at every wet boundary. Where a timber or laminate floor meets a wet kitchen, a yard, a bathroom or a balcony, there should be a level change or a fall away from the opening, not a strip of trim over a continuous tile line — the threshold detail is covered on wet kitchen floor waterproofing. Appliance discipline. Washing machine hoses, fridge water lines and under-sink filters are the three fittings that quietly ruin floors; check the connections when you check the smoke alarm. Water filtration installation and the water pipe material guide cover the fittings side.

And keep the room ventilated. A closed, unconditioned room over a cool slab is the environment that turns a small moisture problem into a cupped floor and a musty smell.

Why ClickBina

ClickBina is called to cupped and tented floors across Kuala Lumpur and Selangor, and the first thing we do is refuse to quote the flooring. We run the meter test, lift a board, tape a sheet to the slab, map the shape of the damage and find out what is on the other side of the nearest wall — because the repair for a slab leak, a leaking bathroom next door, a condensing slab and a floor laid on a wet screed are four different jobs with four different prices. Once the source is fixed we dry the slab and measure it rather than guessing at a date, and only then lay anything. Detection is RM300 – RM800 per visit. Send photographs of the floor and of the room on the other side of the affected wall on WhatsApp.

Ready to price your leak repair job?

WhatsApp us your job details for a free quote — we'll reply as soon as we can.

💬 Get a Free Quote
Free quote on WhatsAppFlat price, no hidden chargesExperienced KL & Selangor contractor

Sources & methodology

How we estimated prices: where this guide gives renovation or service price ranges, those RM figures are typical Klang Valley market ranges for 2026, compiled from contractor quotations and supplier price lists. They are not official or fixed rates — the final price depends on your site, so confirm it on site before you commit. Statutory fees, fines, tax rates and tribunal limits come from the law or official body concerned, not from market quotes.

Common Questions

Why is my laminate floor cupping or lifting at the joints?
Cupping — edges higher than the middle — means the underside of the boards is wetter than the top, so moisture is arriving from below or from the side. Lifting or peaking at the joints usually means the floor swelled and had nowhere to expand, because there is no perimeter expansion gap or the skirting is pinning the boards down. The two often occur together: water swells the floor, and a missing expansion gap turns that swelling into a ridge.
How do I find out where the moisture is coming from?
Three free tests, in order. Close every tap and watch the water meter for an hour — movement means a pressurised leak. Lift one board and tape clear plastic sheet tightly to the slab for two days: water under the sheet means moisture from the structure, water on top means condensation. Then map the shape of the damage — a plume points at a pipe, damage hugging one wall points at the room on the other side, and broad even damp across a whole room points at the slab itself.
Can a cupped timber floor flatten out again?
Solid timber often does, once the moisture source is fixed and the floor has equalised over a period of weeks. That is exactly why sanding a cupped floor flat too early is a mistake — when it finally dries it becomes crowned, with the middle of every board proud, and it needs sanding again. Laminate is different: once water reaches the fibreboard core the swelling at the joints is permanent and those boards need replacing.
Should I replace the flooring before or after fixing the leak?
After, always, and after the slab has been dried and measured. New boards laid over a live source fail the same way on the same schedule, and the second failure costs the same as the first. Fix the source, lift the wet underlay out, dry the slab with ventilation and air movement, then confirm it is dry against the moisture limit your new flooring’s manufacturer states before anything is laid.
How long does a wet concrete slab take to dry?
Longer than most people budget for. Concrete gives up water slowly, and the period runs in weeks rather than days — longer where the slab is thick, where it stayed wet for a long time, or where the room cannot be ventilated. Do not accept a fixed number of days as proof. The only honest test is measurement: repeated readings compared against a dry part of the same floor and against the limit stated by the flooring you are about to lay.
My floor is damp but there is no leak anywhere. What else could it be?
Condensation is the usual answer, and it is the most missed diagnosis in this whole subject. Malaysian air holds a lot of water, so any surface kept below the dew point — a slab over a car park, an air-conditioned room over an unconditioned one, a floor under an air conditioner blowing straight down, a chilled riser — will collect water with no leak involved. The plastic sheet test separates the two in two days: water on top of the sheet is condensation, water underneath is coming out of the structure.
How much does it cost to find the moisture under a floor?
ClickBina prices leak detection and assessment at RM300 – RM800 per visit. If the source turns out to be the wet room next door, re-waterproofing runs RM1,500 – RM3,500 per bathroom without hacking or RM4,500 – RM9,000 per bathroom hacked and retiled. The flooring replacement is a separate budget and depends entirely on the material — our flooring guides cover that side.
Can I stop this happening to the replacement floor?
Largely, yes, and it is cheap at the time of laying. Put a moisture barrier over the slab on any ground floor, any new build and anywhere with a history of damp. Leave a genuine perimeter expansion gap and let the skirting cover it rather than clamp the floor. Make a hard threshold — a level change or a fall away from the opening — wherever the floor meets a wet kitchen, yard, bathroom or balcony. And check the washing machine hose, the fridge water line and the under-sink filter once a year.

Get a Free Quote

Tell us what you need — we'll reply as soon as we can.

WhatsApp ClickBina← All Guides
💬 Get Your Free Quote
